The City of Flint plans to resurface Court Street from Dort Highway to Crapo Street and install a new water main along this route.
The road and water main project was designed by Rowe Professional Services Company.
Spalding DeDecker is providing construction engineering for this project, which means we are observing the contractor's practices and ensuring the project is constructed per the design plan.
DiPonio Contracting is performing the construction work for this project.
The work was bid through the Michigan Department of Transportation (MDOT), with funding for the water main provided through WIIN Funding.
The Court Street renovation project will affect many residents and commuters as it is a major route through the City. Communication is a priority during this project. Residents and businesses will be able to sign up for direct email notifications for construction updates as the project progresses.
Stay on top of construction in your neighborhood with email updates
Know when and where we will be working so you can plan your daily commute.
The construction crews are currently waiting for the concrete to cure from last week's structure adjustments. Pavement markings are scheduled to be placed later this week.
Eastbound traffic will be detoured easterly along Lapeer Rd and northerly along Dort Hwy. The detour is expected to be removed later in the week. We expect the road to be open by the end of the week.
Stay tuned for further updates.
Phase 1 Detour Starts Next Monday
on Nov 19, 2021
+
Starting on Monday, November 22 the westbound and center lanes will be closed to perform structure adjustments. During this time, westbound traffic will still be open but it will be traveling along the eastbound lanes.
Eastbound traffic will be detoured to east on Lapeer Rd, north on Dort Hwy, and then back east to Court Street. This detour is expected to last 1 to 2 weeks until the work is completed and the concrete is cured. After that, the detour will be removed and all lanes will be opened. Soon after we expect pavement markings to be placed.
Stay tuned for further updates.
Tentative Schedule (Weather permitting)
Structure adjustments - next week
Repairs to sidewalks including ADA ramps and curbs - continues next week
As-needed restoration - continues next week
Lane Striping - late November / early December
Phase 1 Structure Adjustments and Detour
on Nov 12, 2021
+
The eastbound lane between Crapo and Dort is currently shut down while the concrete cures from the structure adjustments. This lane will continue to be shut down next week until the concrete is cured. However, both eastbound and westbound traffic will be maintained during this time. Westbound traffic is to be directed into the center lane.
Starting on Monday, November 22 the westbound and center lanes will be closed to perform structure adjustments. During this time, westbound traffic will still be open but it will be traveling along the eastbound lanes.
Eastbound traffic will be detoured to east on Lapeer Rd, north on Dort Hwy, and then back east to Court Street. This detour is expected to last 1 to 2 weeks until the work is completed and the concrete is cured. After that, the detour will be removed and all lanes will be opened. Soon after we expect pavement markings to be placed.
Stay tuned for further updates.
Tentative Schedule (Weather permitting)
Structure adjustments - next week
Repairs to sidewalks including ADA ramps and curbs - continue next week
As-needed restoration - continues next week
Lane Striping - late November / early December
Phase 1 Pavement Coming This Week
on Nov 08, 2021
+
Phase 1 Construction on East Court Street
The top course of HMA (asphalt) will be placed on East Court Street from Crapo St. to Dort Hwy beginning next week (Monday through Wednesday). During this time, expect single-lane closures and traffic delays as the final layer of pavement is being placed.
Tentative Schedule (Weather permitting)
Laying the top course of Hot Mix Asphalt (HMA) - 11/8 through 11/10
Structure adjustments - as early as next week
Repairs to sidewalks including ADA ramps and curbs - as early as next week
As-needed restoration - continues next week
Lane Striping - late November / early December
More updates will come as the schedule is finalized with the contractor. The contractor anticipates all the work to be complete by the end of the year.
Phase 1 Construction Has Resumed
on Oct 29, 2021
+
Phase 1 construction on East Court Street has resumed.
The contractor was on site today performing saw cutting on the road. Paving of the top layer of asphalt is scheduled to start as soon as next week. Expect single lanes closures during that time. More information to follow.Here is what to expect in the coming weeks.Tentative Schedule (Weather of permitting)
Saw cuts - 10/27- 10/28
Milling of the road and pavement repairs - 10/29
Concrete removal, grading, prepping - 10/30
Laying the top course of Hot Mix Asphalt (HMA) - As Early As Next week
Structure adjustments - As Early As Next Week
Repairs to sidewalks including ADA ramps and curbs -As Early As Next Week
As-needed restoration - Next week 11/1-11/5
Lane Striping - Late November/ Early December
More updates will come as the schedule is finalized with the contractor. The contractor anticipates all the work to be completed by the end of the year. Stay tuned for more information.
Water Main Break
on Sep 24, 2021
+
A water main break occurred on Monday (9/20/2021) at approximately 4:00PM. The City of Flint’s Water Department was immediately on site to shut down the main and detour traffic. The City of Flint began making repairs to the water main on Tuesday (9/21/2021) and it is now in service. Please contact the City Water Department for any questions regarding the water. Repairs to the road will begin soon.
Letter from the City of Flint
on Aug 10, 2021
+
August 10, 2021
College Cultural Center Area Residents:
Due to the water main break that occurred in front of 2113 East Court Street late Friday night, August 6, 2021, the City of Flint performed Bacti-sampling to check the water quality in the area. The results of these samples were negative for bacteria, ensuring that the water is safe for consumption. A boil water advisory was not necessary.
Sincerely,
The City of Flint Water Department
Water Main Break
on Aug 08, 2021
+
Friday night at approximately 10:00 PM, there was another water main break that occurred on Court Street. The break occurred near Vernon Road. The City of Flint Water Department promptly responded and was on site around 11:00 PM to throttle the main down and minimize damage.
The City and SD coordinated with the contractor DiPonio Contracting to fix the main. DiPonio Contracting was on site Saturday morning to dig up the water main and repair it. After they make the repair, they will then backfill the hole and place temporary gravel on the road so it can be reponed to traffic. Damages to the road, sidewalk, curb, and restoration will then be addressed at later date.
The City of Flint Water Department has advised us that they have maintained positive pressure on the water main. They have informed us that there should not be a boil water advisory at this time. Inquire with the City of Flint’s water department if you have any questions.
Phase 2 Paving // Video Update
on Jul 23, 2021
+

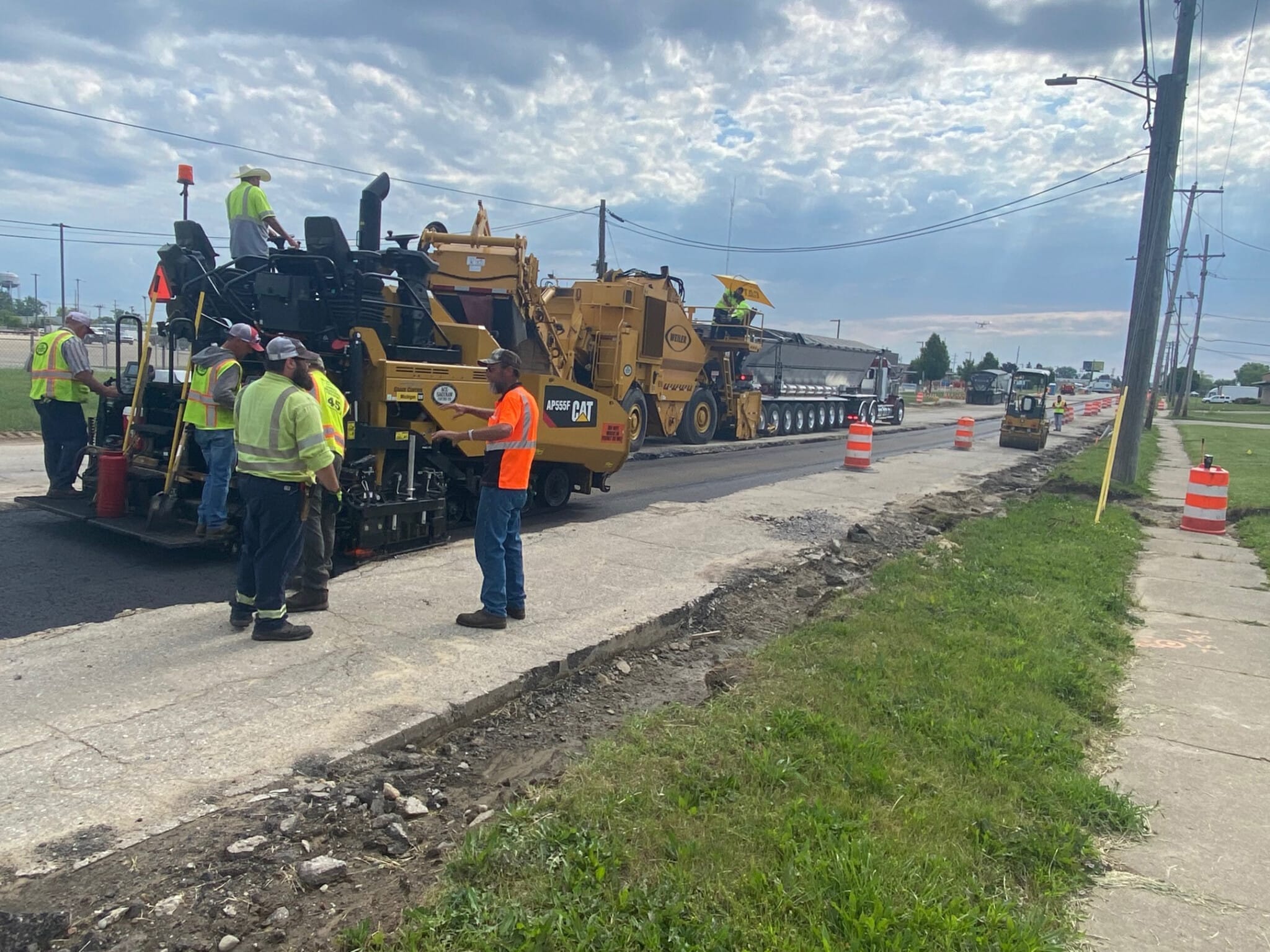

Phase 2 Paving Completed // East Court St. Rehabilitation from Spalding DeDecker on Vimeo.
The final layer of asphalt is complete east of Dort Highway. Construction to raise the sewer and water structure rims to match the pavement will begin next week. One week after that work is complete, the road will open to two-way traffic. Permanent pavement markings and signs should be placed while East Court Street remains closed next week. However, this work can be performed without the need to have the road completely closed.
City of Flint Letter
on Jul 16, 2021
+
Watermain Break
on Jul 11, 2021
+
At 3:40 am, the City was notified of a water main break along East Court Street at the Maxine Street intersection. Within one hour, the City's Water Department was on site shutting down the water main valves to mitigate further damage. Due to the size of the main, the City is providing positive water pressure on the main, which will appear as a continuous flow of water along the curb line until the water main repair is complete. Spalding DeDecker (SD) and the City contacted the Contractor, DiPonio Contracting, immediately to begin repair of this area. The Contractor will be on site Monday (7/12/2021) morning to begin the repair. In the interim, the City, along with SD, will be setting up barricades, barrels, cones, and caution tape to temporarily limit access to the affected areas. We are aware that MDOT is using this stretch of Court Street as a detour route for Lapeer Road. We have contacted MDOT to notify them that the Lapeer Road Detour Route will need to be modified.
The Contractor will make the repairs to the water main, as well as repairs to all affected sections of roadway, base, curb and gutter, and sidewalk, etc. at no cost to the City. SD, along with the City, will continue to ensure that these repairs are made appropriately and as timely as possible. We understand the inconvenience and frustration these events cause and will continue to work in concert with the City to mitigate this issue with the Contractor.
Phase 1- New Sidewalks | Phase 2- Paving Starts July 12th
on Jul 09, 2021
+
Phase 2 (east of Dort Hwy.)
Construction crews completed milling the asphalt in preparation for paving.
Repairs to the road have been completed. Construction crews plan to pave the first layer of asphalt on Monday, July 12 (Weather permitting).
Once completed, crews will repair any damage to landscaping and lay in new topsoil, and seed the easements between sidewalks. Additionally, crews are expected to complete the ADA sidewalk crossings next week.
Phase 1 (west of Dort Hwy.)
The new ADA sidewalk crossings near Mott Community College, including East Fork Rd, Goreman Ave, and Albert R. Horrigan Dr are expected to be completed next week. The contractor will be repairing portions of the road that were damaged by the water main breaks.
Phase 1 Progress // Phase 2 Milling
on Jul 02, 2021
+
Phase 1 (west of Dort Hwy.)
Construction crews are working on sidewalks, curbs, and gutters. They are also repairing portions of the road that were damaged by water main breaks. The contractor will place the final layer of asphalt on the road after the 4th of July weekend.
Phase 2 (east of Dort Hwy.)
Crews have started to mill the old layer of asphalt in preparation for paving the road.
Construction crews will be taking a break over the holiday weekend. Work will continue Tuesday morning. Enjoy your 4th of July Weekend.
Phase 2 Progress // Phase 1 New Sidewalk Crossings
on Jun 25, 2021
+
Phase 2 (east of Dort Highway)
EASTBOUND ONLY traffic will be maintained east of Dort Highway. Placement of concrete driveways and sidewalks in Phase 2 will continue throughout the week. Next week, the road pavement will be pulverized (milled) east of Dort Highway.
Phase 1 (west of Dort Highway)
The water main has been repaired. Repairs to the road damaged by the water main break are ongoing.
New Sidewalk Crossings
Construction of new sidewalk crossings at Mott College has begun. Curbing has been removed at the proposed sidewalk ramp locations. Sidewalk ramps will be placed after the road paving is complete.
Gorman Avenue is closed until Friday, July 2. It will be open for the 4th of July weekend.
Water Main Break
on Jun 16, 2021
+
On Wednesday, June 16th, there was a water main break within the project limits on Court Street near Lafayette Street. The Contractor and the City of Flint Water Department mobilized to the area immediately to close off the street and make the necessary repairs. The water main break caused damage to the newly repaved road, curb, and gutter, and restoration that will be addressed by the Contractor immediately.
Spalding DeDecker's role, being employed directly by the City, is to collect project information in accordance with State and Federal regulations as well as manage pay estimates and contract modifications.
The City of Flint and Spalding DeDecker are committed to ensuring that this project is completed to the standard required in the contract at the contract price. As we work with the Contractor through these repairs there will regrettably be additional disruption, but we will work with all parties to expedite the process and to minimize inconvenience as much as possible.
For more information, please contact us directly at
courtstreetupdates@sda-eng.com
Curb and Gutter Installed
on Jun 11, 2021
+
Phase 2 Construction
Next week, the contractor will continue removing driveways, sidewalks, curbs, and gutters. Access to businesses will be maintained. Crews will continue to grade the road to prepare for paving.
Phase 1 Construction
Crews have started to sawcut portions of damaged pavement in preparation for reconstruction. More updates to follow shortly.
Paving Starts Next Week
on Jun 04, 2021
+
Phase 2 Construction
Water main construction will be finished by the end of this week. Road work will begin after water main construction is complete.
Next week, the contractor will remove driveways, sidewalks, curbs, and gutters which will be replaced during construction. Access to businesses will be maintained.
Phase 1 Construction
We expect paving west of Dort Hwy. to begin within the next two weeks. Paving will run concurrently with Phase 2. More updates to follow shortly.
Phase 1 and 2 Paving
on May 28, 2021
+
Phase 2 Construction
The contractor is removing sidewalks, curbs, and driveways, and will begin paving soon.
Phase 1 Construction
Road construction will begin after Memorial Day. We expect paving west of Dort Hwy. to begin within the next two weeks. Paving will run concurrently with Phase 2. More updates to follow shortly.There will be no construction work Memorial Day weekend. Construction will resume Tuesday morning. Enjoy your weekend!
Watermain Installation Continues
on May 03, 2021
+
Phase 2 Construction
East Court Street is open to local business traffic only.
The contractor is continuing the installation of the new water main on East Court Street. They are currently near Averill Street. This week, the contractor will remove sidewalks, curbs, and driveways in anticipation of replacement. Most of the work will take place between Dort Hwy. and the CSX Railroad crossing.
Reminder
ALL LOCAL BUSINESSES ARE OPEN WITHIN THE CONSTRUCTION ZONE.
One-way eastbound traffic from Dort Hwy. to Center Rd. is open to local business traffic only via the northernmost lane. All other traffic should follow the recommended detour.
Phase 1 Construction
The contractor expects to start working on phase 1 within the next few weeks based upon subcontractor scheduling.
East Court Street is open to local business traffic only.
Construction has begun for the installation of the new water main, storm sewer, and pavement replacement. The water main will be installed from Arvil Road to Center Road. Next week, the contractor will remove sidewalks, curb, and driveways in anticipation of replacement. Most of the work will take place between Dort Hwy. and the CSX Railroad crossing.
Reminder
ALL LOCAL BUSINESSES ARE OPEN IN THE CONSTRUCTION ZONE.
One-way eastbound traffic from Dort Hwy. to Center Rd. is open to local businesses via the most northern lane. All other traffic should follow the recommended detour.
Phase 1 Construction
Construction from Crapo to Dort Hwy. will continue soon. Details will be in upcoming emails.
Communication is Key
The Court Street reconstruction project will affect many residents and commuters as it is a major route through the City. Communication is a priority during this project. Residents and businesses are encouraged to sign up via Spalding DeDecker’s website for direct email notifications for construction updates. Please share with your contacts who may still need to sign up.
Neighborhood Detour Route
on Apr 20, 2021
+
Phase 2 Construction Starting April 12th
on Apr 07, 2021
+
Phase 2 Construction Starts Monday
Phase 2 work will begin 4/12/21. This includes work on E. Court St. between Dort Hwy. and S. Center Road. East Court Street will be open to local business traffic only. Other motorists should use the posted detour routes utilizing Lapeer Road. Please reference the detour graphic below.
For residents in the neighborhoods impacted by the construction, use Brimfield Dr. to enter/exit the subdivision from S. Averill Ave. or use Foxcroft Lane to enter/exit the subdivision from S. Center Road.
Phase 1 Cleanup Starts Soon
The contractor will place the top and final layer of pavement on Court street west of Dort Highway. After the top layer of asphalt is placed, the contractor will install permanent pavement markings and signs. They will also add or replace any necessary sidewalks, ramps, and curbs.
Communication is Key
The Court Street reconstruction project will affect many residents and commuters as it is a major route through the City. Communication is a priority during this project. Residents and businesses are encouraged to sign up via Spalding DeDecker’s website for direct email notifications for construction updates. Click the link here to sign up
Work on Phase 1 will continue next spring. The contractor will place the top and final layer of pavement on Court street west of Dort Highway. After the top layer of asphalt is placed, the contractor will install permanent pavement markings and signs. They will also add or replace any necessary sidewalks, ramps, and curbs. Phase 2 work will also begin in the spring, which includes work on Court St., east of Dort Hwy. Phase 2 is expected to be done next fall.
We have received comments about some of the sidewalk crossings not being replaced. Due to pedestrian safety and ADA regulations, the City has adopted a policy on roads similar to Court St. to place sidewalk crossings only at intersections with a four-way stop or traffic signal. These crossings were installed per the approved design that we received in the contract. However, we are aware that there are some pedestrian crossings that are near traffic signals that may be added and we are in discussions with the City to see if this is a possibility. If the City approves, the additional pedestrian crossings near traffic signals will be added next spring.
We are aware that there are some manhole structures in the road that are high (above the current layer of pavement). Most of the manholes along Court Street have been temporarily lowered until the top layer of pavement is placed. However, there are a few manholes and valve box structures that could not physically be lowered. There are also some structures the City needs access to and could not be adjusted. Until the top layer of pavement is placed, the contractor has placed cold patch around these high structures to protect them from traffic and snow removal services. Once the top layer of pavement is installed, these structures will be flush with the top of pavement.
East Court Street Is Open!
on Dec 09, 2020
+
Some minimal work is being performed today, but the road will be open to traffic by the end of the day. The road is not completely finished. The contractor will be back next spring to place the final layer of pavement, and will take care of any other outstanding issues. The work on the east side of Dort Hwy. will also take place in the spring. We appreciate everyone's patience and understanding during the construction of East Court Street.
East Court Street To Open Next Week!
on Dec 02, 2020
+
The contractor is planning to have the road open to traffic by the beginning of next week. The road will be open to traffic in both directions. For the remainder of this week, the contractor will be performing restoration and installing pavement markings and signs.
Due to the cold weather, the final layer of asphalt will be placed in the spring. Waiting until spring will ensure that the new road will be a better product and provide a smoother ride.
Driveways are Open!
on Nov 24, 2020
+
The new concrete driveways on the south side of Court St. are available for use. The concrete is now cured, however, there is a 3-inch (+/-) temporary lip between the driveway and the eastbound lane. This lane will receive another lift of asphalt at a later date. In the meantime, residents can use their driveways if they feel comfortable driving over this lip at their discretion.
Due to the weather and other unforeseen complications, the final pavement of the road will be delayed for another week.
Enjoy your new driveway!
Paving Continues!
on Nov 13, 2020
+
Construction crews are continuing to work on removing the center and eastbound lanes of E. Court Street. The contractor is hoping to pave the eastbound lane and the center lane by Thanksgiving. Paving depends upon the weather.
The traffic has shifted to the newly paved lane and the traffic direction has remained the same. With the opening of the new westbound lane, we understand how exciting it is to drive on a newly paved road. We strongly encourage residents to continue to use the detour as long as possible. We encourage everyone to drive the construction zone speed limit of 25 mph as crews are working hard to finish the project.
Residents on the south side of Court Street will be receiving a new driveway within the next week or two. We will send out a notice before your old driveway is removed.
Drive Way Removals
on Nov 06, 2020
+
DiPonio Contracting will be installing new concrete curb and concrete driveways along the south side of Court Street. This process is expected to take up to 2 weeks (including the cure time for the concrete). During this time, we ask that you find another area to park outside of your driveway while the new concrete driveways are being installed. It is suggested to use the street parking on neighboring streets. We apologize for this temporary inconvenience, but we hope you enjoy your new driveways as we work together to finish the project.
Curb and driveway construction is expected to start Saturday, November 7, 2020 and last for approximately 2 weeks.
Intersections To Be Closed Temporarily For Paving
on Nov 05, 2020
+
Construction crews plan to pave the westbound and part of the center lane this Friday and Saturday (weather permitting). Intermittent intersections along the project will be temporarily closed while paving operations are underway. During this time, drivers are encouraged to use the current detour. Residents located on the south side of Court Street will still have access to their homes.
Road Paving and Making Progress
on Nov 03, 2020
+
With the new curb and driveways in place, construction crews are now placing the first layer of asphalt on East Court Street. Within the next few weeks, crews will be finishing up paving the west-bound lane and will begin removing the center and eastbound lane for repair and repaving. Residents should expect a traffic shift within the next week to travel the newly paved lane. The traffic direction and detour will remain the same.
Driveways Are Open!
on Oct 30, 2020
+
The new concrete driveways on the north side of Court St. are available for use. The concrete is now cured, however, there is a 3-inch (+/-) temporary lip between the driveway and the westbound lane. This lane will receive another lift of asphalt at a later date. In the meantime, residents can use their driveways if they feel comfortable driving over this lip at their discretion.
Starting This Week – Paving the Westbound Lane
on Oct 28, 2020
+
The contractor completed pouring new driveways for homes located on the north side of East Court Street. The new concrete driveways will need time to cure. Do not park in your driveway until you receive notice to do so. Please find another area to park your vehicles. It is suggested to use street parking on nearby streets.
Weather permitting, the westbound lane will be paved starting Thursday. On Saturday, the contractor will shut down around 3:30 for Halloween festivities. We appreciate everyone's patience.
Some Intersections Will Be Closed Along East Court Street
on Oct 23, 2020
+
For residents on the north side of East Court Street, the contractor will be closing some intersections along East Court Street to grade the road in preparation for concrete. Expect the intersections to be closed until Thursday 10/29, weather permitting. Residents should seek an alternative route, such as Robert T. Longway
The following E. Court Street intersections will be closed:
Maxine
Kensington
Blanchard
Greenfield
Meade
The City of Flint is a dynamic city in the middle of a renaissance. With new and growing businesses and a renewed emphasis on rebuilding aging infrastructure, the rehabilitation of East Court St. is one of the most important projects in the City.
For homes on the northside of East Court Street:
DiPonio Contracting will be installing new concrete curb and concrete driveways along the north side of Court Street. This process is expected to take up to 2 weeks (including the cure time for the concrete). During this time, we ask that you find another area to park outside of your driveway while the new concrete driveways are being installed. It is suggested to use the street parking on neighboring streets. We apologize for this temporary inconvenience, but we hope you enjoy your new driveways as we work together to finish the project.
The curb and driveway construction are expected to start Monday October 19, 2020 and last for approximately 2 weeks.
New Concrete Driveways
on Oct 14, 2020
+
[embed]https://vimeo.com/468522159[/embed]
DiPonio Contracting will be installing new concrete curb and concrete driveways along the north side of Court Street. This process is expected to take up to 2 weeks (including the cure time for the concrete). During this time, we ask that you find another area to park outside of your driveway while the new concrete driveways are being installed. It is suggested to use the street parking on neighboring streets. We apologize for this temporary inconvenience, but we hope you enjoy your new driveways as we work together to finish the project.
The curb and driveway construction are expected to start Monday October 19, 2020 and last for approximately 2 weeks.
Driveway Removals
on Sep 25, 2020
+
The contractor started removing old driveways along the north side of E. Court St between Mott Community College and Blanchard Avenue. Residents should expect a knock on their door from the contractor when workers are ready to remove the old driveways.
After driveways are removed, temporary gravel will be placed to allow access to homes until new concrete driveways are placed. New driveways will be placed within the next few weeks.
ALTERNATE DETOUR ROUTE FOR WESTBOUND E. COURT ST. ON SEPTEMBER 21
on Sep 18, 2020
+
Lapeer Road will be Closed at the Railroad Crossing on Monday for Emergency Repairs
Motorists using the westbound Court Street detour on Monday, 9/21, should take Dort Highway south, Lippincott Blvd. west, and Howard Ave. north to Lapeer Road. Continue westerly on Lapeer Road to E. Court Street.
Reminder: Traffic is only open to eastbound Court Street. Local traffic will have access to their driveways and intersecting roads by traveling eastbound only.
Water Has Been Restored
on Sep 16, 2020
+
Water has been restored to those in the affected area. Please refer to the City of Flint Water Department website for any drinking water notices and information. Contact Flint Water Department for more details.
There is a watermain break near Greenfield Avenue and Court Street. Water has been shut off to those in the affected area. The contractor is on site and should have the break fixed by mid-morning.
Please refer to the City of Flint Water Department website for any drinking water notices and information. Contact Flint Water Department for more details. Flint Water Department: (810) 766-7202 | Visit The City of Flint website
Watermain Break on Vernon Road and Court Street
on Sep 10, 2020
+
Watermain Break
There is watermain break near Vernon Road and Court Street. Streets are experiencing some flooding. Motorists should seek an alternate route for travel while the crew repairs the break.
Please refer to the City of Flint Water Department website for any drinking water notices and information. Contact Flint Water Department for more details.
Construction Has Resumed
on Sep 10, 2020
+
Construction crews are back on site replacing storm sewers along Court Street. The Contractor is starting at Crapo Street and proceeding easterly toward Dort Highway.
Update on the Delay of Construction
on Aug 26, 2020
+
Delay in Construction
During the construction of the road, it was determined that the existing storm sewer system below the road was in disrepair and would ultimately reduce the life of the new pavement. Our team discussed the storm sewer issue with the City and it was determined that the storm sewer should be replaced at this time.
The City Council approved the additional funds for the design and construction of the storm sewer and the Contractor was then able to order the materials. With COVID-19 and other delays, materials are taking longer to manufacture than normal. It is expected that the Contractor will be back on site mid to late next week to continue construction.
Traffic Control
We have requested that the contractor maintain the site and traffic control devices during this delay. We have also requested the City to increase police presence to keep traffic traveling the correct direction within the construction zone.
Thank you and we appreciate your patience and understanding during the construction.
Construction Halted for Two to Three Weeks
on Aug 18, 2020
+
Construction has been halted for two to three weeks while the contractor waits for additional materials for the reconstruction of storm sewers. We expect reconstruction of the storm sewers and road to begin within the next three weeks. Please stay tuned for more updates.
Watermain Connections and Water Disruptions
on Aug 04, 2020
+
Water main installation and home service connections will continue the next two to three weeks. Currently, work is occurring between Lafayette St. and Vernon Ave. and will continue eastward toward Dort Highway.
Periodic interruptions in water service will occur in the next few weeks. As directed by the Flint Water Department, water service may be shut down to entire blocks of homes for up to 12 hours. (7:00 am-7:00 pm).
Workers will wait as long as possible to shut the water off and will restore it as quickly as possible. They will also go door-to-door in the affected areas to alert residents of the water disruption. We apologize for any inconvenience.
The Flint Water Department is directing the location and schedule of water main service connections. Your patience is appreciated. We understand it is an inconvenience, but only temporarily. If you notice your water has been turned off, it is recommended by the Flint Water Department to run your bathtub faucet with COLD water for 10 minutes.
A temporary water service disruption is planned, August 5th, 2020
on Aug 05, 2020
+
A temporary water service disruption is planned for Wednesday, Aug. 5, 2020, for areas of two streets in the College and Cultural Neighborhood as work crews continue making much-needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The impacted area includes:
• Greenfield Avenue from East Court Street to Meade Street
• Windemere Avenue from Greenfield Avenue to Black Street
The water is expected to be shut off for the impacted areas at approximately 8 a.m. and be off for several hours. All times given are estimates the exact timing of the water service disruption change based on findings made by the crew while performing work.
Workers will wait as long as possible to shut off water and will restore it as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption. We apologize for any inconvenience
Temporary water service disruption planned for one block of Franklin Avenue
on Jul 29, 2020
+
A temporary water service disruption is planned for Wednesday, July 28, 2020 for one block of Franklin Avenue and one block of East Court Street area in the College and Cultural Neighborhood as work crews continue making much needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The impacted area includes:
Franklin Avenue between East Court Street and Calumet Street
East Court Street near Franklin Avenue
The water is expected to be shut off for the impacted areas at approximately 8 a.m. and be off for several hours. All times given are estimates the exact timing of the water service disruption change based on findings made by the crew while performing work.
Workers will wait as long as possible to shut off water and will restore it as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption. We apologize for any inconvenience.
Temporary water service disruption planned for Tuesday, July 28, 2020
on Jul 28, 2020
+
A temporary water service disruption is planned for Tuesday, July 28, 2020, along Franklin Avenue between East Court Street and Montclair Avenue in the College and Cultural Neighborhood as work crews continue making much-needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The impacted area includes the following area:
• Franklin Avenue between East Court St. and Montclair Ave
Windermere Avenue from Meade Street to Greenfield Avenue
• Meade Street from Windermere Avenue to East Court Street
The water is expected to be shut off for the impacted areas at approximately 8 a.m. and be off for approximately four hours. All times given are estimates the exact timing of the water service disruption change based on findings made by the crew while performing work.
Workers will wait as long as possible to shut off water and will restore it as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption. We apologize for any inconvenience.
Temporary water service disruption planned for Monday, July 27, 2020
on Jul 27, 2020
+
A temporary water service disruption is planned for Monday, July 27, 2020 for three streets in the East Court Street area in the College and Cultural Neighborhood as work crews continue making much needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The impacted area includes the block bordered by:
East Court between Lafayette Street and Vernon Avenue
Lafayette Street between East Court and Calumet Streets
Vernon Avenue between East Court and Calumet Streets
Franklin Avenue between East Court St. and Montclair Ave.
The water is expected to be shut off for the impacted areas at approximately 8 a.m. and be off for approximately four hours. All times given are estimates the exact timing of the water service disruption change based on findings made by the crew while performing work.
Workers will wait as long as possible to shut off water and will restore it as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption. We apologize for any inconvenience.
Water Service Disruption
on Jul 21, 2020
+
A temporary water service disruption is planned for Tuesday and Wednesday (July 21-22, 2020) for a one block area of three streets in the College and Cultural Neighborhood as work crews continue making much needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The impacted area includes:
• Maxine Street between East Court Street and Calumet Street,
• Blanchard Avenue between East Court Street and Calumet Street, and
• East Court Street between Maxine Street and Blanchard Avenue.
The water is expected to be shut off for the impacted areas at approximately 10 a.m. both days and be off for approximately four hours both days. All times given are estimates the exact timing of the water service disruption change based on findings made by the crew while performing work.
Workers will wait as long as possible to shut off water and will restore it as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption.
We apologize for any inconvenience.
Residents with questions or concerns should contact the
City of Flint Water Service Center at (810) 766-7202.
Temporary water service disruption planned for Kensington Avenue
on Jul 20, 2020
+
A temporary water service disruption is planned for Monday, July 20, 2020, for Kensington Avenue from East Court Street to Calumet Street as work crews continue making much-needed repairs to the city infrastructure.
The water will be shut off for additional work on the water line in the area as part of the East Court Street Rehabilitation Project. The water service for the one block portion of Kensington Avenue south of Court Street is expected to be temporarily shut off as early as 7:30 a.m. — but it could be later depending on excavation findings.
It is estimated the shut off will last for approximately 6 hours. The exact amount of time water service will be disrupted could be longer or shorter depending on findings made by the crew performing work. Workers will wait as long as possible to shut off water and restore it to households as quickly as possible. They also are going door-to-door in the affected area to alert residents of the water disruption.
We apologize for any inconvenience.
Residents with questions or concerns about the water service disruption should contact the City of Flint Water Service Center at (810) 766-7202.
Water Main Break Information
on Jul 13, 2020
+
Unfortunately, there was a water main break over the weekend. The contractor is currently fixing the leak and any associated damage at their own cost.
This week, construction crews will continue to connect homes to the new water main. As part of that work, residents will see a short-term disruption in their water service. Residents can expect a 30-minute to 1-hour disruption to their water service while their home is being connected.
Once the home has been connected, expect a knock on the door from a City of Flint or Spalding DeDecker representative. Residents should then flush their pipes with COLD WATER in the bathtub for 10 minutes. If a resident is not home, a City of Flint or Spalding DeDecker representative will flush the home's water system using the water spigot in the back yard.
New Water Service Line Connection
on Jul 06, 2020
+
Within the next two weeks, the contractor will connect individual homes to the new water main. Residents should expect a 30-minute to 1-hour disruption to their water service while their home is being connected.
Once the home has been connected, expect a knock on the door from a City of Flint or Spalding DeDecker representative.
Residents should then flush their pipes with COLD WATER in the bathtub for 10 minutes.
If a resident is not home, a City of Flint or Spalding DeDecker representative will flush the home's water system using the water spigot in the back yard.
CONSTRUCTION SHUT DOWN FOR HOLIDAY WEEKEND
on Jul 01, 2020
+
Construction will shut down at 3 pm on Thursday (7/2) and resume Monday (7/6) morning at 7 am.
From all of us at Spalding DeDecker, have a safe and wonderful holiday weekend.
Water Restored in the College and Cultural Neighborhood
on Jun 26, 2020
+
Posted on the City of Flint's website
6/26/2020
"Water service was temporarily disrupted to some households in the College and Cultural Neighborhood.
A contractor working on the East Court Street rehabilitation project broke a valve. Repair work required that water at the main be temporarily shut off. Service has since been restored and no further precautionary measures are needed, according to the City’s Department of Public Works.
Due to the pressure loss, there may be trapped air and loose sediment in your water lines. The air and sediment may be removed by flushing your water system. Do not flush your water through a water filter.
The East Court Street rehabilitation project is installing a new water main and resurfacing Court Street between Crapo Street and Dort Highway. Only eastbound traffic is allowed. Westbound traffic is being detoured using Robert T. Longway Boulevard."
For more information, please contact
The City of Flint Water Department at (810) 766-7202.
From The Field // East Court Street Rehabilitation
The City of Flint water system lost pressure and contamination may have occurred
BOIL ALL WATER BEFORE USING
Due to construction and a loss of pressure in the City of Flint water supply, bacterial contamination may have occurred in the water system on June 22, 2020. Bacteria is generally not harmful and is common throughout our environment. Corrective measures are currently taking place to correct the situation.
What should I do?
AS A PRECAUTION, PLEASE BOIL ALL TAP WATER BEFORE YOU DRINK IT.
As a precaution, boiled water or bottled water should be used for drinking, making ice, brushing teeth, washing dishes, and preparing food. Please follow these guidelines for tap water. Bring all FILTERED water to a boil, let it boil for one minute, and let it cool before using. If you are NOT currently using a filter to remove lead from your drinking water, run your faucet (flush the waterline) for AT LEAST 7 MINUTES before collecting any water to boil. Boiling kills bacteria and other organisms in the water.
Continue using boiled or bottled water until further notice.
Due to the pressure loss, there may be trapped air and loose sediment in your water lines. The air and sediment may be removed by flushing (running your faucet until the water runs clear and air pockets are released) your water system. DO NOT FLUSH YOUR SYSTEM THROUGH THE FILTER. The resulting air and sediment may affect the performance of your filter and the filter cartridge should be replaced after the boil water advisory is lifted.
What happened? What is being done?
These precautionary actions are being taken due to the loss of water pressure in the water distribution system for an extended period of time caused by new water main construction connections. Whenever a water system loses pressure for any significant length of time, precautionary measures are recommended. The 24” transmission main has been constructed, passed pressure testing and disinfection, and is now being connected to the existing water distribution system.
The affected areas are: E. Court St. from Kensington St. to Crapo St.; Beard St.; East Fork Dr.; Woodside Dr.; and Avon Street.
If you are located near the affected areas listed above and lose water service, you should follow the boil water advisory as well. Provided the samples pass, we expect the boil water notice to be lifted after 24 hours.
The City of Flint Water Department will be working in conjunction with Diponio Contracting to facilitate the work as quickly as possible to limit the disruption in service. Water staff will be taking other remedial actions such as flushing and collecting bacteriological samples from the system near the area of the disruption. The samples will be collected to determine that water quality meets the state drinking water standards. We will inform you when tests no longer show bacteria, and you no longer need to boil your water. This precautionary boil water notice shall remain in effect until results from the sampling verify the water is safe to drink. Customers will be advised when the boil water advisory has been lifted.
For more information, please contact
The City of Flint Water Department at (810) 766-7202.
General guidelines on ways to lessen the risk of infection by microbes are available from the EPA Safe Drinking Water Hotline at 1(800) 426-4791.
Please share this information with all the other people who drink this water, especially those who may not have received this notice directly (for example, people in apartments, nursing homes, schools, and businesses). You can do this by posting this notice in a public place or distributing copies by hand or mail
Water Service Restored | Boil Water Advisory
on Jun 22, 2020
+
Water service has been restored to the following affected areas:
East Court Street from Kensington St. to Crapo St.
Beard St., East Fork Dr., and Woodside Dr.
Avon Street
A boil water advisory is in effect for those areas until Wednesday 6/24.
You may experience some air in your pipes and lower than normal pressure for the next hour.
The City Water Department recommends running your COLD WATER for about 10 minutes. You may get some discoloration, but this is normal and should clear on its own.
Please call The City Water Department 810-766-7202 if you have any questions.
Refer to the official City of Flint Water Department letter for more information.
Water Service Disruption
on Jun 18, 2020
+
Dear Residents,
Please be advised there will be a DISRUPTION IN WATER SERVICE due to connecting the new water main to the existing water distribution system in the area mentioned below. We apologize for the inconvenience but it is necessary to facilitate the new water main project. The City of Flint Water Department will be TURNING OFF WATER on Monday, June 22, 2020 due to an ongoing water main project on Court Street.
Your water will be turned off at approximately 8:00 a.m. We anticipate that the water will be off at least 4 hours, but be advised that it could be longer. Due to the time frame, it is off we will be issuing a precautionary boil water notice for the affected area. Once bacteriological samples clear we will lift the boil water advisory. We anticipate the boil water advisory to last 24 hours but it could last longer.
The following areas will affected are:
► Court street from Kensington St. to Crapo St.
► Beard St., East Fork Dr. and Woodside Dr. will also be affected
► Avon street east of court street may experience low pressure
Please call 810-766-7202 if you have any questions regarding water restoration.
Again we apologize for any inconvenience caused by this disruption in service.
Official-Water-Notice-6-18-20
Planned Water Shut-Off Rescheduled
on Jun 16, 2020
+
The City has postponed a planned water service shut down and boil water advisory along East Court Street. Residents are encouraged to refer to the article below for more information.
Read more on Mlive.com
Water Shut-off Notice
on Jun 12, 2020
+
Project Progress
Construction crews are busy installing water main up to S. Vernon Avenue. Approximately 1800 ft of water main remains to be installed. The construction crews are on schedule, and we expect water main installation to be complete within the next two weeks.
Early next week, crews will be connecting the new water main to the City system. Residents around Mott College should expect their water to be shut off early in the morning. The work will last approximately 8 hours. For a short time, residents may experience bursts of air at the faucets once the water is turned back on. It is completely normal. Your patience is appreciated!
For more information, please call the City of Flint Water Service Center. (810) 766-7202
Utilizing a GIS System
All engineering design begins with a detailed map of current underground utility locations. For the E. Court Street Reconstruction project, design engineers created plans using historical data that dated upwards of 100 years ago. With system repairs and upgrades performed throughout the decades, historical location data was not always updated in the system, making it difficult to create accurate underground utility location maps. The only way to confirm the actual location of the old water main was to dig up the road.
Once the contractor installs the new water main, the pipe is then buried, making it once again difficult to find the newly installed pipes. To solve this issue, Spalding DeDecker uses a GPS System to map exactly where the new water main is installed. As the construction crews install the new water main, Spalding DeDecker's construction inspectors obtain GPS locations and elevations along the pipeline. The location and elevation information is sent directly to the City of Flint to update their GIS maps. Now, the City and our design team will always be able to refer to this map for accurate underground utility location. Additionally, these updates are live, so the City and engineers can see in real time what is being installed - saving time and funds for future road and water main improvements.
Limited Access to Court Street Driveways
on Jun 05, 2020
+
This week, crews finished laying the 24” water main and are beginning to place the 12” water main from Kensington Ave. to Dort Highway. The work will include trenching and pavement removal of the entire westbound lane on Court Street.
As a result, access to driveways on Court Street will occasionally be restricted. Residents can expect a knock on their door from the contractor to inform them when they will be trenching in front of their home. Some residents may need to remove their vehicles from their driveway and park down a side street until construction is complete. After the trench is backfilled, crews will bridge the gap, and residents will be able to access their driveway. This process can take up to a full workday.
If the homeowner is not home at the time, their driveway will not be accessible until the end of the workday. Everyone will have access to their driveways overnight. The contractor will not leave someone with a trench in front of their house and no access to their home.
Saturday Construction
on May 29, 2020
+
From old to new
This week, construction crews continued to install new fire hydrants and replace 110-year-old water main valves. Pictured below, the old 36" water valves date back to 1908-1910 that operated via a gear which opens and closes the water main from the side (3:00 to 9:00 position). The new water valves close from the top (12:00 to 6:00 position) and weigh approximately 2,100lbs. Each new valve comes with a structure, totaling over 6,500lbs
Saturday Construction Notification
Crews will be removing the road between Kensington and Dort Hwy. The expected work time is from 7 am til 5 pm.
110 Year-Old Makeover
on May 22, 2020
+
This week, construction crews made progress installing the water main in front of Mott Community College. More pipe is expected to be installed within the next few weeks. Additionally, construction crews started replacing the 110-year-old fire hydrants along East Court Street.
Construction is expected to halt at 3pm on Friday, May 22, and start again Tuesday morning, giving residents a much-needed break for Memorial Day. From all of us at Spalding DeDecker, have a safe and wonderful Memorial Day.
Water Main Installation
on May 15, 2020
+
The contractor is currently installing the water main near Mott Community College. Signage is effectively directing traffic and informing motorists to use the Dort Highway detour.
Working on Additional Signage
on May 08, 2020
+
Spalding DeDecker, the City of Flint, and MDOT worked together to revise the signage plans to help maintain safe traffic flow for the project. A work order was issued to the contractor on April 23 to add additional signage.
One-way signs were delivered on May 4th to illustrate the direction of eastbound traffic only along E. Court Street. The barricades were also moved to one side to make it easier for the traffic to maneuver around them.
The contractor placed barrels and barricades to close the left turn on North Dort Hwy to westbound E. Court Street. The left turn signal was covered to deter any motorist from turning the wrong way onto E. Court Street.
We also noticed in the original design that there were no signs letting people know westbound E. Court Street was closed as they exit I-69 to Dort Highway. Additional signs were added yesterday as part of the April 23 work order to warn people of the closure and follow the posted detour. Our team noticed that some cut-outs in the road filled with temporary gravel were not properly maintained. The contractor plans to maintain these cut-outs daily.
We really appreciate your comments and concerns, but mostly your patience during construction.
Water Main Work Starts Today
on May 04, 2020
+
Westbound lanes have been removed from Albert R Horrigan Drive to Kensington Avenue. Construction crews will begin laying the new 8" water main from Woodlawn Park to just west of Gorman Avenue. Additional one-way signs will be placed at each intersection today. Westbound traffic is to follow the detour.
Reminder:
Traffic is only open to eastbound Court Street. Local traffic will have access to their driveways and intersecting roads by traveling eastbound only.
Additional Signage Coming Soon
on Apr 28, 2020
+
After studying traffic control patterns, additional signs will be added by the end of this week to further direct the detour traffic.
One-way signs will be added at each intersection along the E. Court Street construction limits. Additionally, signs at the exits of I-69 eastbound and westbound at Dort Highway have been added to inform the traffic that westbound E. Court Street is closed and to follow the posted detour for westbound E. Court St. These signs will direct the westbound E. Court St. traffic south on Dort Highway and west on Lapeer Road to E. Court St.
Court St. Detour Route
on Apr 17, 2020
+
Phase 1 construction takes place on E. Court St. from Crapo St. to Dort Highway (M-54). Construction is scheduled between April 22 and August 28, 2020. During this time, only eastbound E. Court St. will be open to local traffic to provide residents access to their homes. Westbound E. Court St. will follow the detour route shown below beginning April 22nd.
courtstreetupdates@sda-eng.com
Construction starting 4/22/20
on Apr 13, 2020
+
CONSTRUCTION NOTICE Court Street will undergo full reconstruction starting this spring. Spalding DeDecker is working for the City to ensure construction is completed per plan. Construction is scheduled to begin on April 22nd. Residents and businesses are encouraged to sign up via Spalding DeDecker’s website for direct email notifications for construction updates. Click the link here to sign up. The City of Flint plans to resurface Court Street from Dort Highway to Crapo Street and install a new water main along this route. The work was bid through the Michigan Department of Transportation (MDOT), with funding for the water main provided through WIIN Funding. The Court Street reconstruction project will affect many residents and commuters as it is a major route through the City. Communication is a priority during this project. This project is deemed essential by the State of Michigan If you have any questions, please email courtstreetupdates@sda-eng.com
Questions? We have answers
If you have any questions or concerns about the project, we are here for you. Our project manager is here to answer any of your questions. Feel free to email or call us at any time.
courtstreetupdates@sda-eng.com
(248) 844-6255
FREQUENTLY ASKED QUESTIONS
Q: I’ve noticed that many of our crosswalks have been eliminated. When will you be completing sidewalks and other issues?
A: It was determined to hold off on paving the top layer of pavement until next spring due to the cold weather. Holding this layer off until the spring will ensure better quality and rideability. Since the top layer is being held until the spring, not all pavement markings, including crosswalks will be added until the top layer is paved. The final top layer and all the pavement markings, including crosswalks, will be added this spring. During this time any other outstanding issues will be addressed as well.
Q: Why is there construction work going on before 8 am?
A: The local noise ordinance allows excessive noise between 8:00am and 9:00pm. This project has been granted special circumstances from the City of Flint and MDOT to allow working hours from 7:00am to 7:00pm. The contractor will try to be courteous with any excessive noise prior to 8am.
Q: Why is work going on during the COVID-19 Pandemic?
A: This project is considered essential work by the State of Michigan. The contractors and employees are practicing safe COVID-19 procedures as directed by the State.
A: No. The new main will not be tied into the system until it is completely installed and tested.
Q: How long will this affect my commute? How long will this construction go on?
A: The impact to your commute should be minor. November 30, 2020 is the anticipated phase 1 open-to-traffic date.
Q: Will emergency vehicles be able to get to my neighborhood?
A: Yes. Emergency vehicles will be able to get to your neighborhood
Q: Will I still have access to the sidewalks?
A: Sidewalk access will be maintained unless there is work currently being done on the sidewalk at the time.
Q: Will there be any damage to the trees?
A: The City, contractor, and engineer have spent considerable effort to minimize any damage to the existing trees in the area during the installation of the new water main. We anticipate that there will be minimal impact to the trees in this neighborhood.
Q: Will the contractor be fixing the road as well?
A: After the water main is installed, the road will be resurfaced.
Q: When and where is the next phase of this project?
A: Phase 2 of this project is from Dort Hwy to Center. Construction for Phase 2 should begin in 2021.
Q: Will the street be widened slightly to accommodate bicyclists? If so by how much?
A: Unfortunately, there is no plan to change the existing geometry of the current road.
Q: Will we get new curbs and driveway entryways to the sidewalks?
A: Yes. New curb, driveway approaches, and sections of the sidewalk will be replaced.
Q: Finally, will landscaping be restored?
A: Yes. Landscaping will be restored in the areas that are disturbed by construction.
