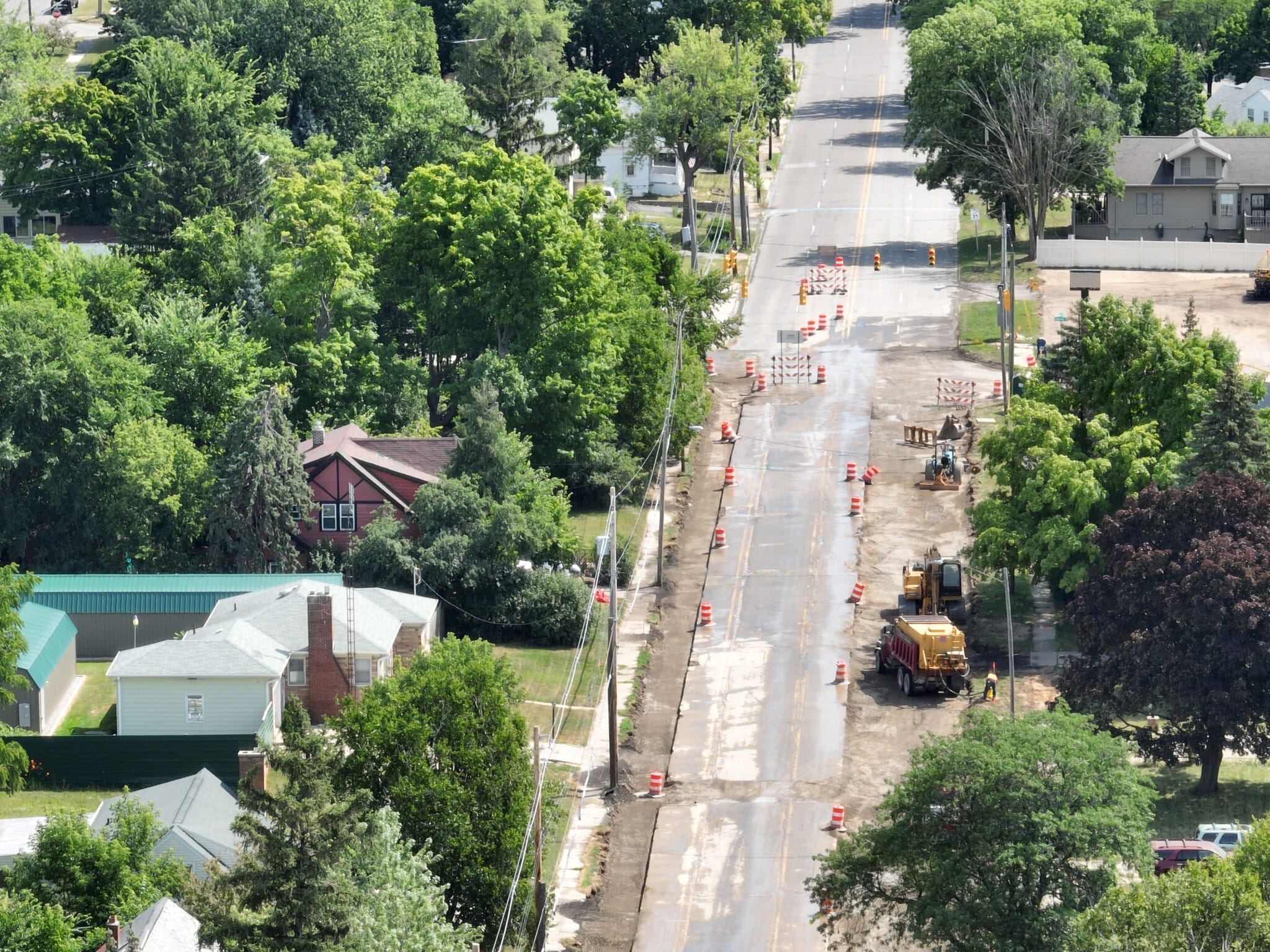

The only remaining work to be completed is the lane striping, which is scheduled for Wednesday, July 5th, with restoration to follow.
Miller Rd is scheduled to be open to all traffic July 6th!
1.39 mi of hot mix asphalt cold milling and resurfacing, storm sewer, water main, concrete curb, gutter, sidewalk and ramps, signing and pavement markings on Miller Road from Ballenger Highway to Hammerberg Road, in the City of Flint, Genesee County.
Spalding DeDecker is providing construction engineering for this project, which means we are observing the contractor's practices and ensuring the project is constructed per the design plan.
Zito Construction is performing the construction work for this project. The work was bid through the Michigan Department of Transportation (MDOT).
Stay on top of construction in your neighborhood with email updates
Know when and where we will be working so you can plan your daily commute.
The only remaining work to be completed is the lane striping, which is scheduled for Wednesday, July 5th, with restoration to follow.
Miller Rd is scheduled to be open to all traffic July 6th!
Construction Update
on Jun 26, 2023
+
Concrete repairs are scheduled to be completed this week. Striping is scheduled to be completed the following week. Once striping is complete, the project will be finished.
Construction Update
on Jun 19, 2023
+
At this time the top course of pavement has been placed. The project is temporarily striped.
Two-way traffic is being maintained while some miscellaneous sidewalk ramps and structure adjustments are being completed this week. Permanent markings will be completed in a few weeks.
Construction Update
on Jun 07, 2023
+
Zito Construction will resume work on Miller Road this week.
Thursday through Saturday (June 8-10, 2023)
The contractor will begin prepping Miller Road for the top course of pavement.
A lane shift will be provided for the base repairs and in preparation for the top course of pavement.
Some sidewalk ramps will be closed/barricaded for repairs.
Monday through Tuesday (June 12-13, 2023)
The contractor will place the top course of pavement.
The lane shift will remain, and two-way traffic will be maintained.
Rain is expected which could affect the schedule. All work is weather dependent.
We appreciate your patience and cooperation.
Construction Update
on Nov 29, 2022
+
Today the contractor placed temporary pavement markings on the road and is working to install signs and complete restoration by the end of the week. Most of the concrete driveways along Miller Road are now safe to use unless there are barrels in front of them. The contractor plans to open the road after the restoration is complete and the signs are installed.
Please keep in mind that this project is not yet complete. The contractor will return next spring to place the top layer of asphalt on the road and complete other miscellaneous items. We will inform you when the contractor plans to return next year to complete the project.
We appreciate your patience and cooperation during the construction this year. We understand that working in a neighborhood directly impacts the residents and can cause delays, inconveniences, and frustration.
Construction Update
on Nov 23, 2022
+
The contractor has informed us that they now have all the asphalt down they are going to place this year. They will finish the top course next spring.
Concrete for all driveways should be finished by early next week. Residents with the barrels removed from their driveways should now be able to access them. Unfortunately, we are still waiting for the concrete to cure on the driveways that still have barrels in front of them.
We understand Thanksgiving is tomorrow, and some residents will be having family attend. The City has told us that temporary parking will be permitted on Miller Road during this time at the owner's risk. Please have vehicles removed from the road by Sunday evening.
Next week the contractor will work on the remaining concrete driveways and sidewalks, restoration, temporary pavement markings, and signs.
We will send an update once all driveway concrete is cured. We expect this to be next week.
We greatly appreciate your patience during the pavement construction rush over the last few weeks.
Thank you, and have a Happy Thanksgiving!
Construction Update
on Nov 08, 2022
+
Just as a reminder, the contractor is working on removing and replacing curb and driveways on the north and south sides of Miller Road from Colchester to Hammerburg this week.During this time local residents on Miller Road will not have access to their driveways and are encouraged to seek alternate parking on side streets. We anticipate that once the new concrete is installed it will take 7 to 10 days before residents can resume to use their driveways.
We will send an email update when residents are able to access their driveways again.
Construction Update
on Nov 04, 2022
+
Beginning Monday (11/07/2022), asphalt milling will begin on Miller Road from S. Ballenger Hwy to Colchester Rd. The contractor will be milling the road all next week and fixing any joints in the pavement in preparation for new asphalt pavement.
This work will be commencing concurrently with the curb and driveway work on Miller Road between Colchester Rd and Hammerburg Rd.
Miller Road will still be open to local traffic, but please use extra care when driving through the construction zone and use side streets when available.
Construction Update
on Nov 03, 2022
+
Starting Monday (11/07/2022) of next week, the contractor will begin installing curb and gutter in front of the houses on the north and south sides of Miller Road from Colchester to Hammerburg. They plan to start on the south side of the road. During this time residents will not be able to access their driveways and should seek other places to park on side streets.
After the curb is placed, the contractor will begin removing residents' driveways, grading them, and then placing new concrete driveways. During this entire process, it may take up to 10 days before the concrete is ready and residents are able to access their driveways again. The concrete will be tested during this time, and when it has been determined safe to drive on, Spalding DeDecker will send an email update letting everyone know they can access their new driveways.
Please be mindful that this schedule is dependent on weather, materials, and subcontractor scheduling issues. We will send an update if we hear anything different from the contractor.
Construction Update
on Oct 28, 2022
+
Next week the contractor plans to remove curb and gutter on the north and south sides of the road, install edge drain, and start grading for the new HMA pavement. We anticipate they will start removing driveways the following week in preparation for the new concrete driveways.
We will send another update with additional information before driveway removal when we have a better idea of the contractor's schedule.
Construction Update
on Oct 21, 2022
+
Zito has finished installing the water main. Next week they will continue to install storm sewer in preparation for paving.
Construction Update
on Oct 14, 2022
+
Zito Construction plans to complete water services this week. Next week Zito will continue installing storm sewer between Colchester Rd and Hammerburg Rd. Concrete curb, sidewalk, and driveways will begin toward the end of this month.
Thank you for your patience and understanding during the construction process.
For questions, email millerroad@sda-eng.com
Construction Update
on Oct 07, 2022
+
Next week Zito will continue installing storm sewer between Colchester Rd and Hammerburg Rd. During construction the contractor has stockpiled and shut down the intersections at Clara Rd and Monterey Ave. During the installation of storm sewer the contractor may be crossing the road. Please continue to use side streets if this is the case.
Thank you for your patience and understanding during the construction process.
For questions, email millerroad@sda-eng.com
Construction Update
on Sep 30, 2022
+
Next week the contractor, Zito Construction, plans to continue installing water main leads and work on site restoration.
Construction Update
on Sep 23, 2022
+
The contractor, Zito Construction, continued to install the water main this week. Next week they will begin installing water main leads across the road.
Construction Update
on Sep 16, 2022
+
The contractor, Zito Construction, is currently installing water main from Lincoln Dr towards Hammerburg Rd.
Construction Update
on Sep 02, 2022
+
Work has continued on Miller Road.
Currently, the contractor, Zito Construction, is working on pavement removals above where the new water main will be installed on the south side of the road between Colchester Road and Hammerberg Road.
During this time, there may be a chance that the residents on the south side will have their driveway blocked while they are installing the water main. This should only be for a short period of time, and Zito's crew will place temporary gravel in front of the driveways after they are finished installing the new water main to allow residents access to their driveways.
Thank you for your patience during the construction process.
Construction Update
on Aug 22, 2022
+
Miller Road construction is scheduled to resume on Monday, August 29th after the Crim Festival of Races.
Thank you for your patience and cooperation during the construction process.
For questions, email millerroad@sda-eng.com
Construction Update
on Aug 08, 2022
+
Currently, there is no work happening on site. Construction is halted due to scheduling conflicts with subcontractors and to avoid tearing up the road for the CRIM festival. Construction is scheduled to start back up after the CRIM at the end of the month.
Thank you for your patience and cooperation during the construction process.
For questions, email millerroad@sda-eng.com
Construction Update
on Jul 29, 2022
+
Residents should now be able to access their driveways. The Contractor has placed all concrete driveways and sidewalks between Ballenger Highway and Colchester Road and has placed maintenance aggregate in front of driveways. They also paved the base course of asphalt over the water main trench.
Thank you for your patience and cooperation during the construction process.
For questions, email millerroad@sda-eng.com
Video Construction Update
on Jul 19, 2022
+
Check out our latest video update below!
This week the Contractor will be finishing curbs, sidewalks in front of houses, and driveways. They plan to pave 3" of asphalt over the water main trench on Thursday, July 21.
Thank you for your patience and cooperation.
Remember to sign up for email updates right to your inbox. Click HERE to sign up!
Construction Update
on Jul 13, 2022
+
Construction Update - July 13, 2022
Due to rain over the past two days, the concrete has been delayed until Thursday, July 14. Thank you for your understanding and cooperation.
This week road construction will continue between Ballenger Highway and Knight Avenue. First, the new curb and gutter will be placed, followed by driveway and sidewalk replacement. The work will take approximately two weeks to complete. There will be no access to your driveways during this time.
Resident vehicles MUST BE removed from the construction zone before 7am on Tuesday, July 12. Please park your vehicles on side streets and away from the construction zone.
You will be allowed to park on Miller Road between 7pm and 7am ONLY during this construction phase. The vehicles must be removed from Miller Road before 7am each morning.
Important note: Concrete takes multiple days to cure and requires time to properly harden. Please do not drive or park on the new concrete until it has been cured completely. You will be notified when it is safe to do so. Please arrange to park away from the construction zone in advance to avoid getting blocked in.
We thank you for your patience and cooperation during this construction phase. Please don't hesitate to ask questions or ask for assistance from one of our team members.
Construction Update
on Jul 08, 2022
+
Construction Update - July 8, 2022
All homes on Miller Road between Ballenger Highway and Knight Avenue are now connected to the new water main. The old water main has been turned off.
Next week, road construction will continue between Ballenger Highway and Knight Avenue. First, the new curb and gutter will be placed, followed by driveway and sidewalk replacement. The work will take approximately two weeks to complete. There will be no access to your driveways during this time.
Resident vehicles MUST BE removed from the construction zone before 7am on Tuesday, July 12. Please park your vehicles on side streets and away from the construction zone.
You will be allowed to park on Miller Road between 7pm and 7am ONLY during this construction phase. The vehicles must be removed from Miller Road before 7am each morning.
Important note: Concrete takes multiple days to cure and requires time to properly harden. Please do not drive or park on the new concrete until it has been cured completely. You will be notified when it is safe to do so. Please arrange to park away from the construction zone in advance to avoid getting blocked in.
We thank you for your patience and cooperation during this construction phase. Please don't hesitate to ask questions or ask for assistance from one of our team members.
Construction Update
on Jun 25, 2022
+
The contractor is finishing water service leads, and all homes on Miller Road between Colchester Road and Ballenger Highway will be connected to the new water main.
The contractor will then transition into grading the south side of the road over the water main trench and will start removing pavement and driveways on the north side of the road which will narrow the road a bit.
All homeowners and businesses will have local access only.
It is highly recommended to avoid any unnecessary driving through the construction zone and follow the detour.
Construction Update
on Jun 17, 2022
+
The contractor will begin water service installation on Monday, June 20th.
This work entails switching the water service lines for the homes and businesses directly on Miller Road (between Ballenger Highway and Knight Ave/Colchester Road) from the old water main to the new water main.
Residents may experience a 15-minute average time frame where their water will be turned off while the contractor makes this transition.For each home or business affected by this water shut down, an attempt will be made to notify them before the water is turned off. Once the switch is complete, the Flint Water Department recommends turning on your cold water until all air is out of your pipes. They also recommend running your cold water for approximately 10 minutes to flush out the pipes.
Any questions can be directed to the Flint Water Department.
Construction Update
on Jun 01, 2022
+
Construction began May31st.
Miller Road from Ballenger Hwy to Hammerberg Rd is closed to through traffic while new water main, curb and gutter, storm sewer, sidewalks, and driveways are being constructed. During construction, the contractor will maintain access to local traffic so that the residents can access their homes. All other traffic is to be redirected to Court Street via Ballenger Hwy.
Residents on the south side of Miller Road with driveways on Miller Road will have some portion of their driveways removed while construction commences. Access will be maintained with aggregate until the removed portion can be replaced.
Construction Update
on May 30, 2022
+
Starting on Tuesday, May 31st, Miller Road from Ballenger Hwy to Hammerberg Rd will be closed to through traffic while new water main, curb and gutter, storm sewer, sidewalks, and driveways are being constructed. During construction, the contractor will maintain access to local traffic so that the residents can access their homes. All other traffic is to be redirected to Court Street via Ballenger Hwy.
This closure is scheduled until November of 2022. Special staging and access will be maintained for the Crim Festival. Stay tuned for further updates.
Project Information
on May 27, 2022
+
1.39 mi of hot mix asphalt cold milling and resurfacing, storm sewer, water main, concrete curb, gutter, sidewalk and ramps, signing and pavement markings on Miller Road from Ballenger Highway to Hammerberg Road, in the City of Flint, Genesee County.
Spalding DeDecker is providing construction engineering for this project, which means we are observing the contractor's practices and ensuring the project is constructed per the design plan.
Zito Contracting is performing the construction work for this project. The work was bid through the Michigan Department of Transportation (MDOT).
Communication is a priority during this project. Residents and businesses will be able to sign up for direct email notifications for construction updates as the project progresses.
Questions? We have answers
If you have any questions or concerns about the project, we are here for you. Our project manager is here to answer any of your questions. Feel free to email or call us at any time.
