Latest Update
Project Overview
Oct 24, 2025
Check out the Concrete Road Program Project Overview
Read More
The contractor will continue to address any deficient items and restoration. We thank all the residents for their patience and cooperation during the construction process!
Construction Updates
Project Overview
on Oct 24, 2025
+
Check out the Concrete Road Program Project Overview
The contractor will continue to address any deficient items and restoration. We thank all the residents for their patience and cooperation during the construction process!
Construction Update
on Oct 17, 2025
+
For the week of October 20th:
Eddington Boulevard (All phases) Farnborough to Essex
Flanders Drive

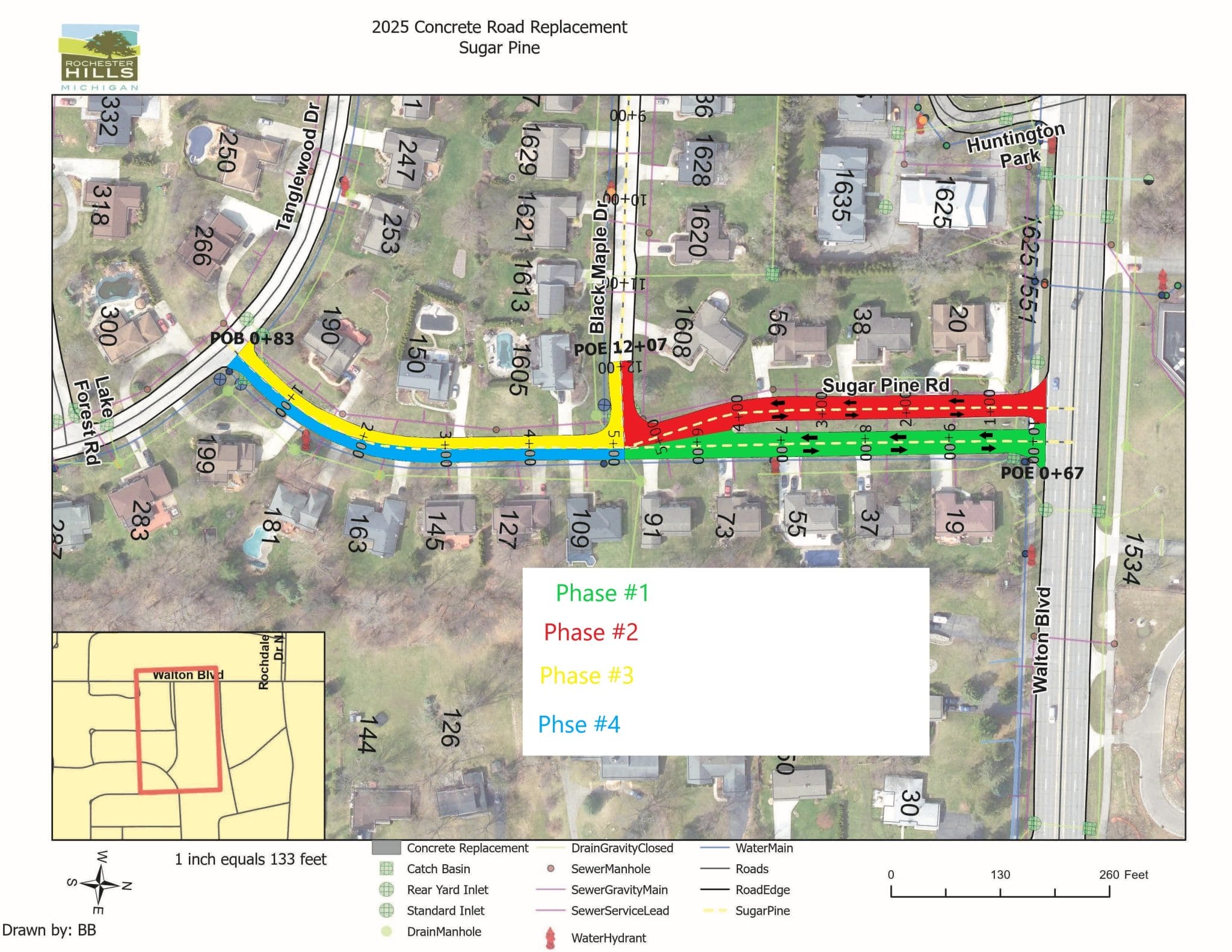

Sugar Pine Road (All phases) Walton to Tanglewood
Sanctuary Blvd at South Blvd
Pheasant Ring/Eagle Drive (All phases)
Cedar Shake/Lakewood Drive (All phases)
Independence Drive/Court (All phases)
Charlwood Drive

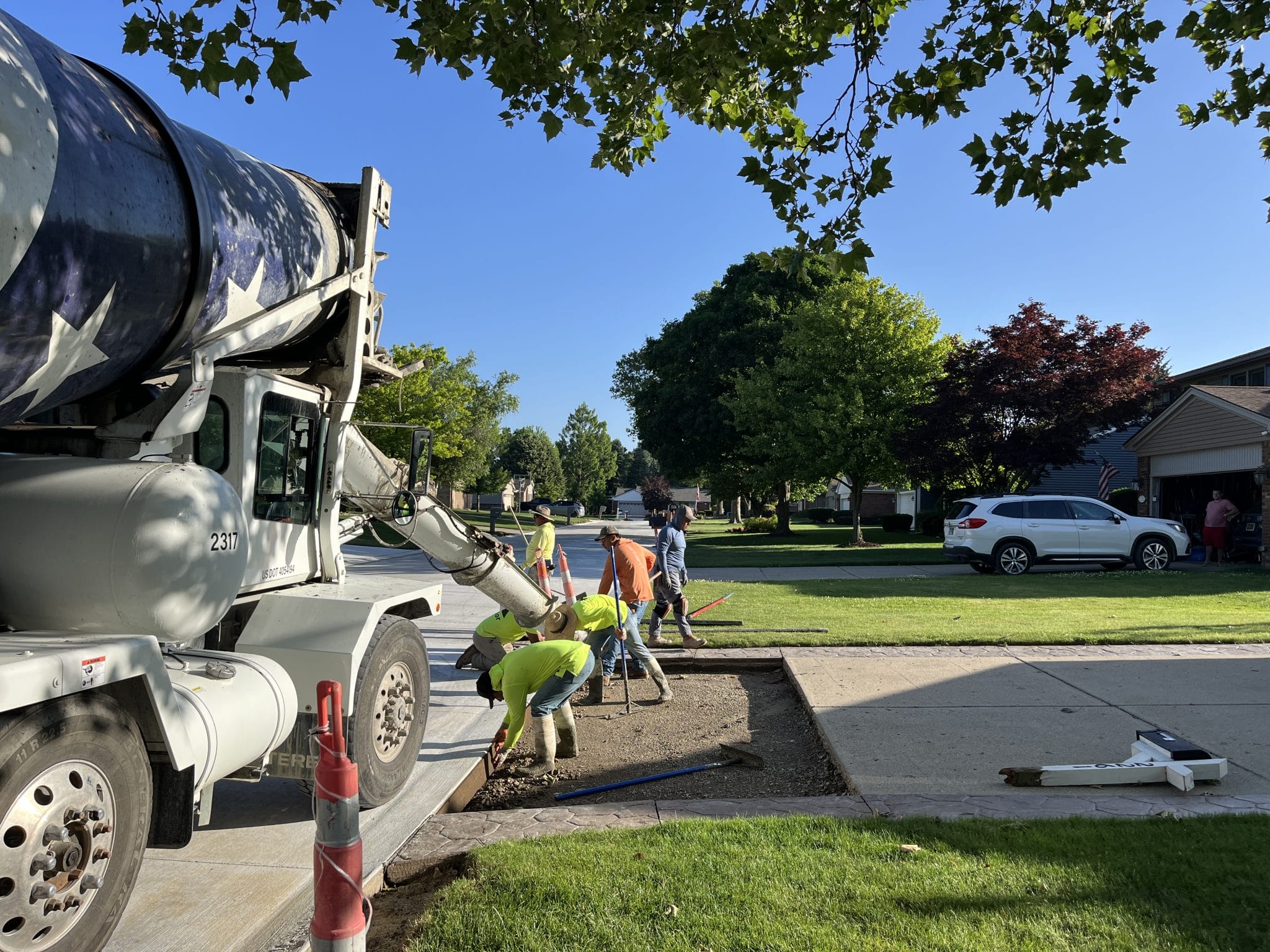

Sidewalk replacement Program
There will be a final project review to compile a list of deficient items that will be addressed prior to the final closeout of the project. The final review of restoration areas will be done in the spring.
Stay tuned for a project overview video!

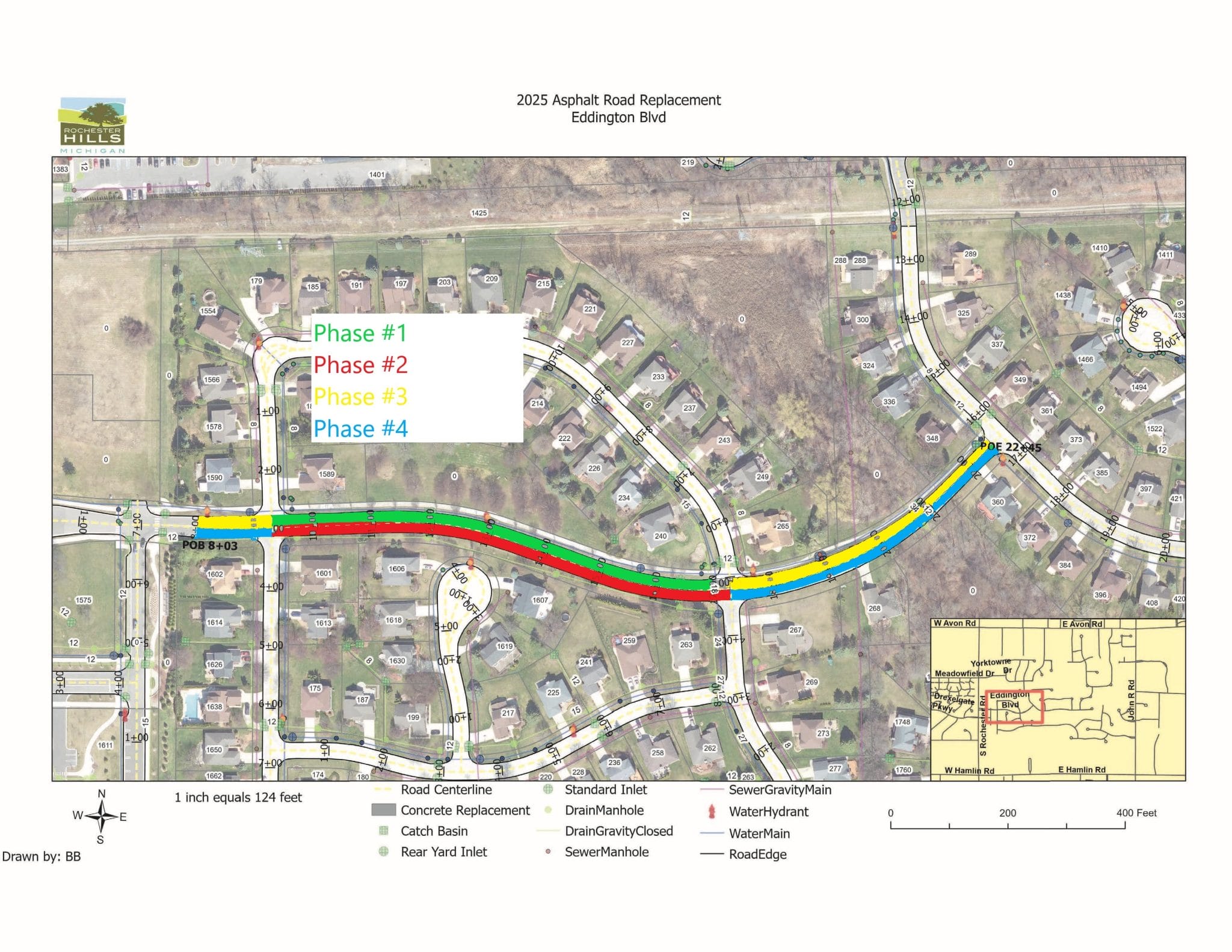

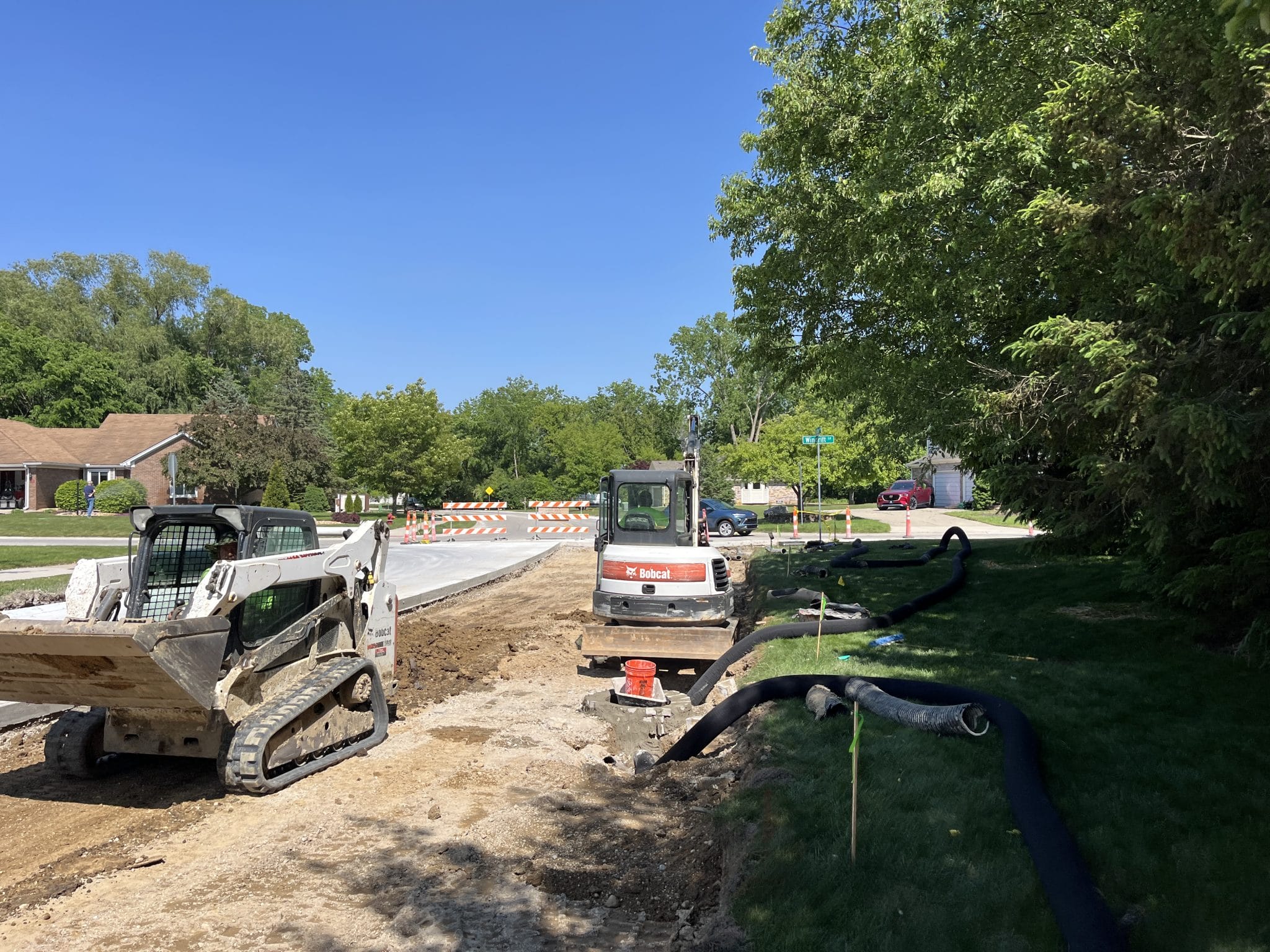

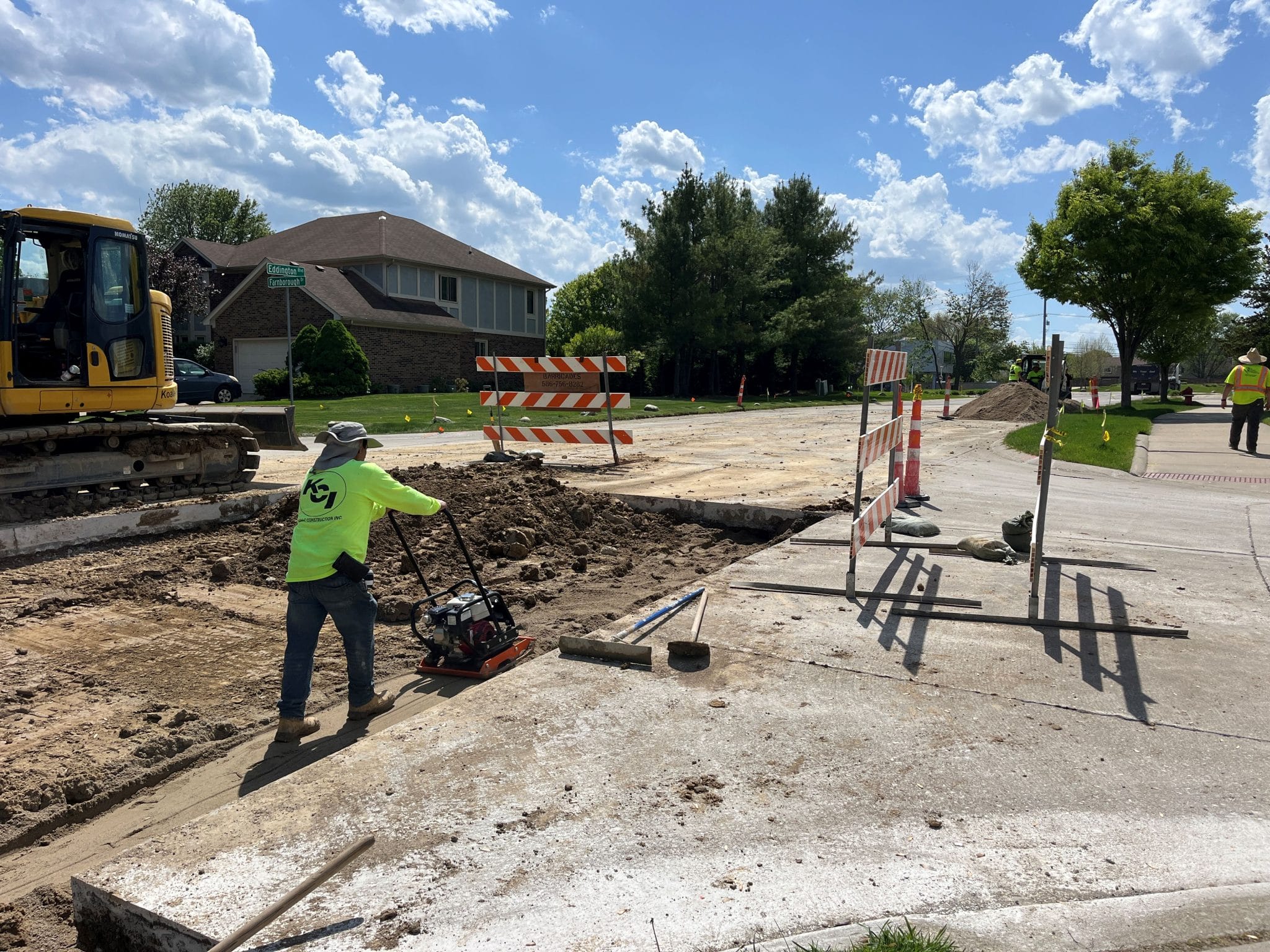

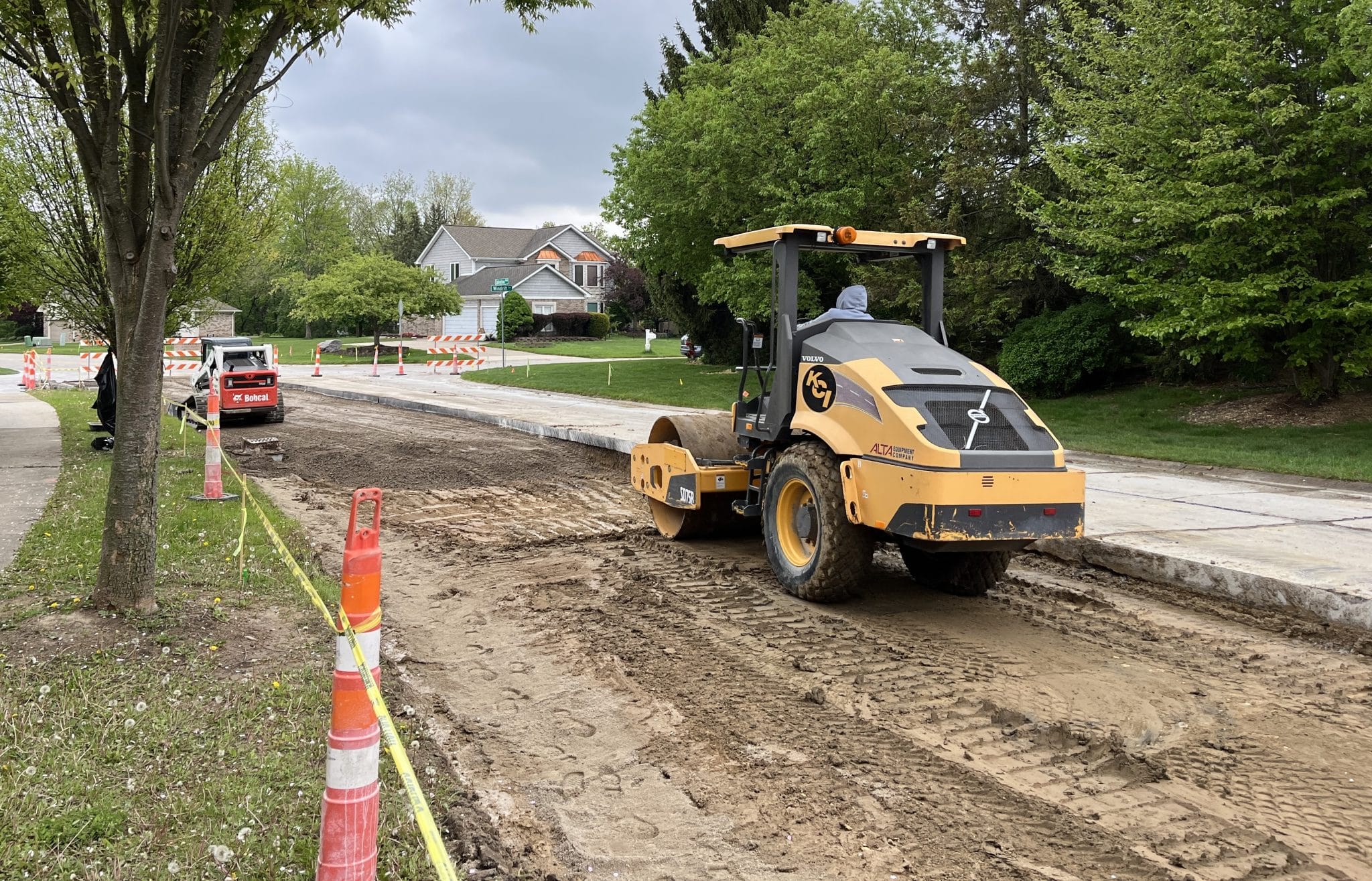

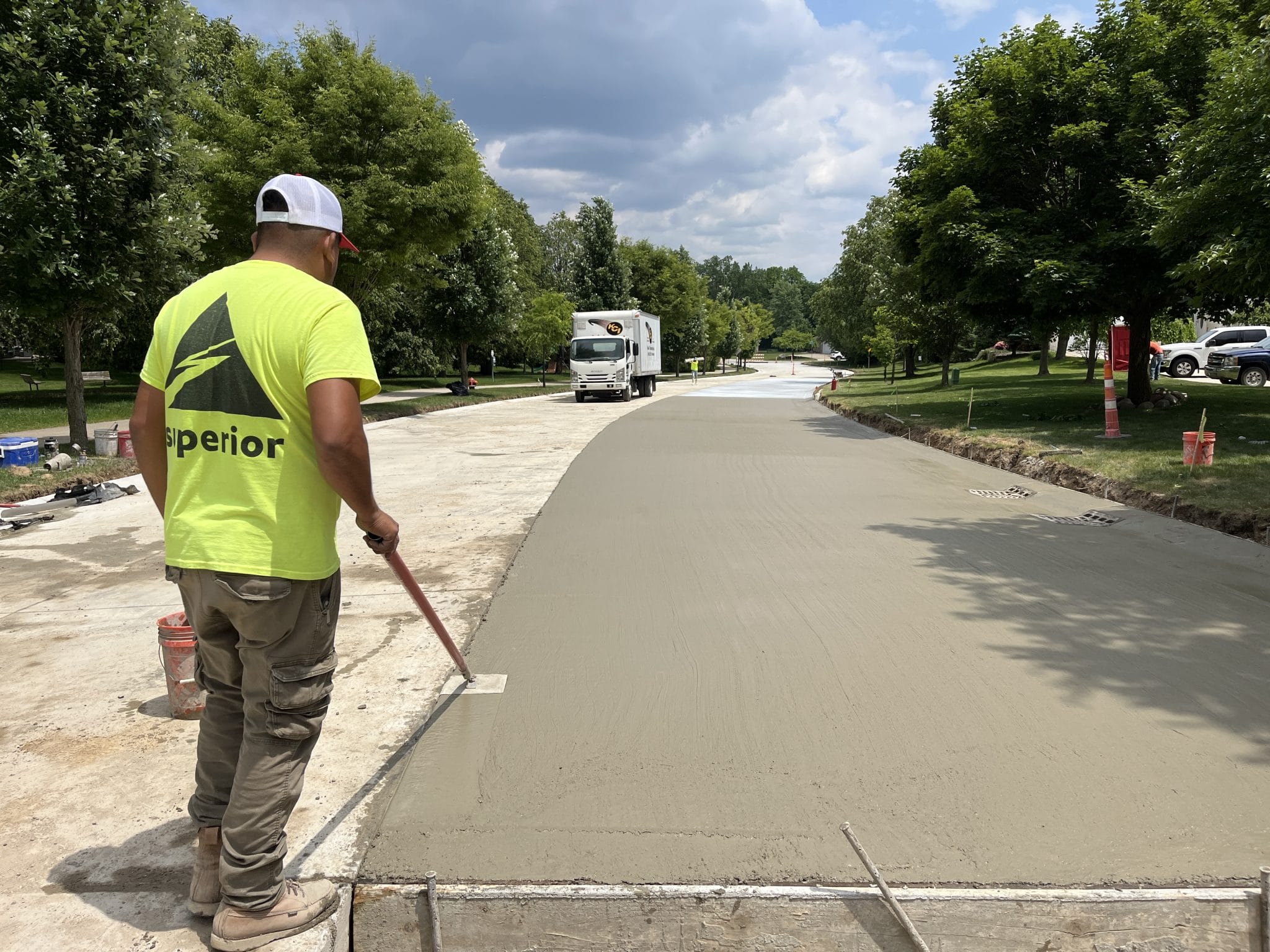

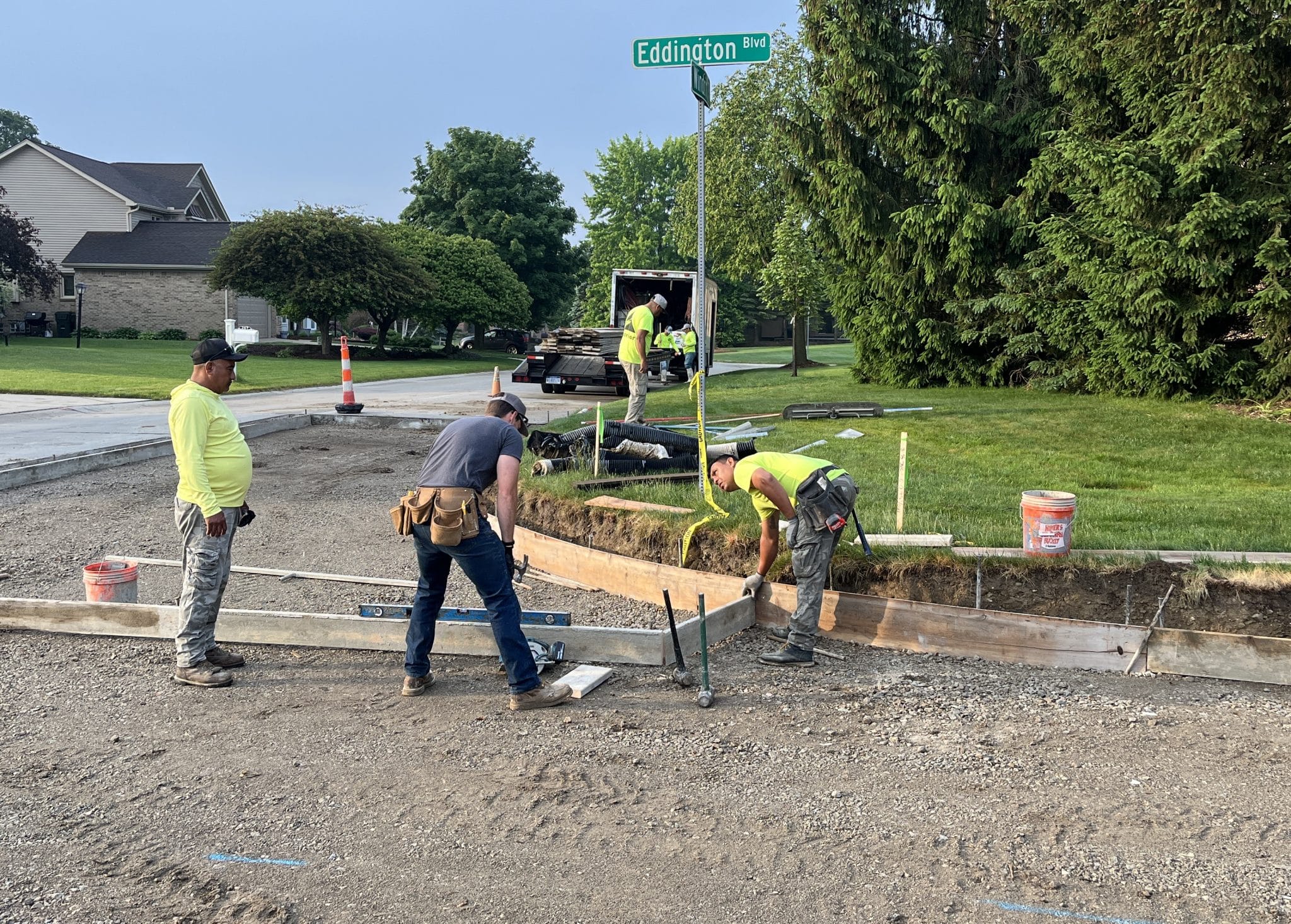

Eddington Boulevard (All phases) Farnborough to Essex
- Complete.

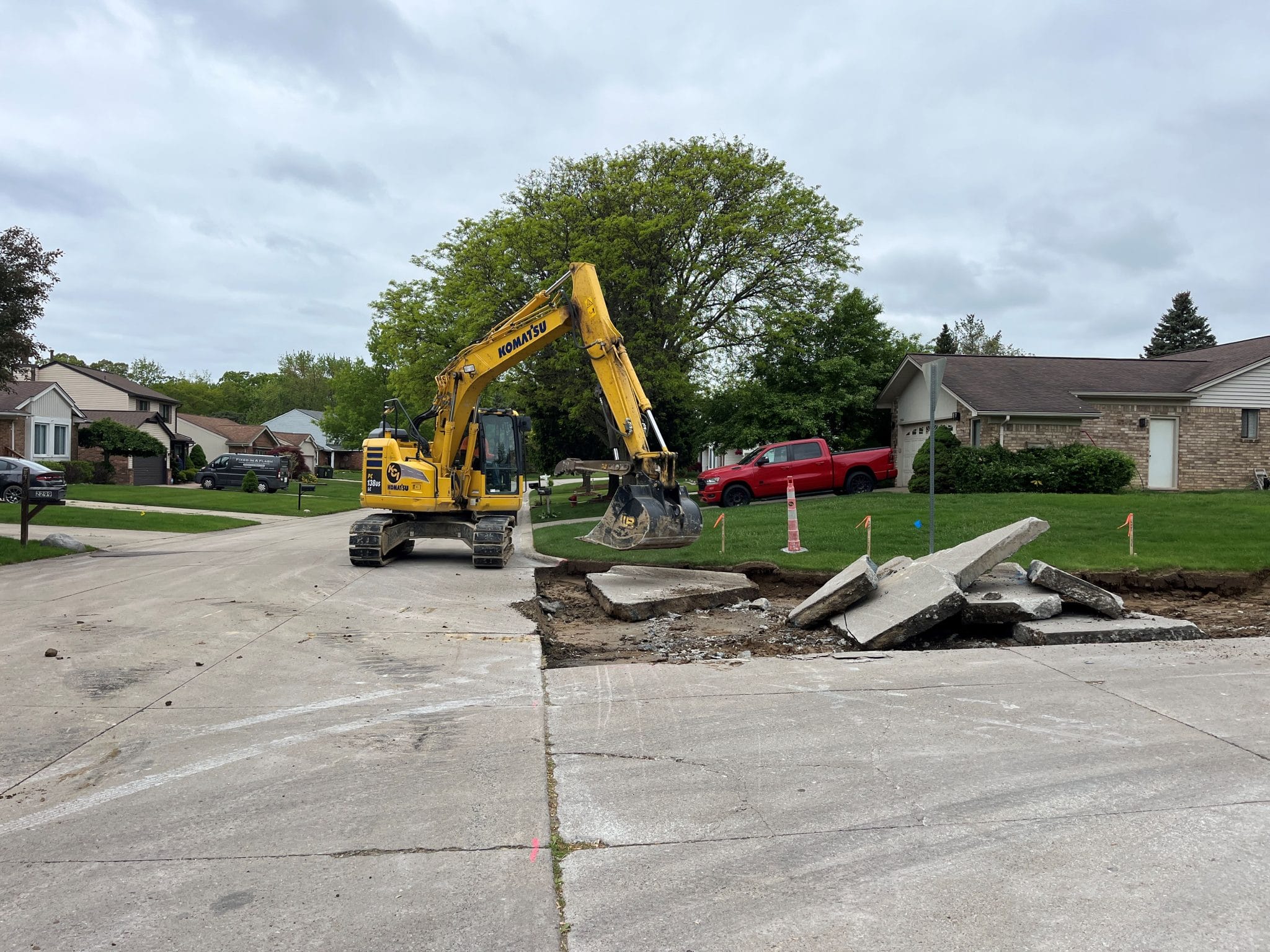

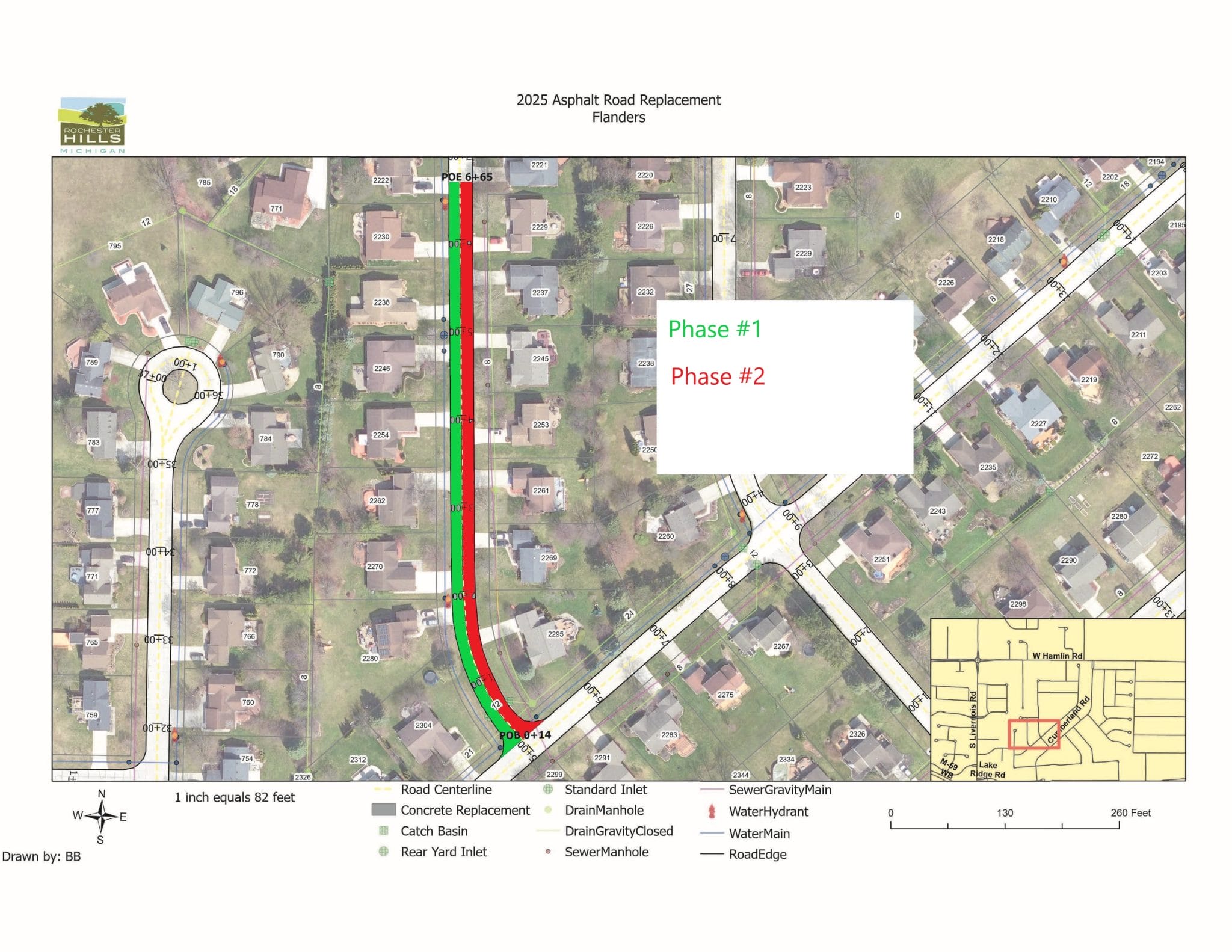

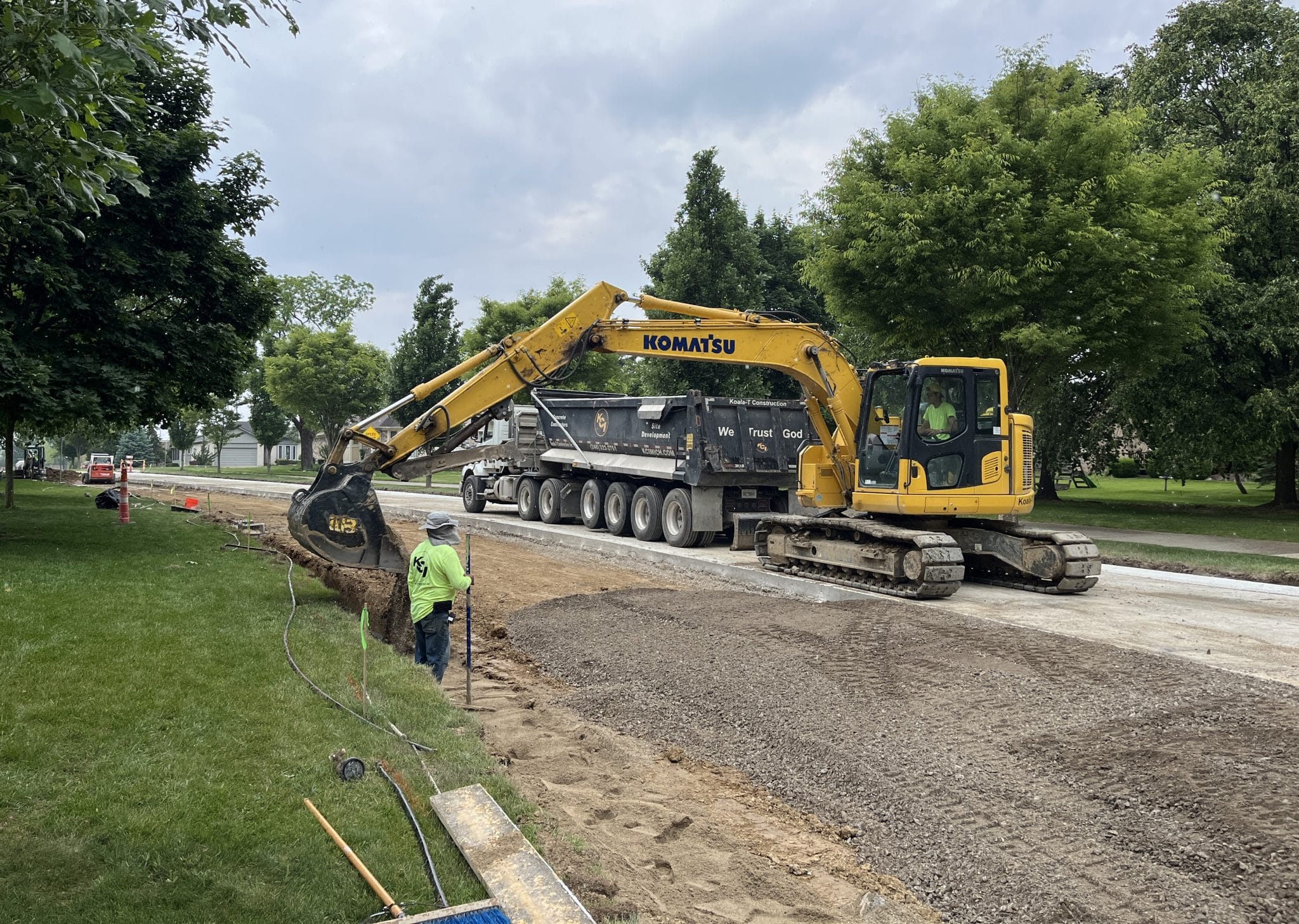

Flanders Drive
- Complete.

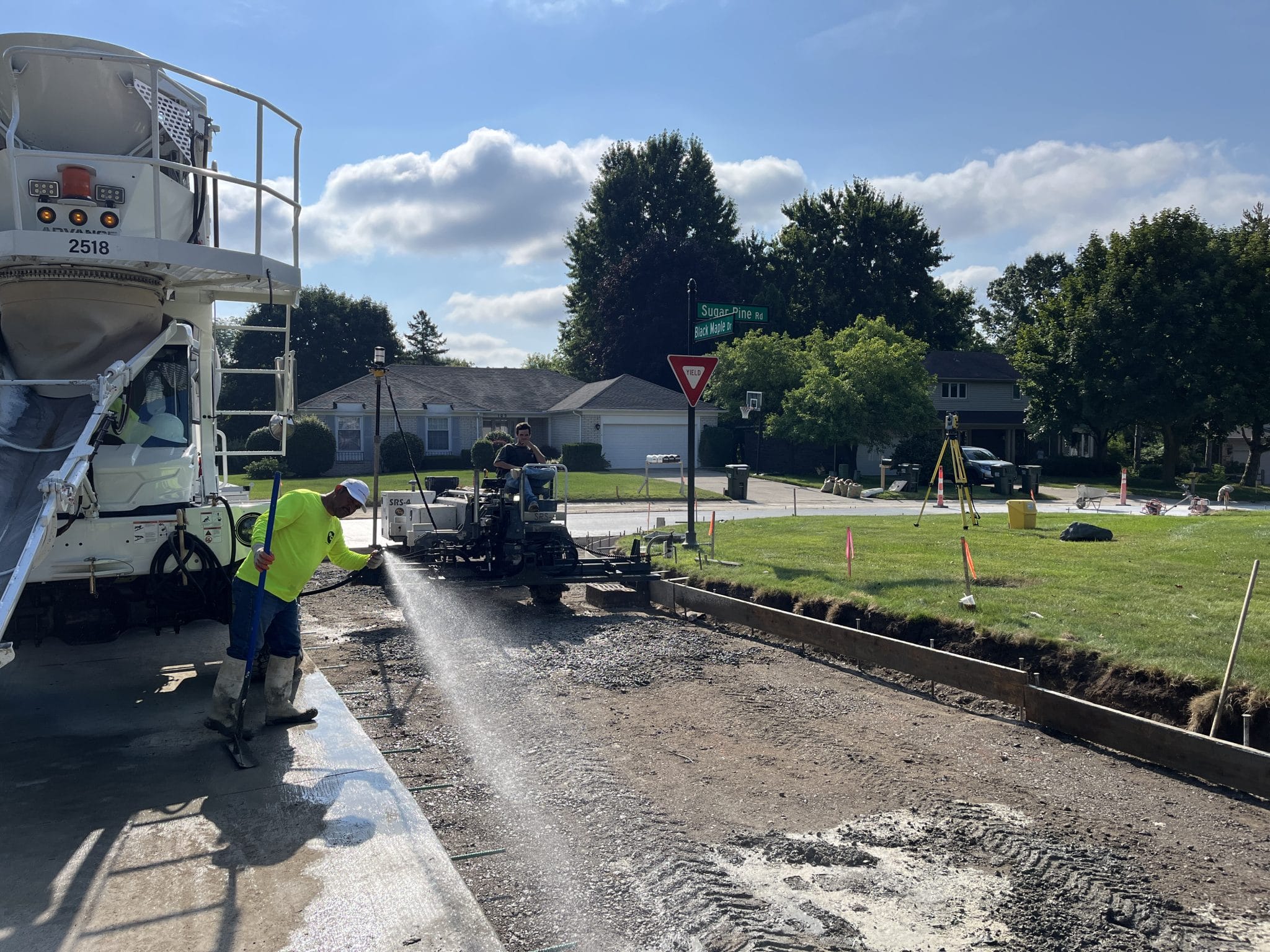

Sugar Pine Road (All phases) Walton to Tanglewood
- Complete.

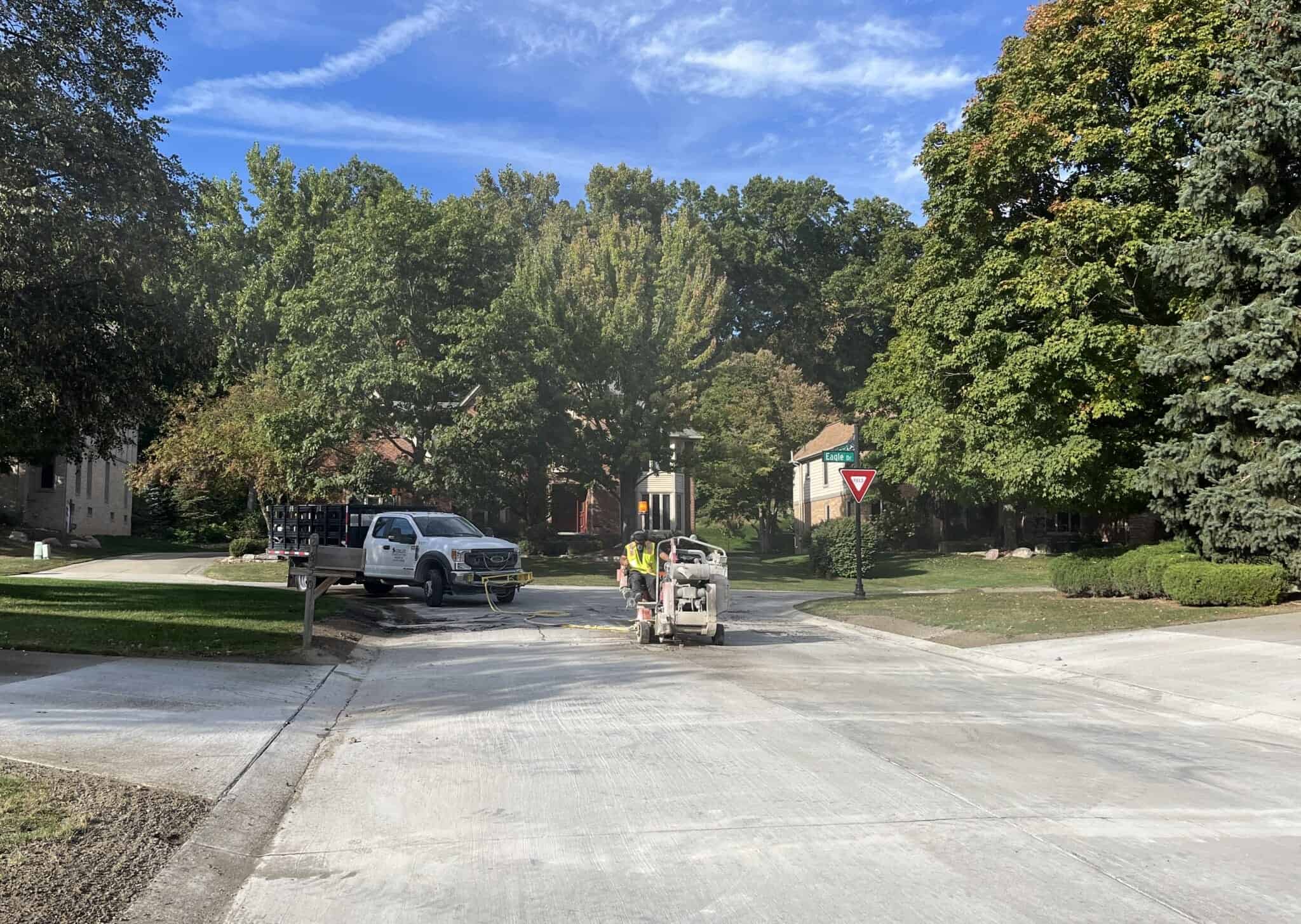

- Pavement Markings at Walton Blvd to be announced.
Sanctuary Blvd at South Blvd
- Complete.
Pheasant Ring/Eagle Drive (All phases)
- Complete.
Cedar Shake/Lakewood Drive (All phases)
- Address deficient items.

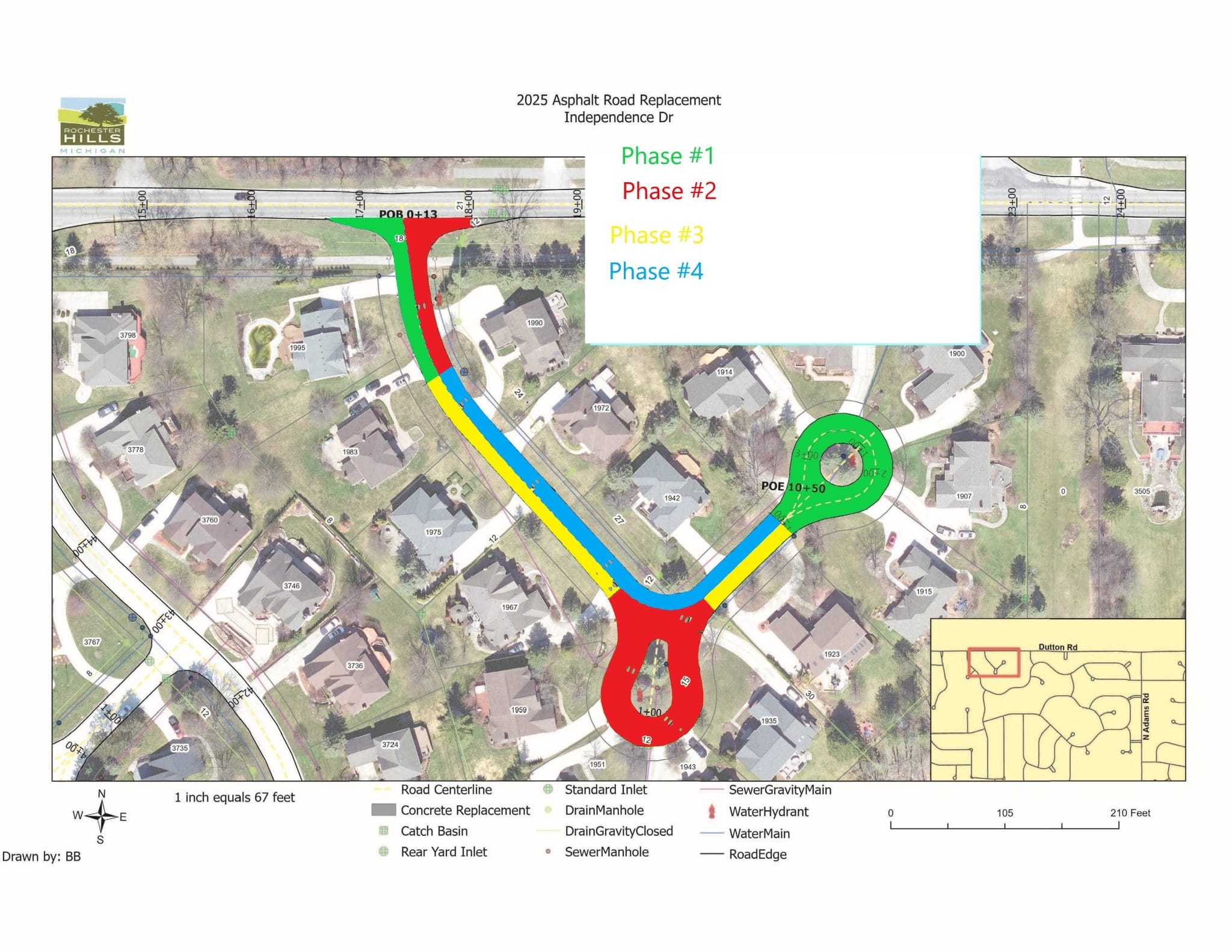

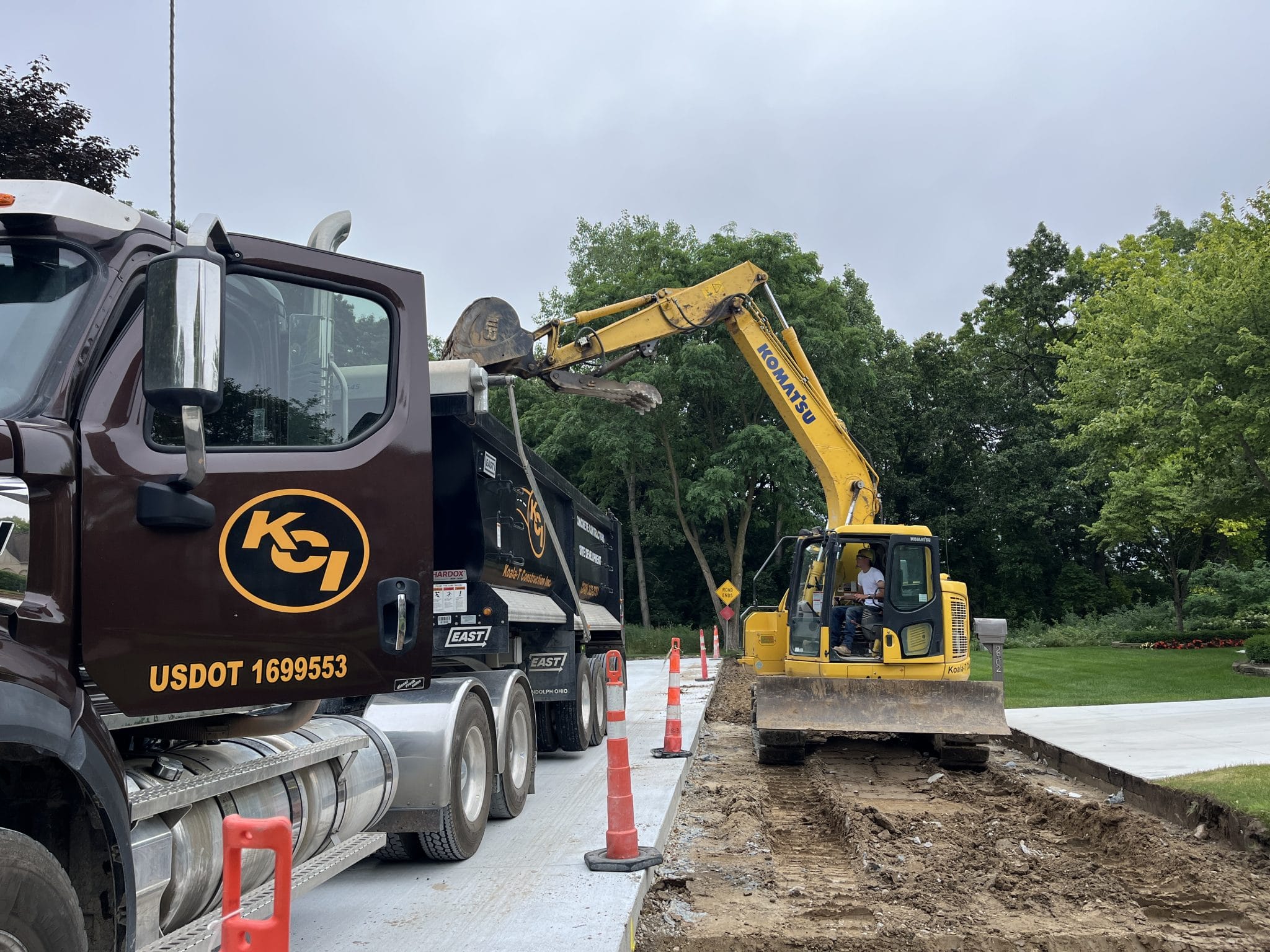

Independence Drive/Court (All phases)
- Complete.
- Pavement Markings at Dutton Road to be announced.
Charlwood Drive
- Complete.
- Pavement Markings at Adams Road to be announced.
Sidewalk replacement Program
- Complete.
There will be a final project review to compile a list of deficient items that will be addressed prior to the final closeout of the project. The final review of restoration areas will be done in the spring.
Stay tuned for a project overview video!
Construction Update
on Oct 10, 2025
+
For the Week of October 13th:
Eddington Boulevard (All Phases) Farnborough to Essex
Flanders Drive
Sugar Pine Road (All Phases) Walton to Tanglewood
Sanctuary Blvd at South Blvd
Pheasant Ring/Eagle Drive (All Phases)

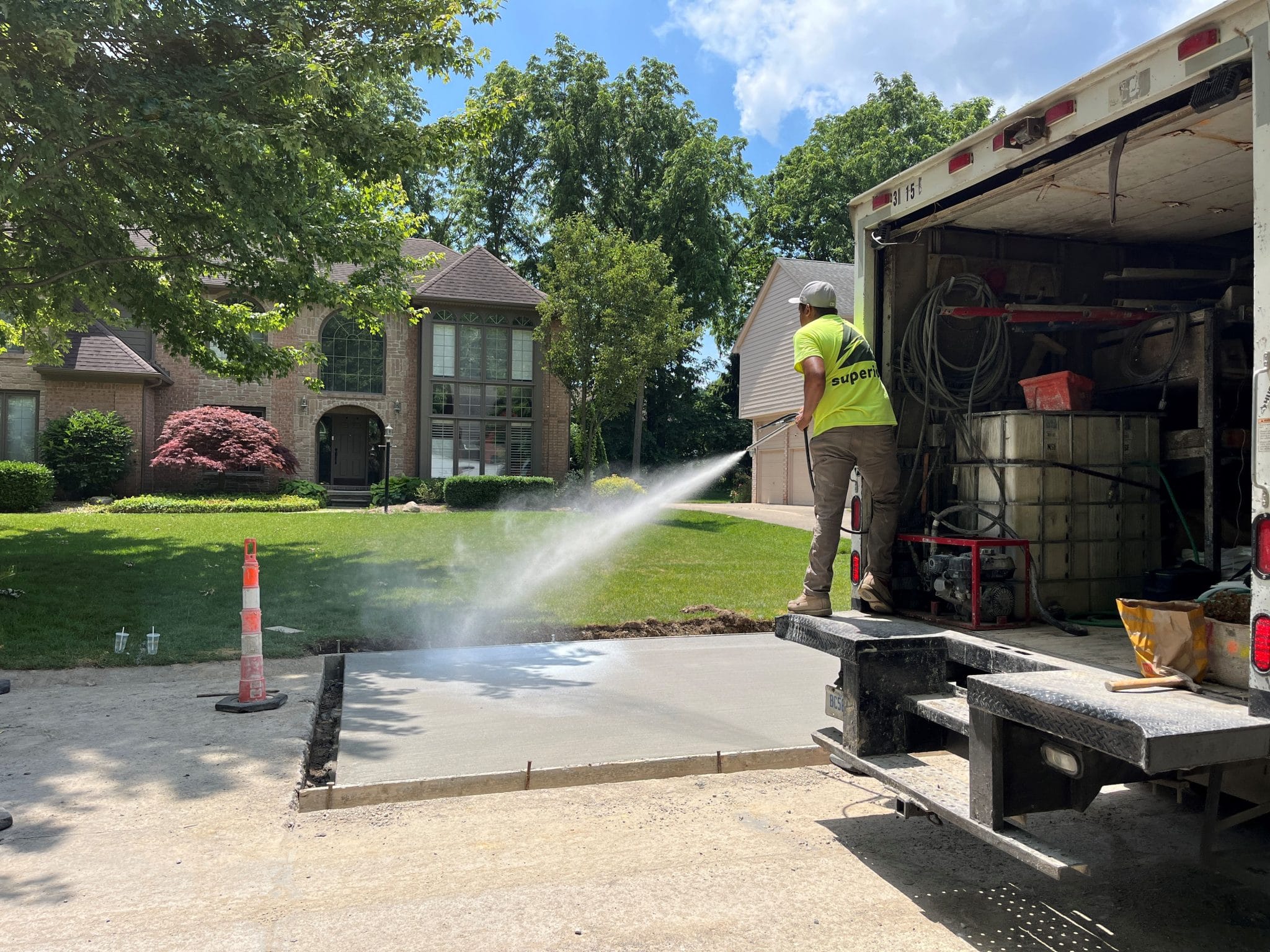

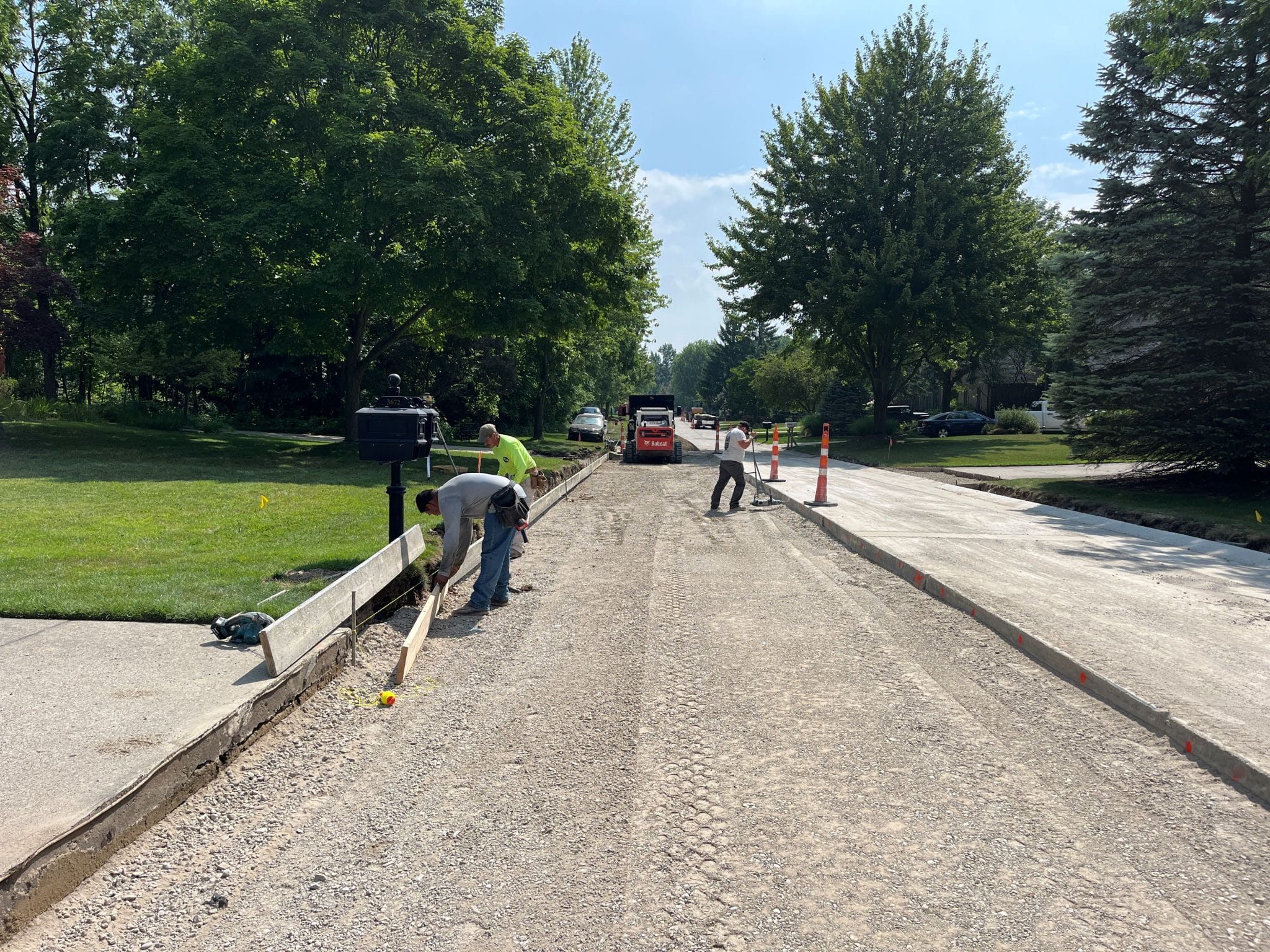

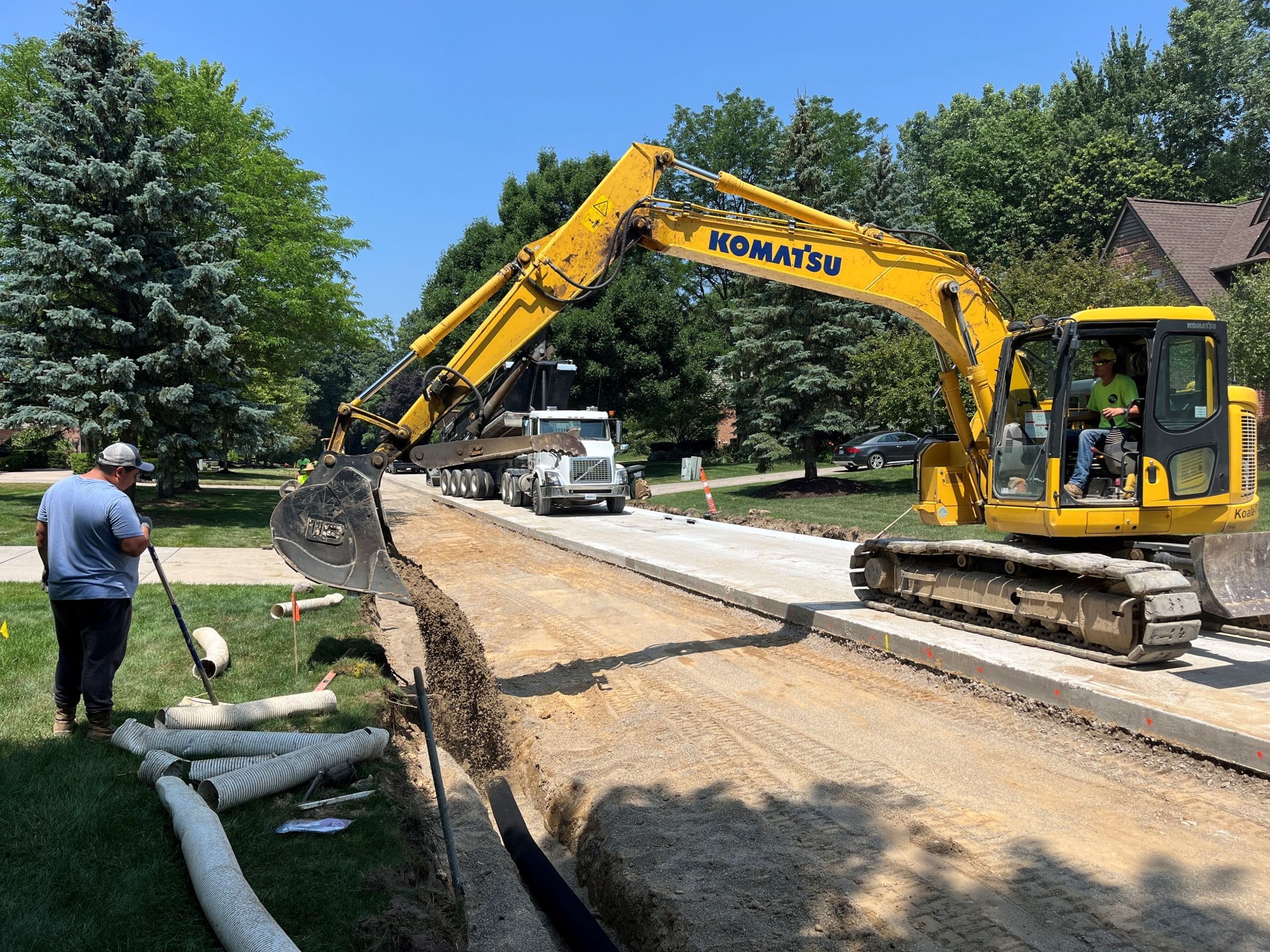

Cedar Shake/Lakewood Drive (All Phases)
Independence Drive/Court (All Phases)
Charlwood Drive
Sidewalk Replacement Program
Restoration will take place in the Rookery Woods, Clear Creek, and East Hampton subdivisions.
New pavement on Eddington Boulevard.
Eddington Boulevard (All Phases) Farnborough to Essex
- Speed hump installation.
- Address deficient items.
Flanders Drive
- Address deficient items
Sugar Pine Road (All Phases) Walton to Tanglewood
- Pavement markings at Dutton to be announced.
- Address deficient items.
Sanctuary Blvd at South Blvd
- Address deficient items.
Pheasant Ring/Eagle Drive (All Phases)
- Sweep pavement.
- Address deficient items.
Cedar Shake/Lakewood Drive (All Phases)
- Address deficient items.
Independence Drive/Court (All Phases)
- Sweep pavement.
- Pavement markings at Dutton to be announced.
- Address deficient items.
Charlwood Drive
- Address deficient items.
- Pavement markings at Adams Road to be announced.
Sidewalk Replacement Program
Restoration will take place in the Rookery Woods, Clear Creek, and East Hampton subdivisions.
New pavement on Eddington Boulevard.
Construction Updates
on Oct 03, 2025
+
For the Week of October 6th:
Eddington Boulevard Farnborough to Essex
Flanders Drive
Sugar Pine Road (All phases) Walton to Tanglewood
Sanctuary Blvd at South Blvd
Pheasant Ring/Eagle Drive (All phases)
Cedar Shake/Lakewood Drive (All phases)
Independence Drive/Court (All phases)
Charlwood Drive
Sidewalk Replacement Program
Restoration will take place in the Rookery Woods, Clear Creek, and East Hampton subdivisions.


Eddington Boulevard Farnborough to Essex
- Speed hump installation.
- Address deficient items.
Flanders Drive
- Address deficient items
Sugar Pine Road (All phases) Walton to Tanglewood
- Pavement markings at Dutton to be announced.
- Address deficient items.
Sanctuary Blvd at South Blvd
- Address deficient items.
Pheasant Ring/Eagle Drive (All phases)
- Address deficient items.
Cedar Shake/Lakewood Drive (All phases)
- Address deficient items.
Independence Drive/Court (All phases)
- Restoration.
- Pavement markings at Dutton to be announced.
Charlwood Drive
- Address deficient items.
- Pavement markings at Adams Road to be announced.
Sidewalk Replacement Program
Restoration will take place in the Rookery Woods, Clear Creek, and East Hampton subdivisions.


Construction Update
on Sep 26, 2025
+
For the Week of September 29th:
Residents: Please try to park all vehicles in your driveway this week during the pavement joint sealing activities on your street.
Eddington Boulevard (All phases) Farnborough to Essex

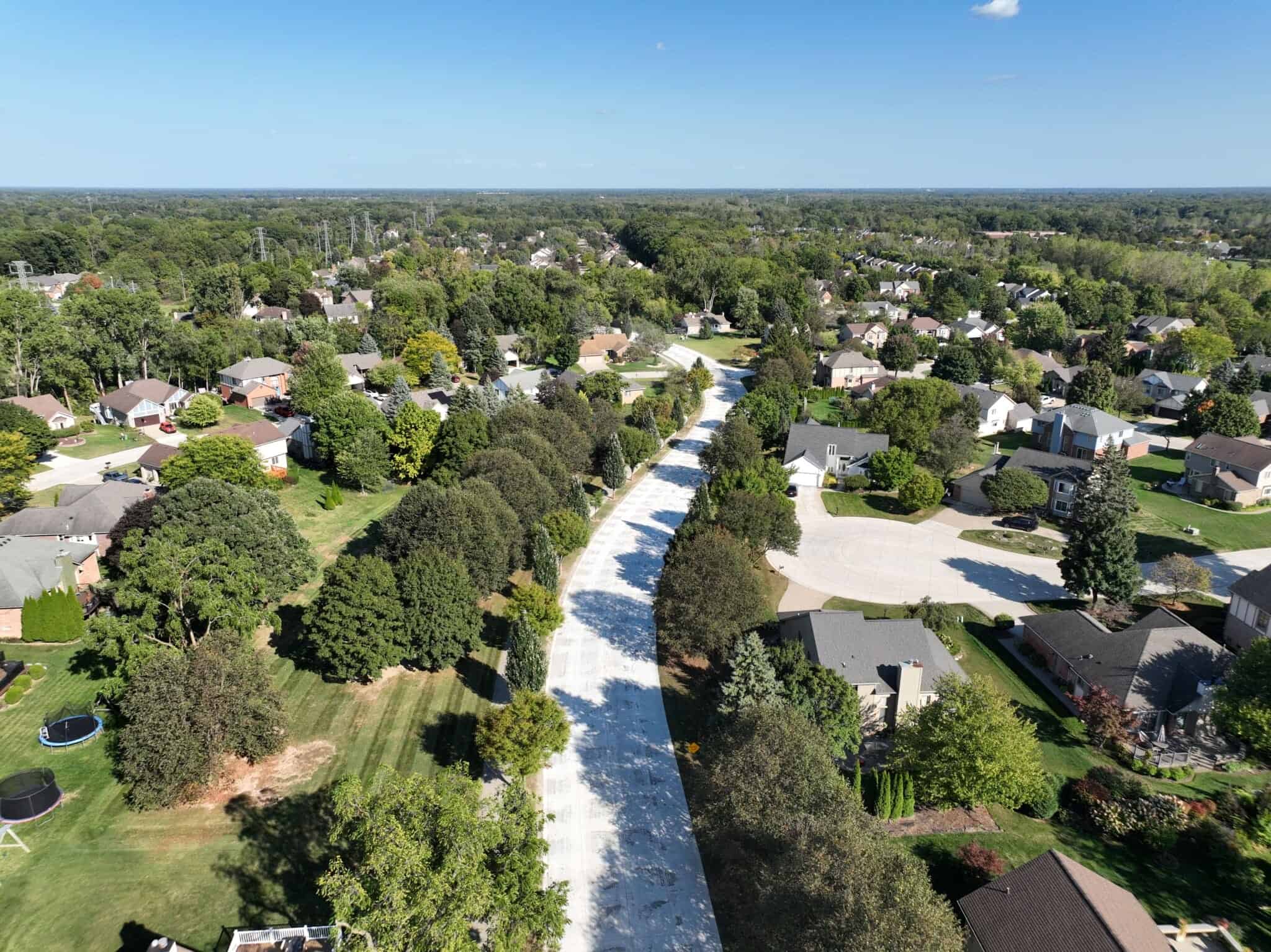

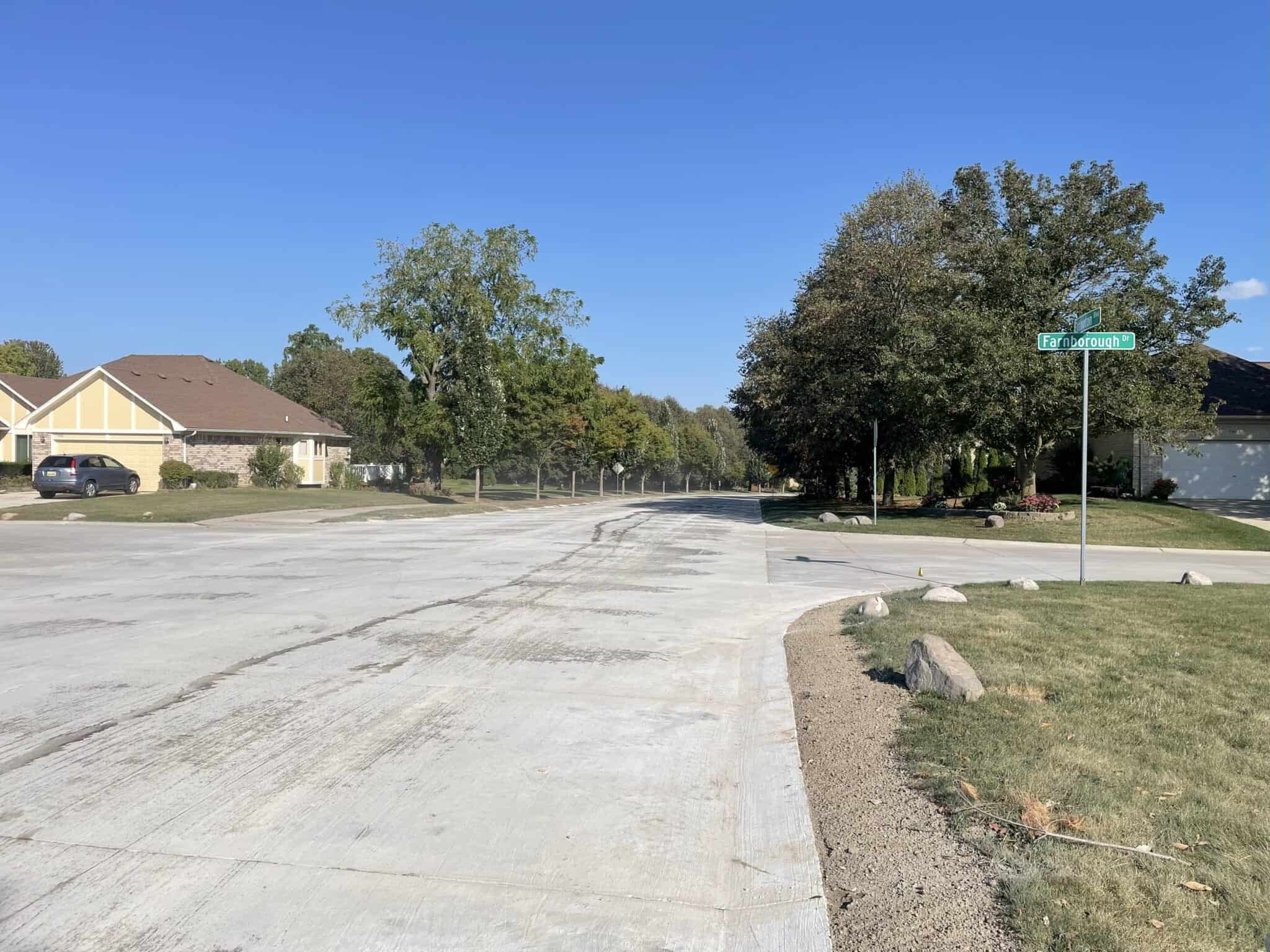

Eddington Boulevard at Farnborough Drive - September 26th.
Residents: Please try to park all vehicles in your driveway this week during the pavement joint sealing activities on your street.
Eddington Boulevard (All phases) Farnborough to Essex
- Site cleanup.
- Saw cutting and sealing pavement joints.
- Speed hump installation early October.
- Saw cutting and sealing pavement joints.
- Site cleanup.
- Saw cutting and sealing pavement joints.
- Complete.
- Site cleanup.
- Saw cutting and sealing pavement joints.
- Site cleanup.
- Saw cutting and sealing pavement joints.
- New pavement is open to traffic.
- Site cleanup.
- Saw cutting and sealing pavement joints.
- Backfilling curb and working on restoration.
- Site cleanup.
- Saw cutting and sealing pavement joints.
- Concrete sidewalk repairs are complete - Rookery woods. Restoration to follow.
- Concrete sidewalk repairs are complete - Clear Creek subdivision. Restoration to follow.
- Concrete sidewalk repairs are complete - East Hampton subdivision. Restoration to follow.
Eddington Boulevard at Farnborough Drive - September 26th.
Construction Update
on Sep 19, 2025
+
For the week of September 22nd:
Eddington Boulevard (Phase 1-4) Farnborough to Essex
Independence Drive/Court (Phase 1-3)

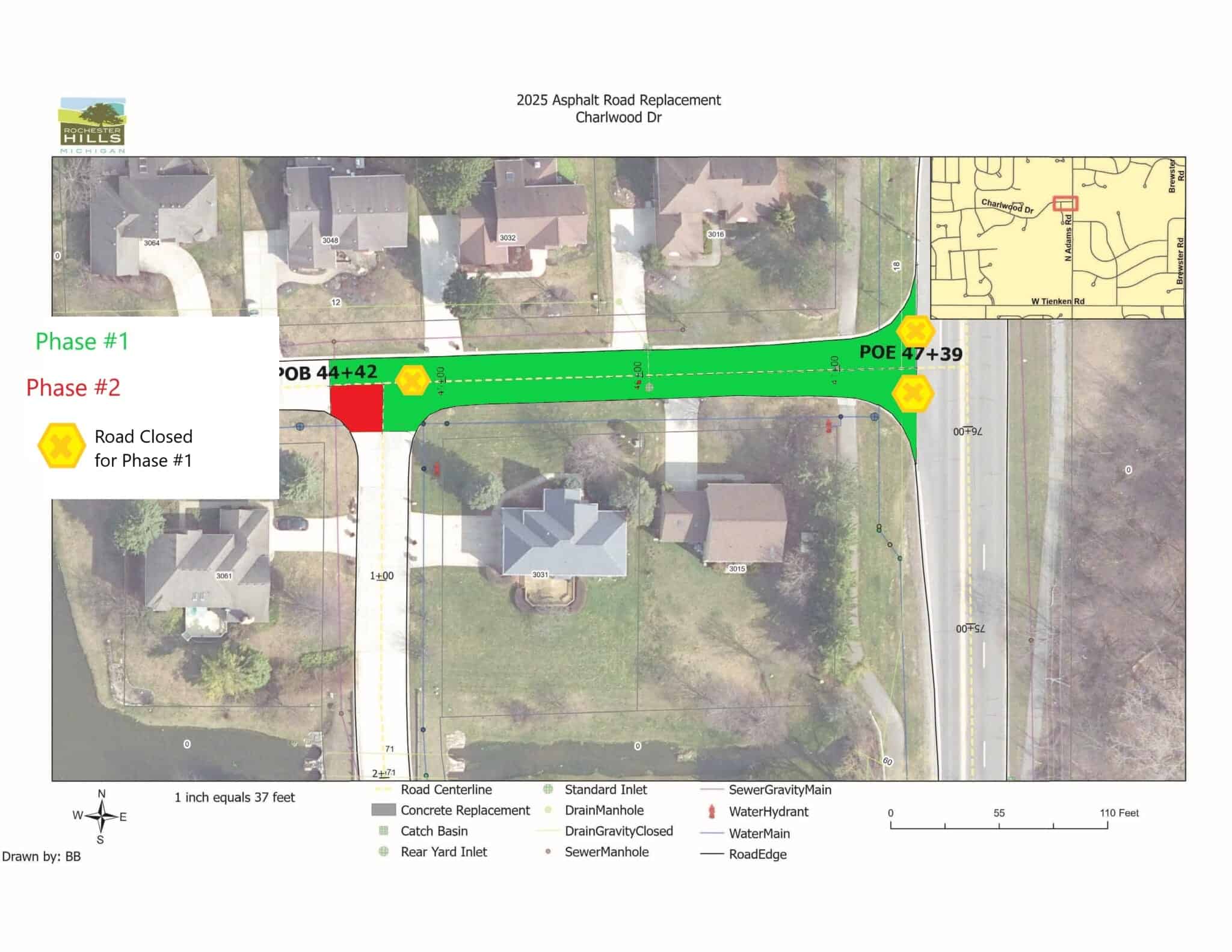

Charlwood Drive

- The new pavement is open to traffic.
- Speed humps to be installed in early October.
- The new pavement is open to traffic.
- The new pavement is open to traffic.
- Completed.
- The new pavement is open to traffic.
- Continue restoration.
- The new pavement is open to traffic.
- Waiting for concrete to obtain strength in the southwest corner of Pheasant Ring Court.
- Continue restoration.
- The new pavement is open to traffic.

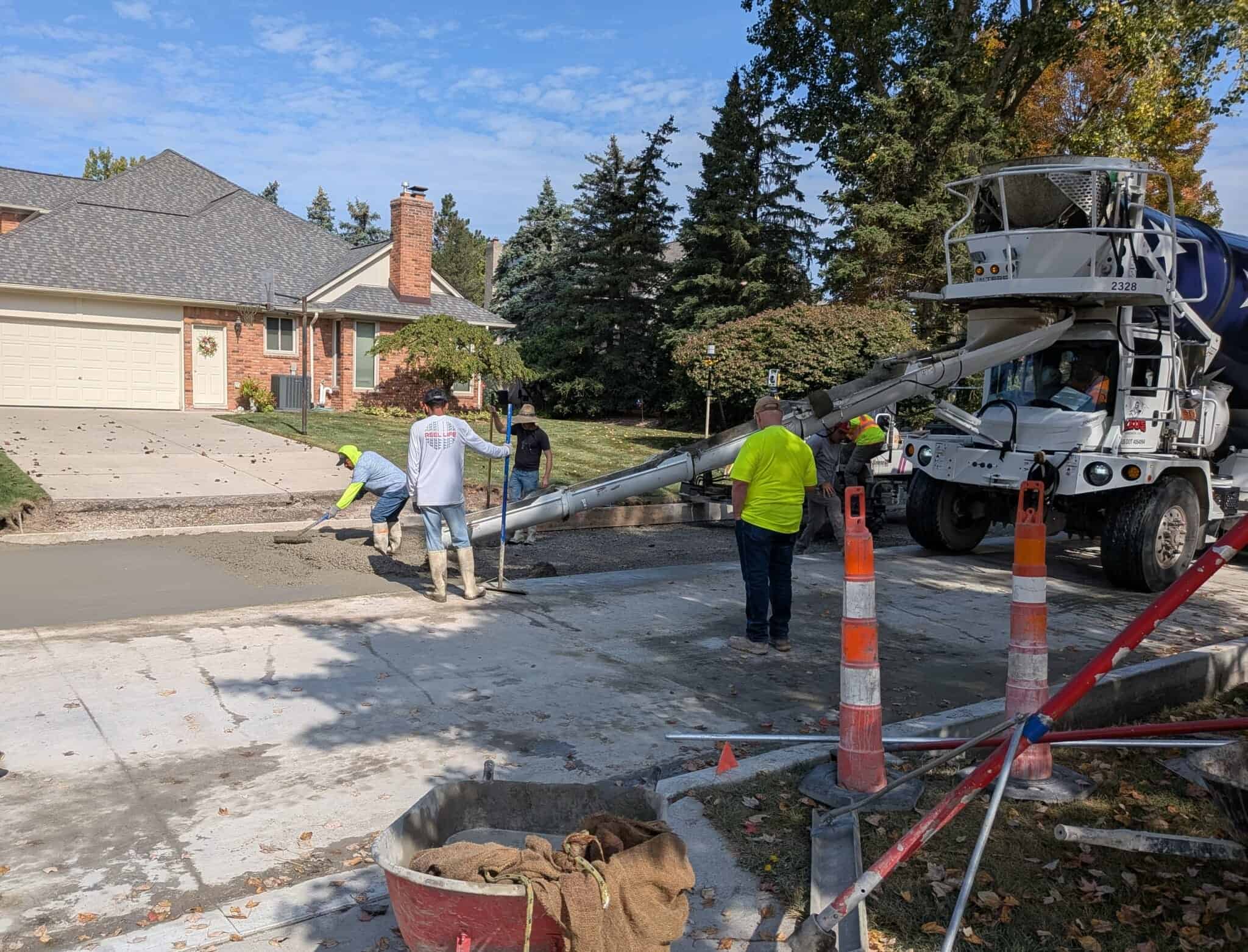

- Restoration is complete.
Independence Drive/Court (Phase 1-3)
- The new pavement is open to traffic.
- Backfilling the curb and working on restoration.
- Waiting for concrete to obtain strength.
- Pave remaining concrete driveways.
- Backfilling the curb and working on restoration.
Charlwood Drive
- Open to traffic.
- Waiting for concrete to obtain strength in the southwest corner of Charlwood Drive and Whitehouse Court.
- Complete restoration.

Construction Update
on Sep 12, 2025
+
For the week of September 15th:
Eddington Boulevard (Phase 1-4) Farnborough to Essex

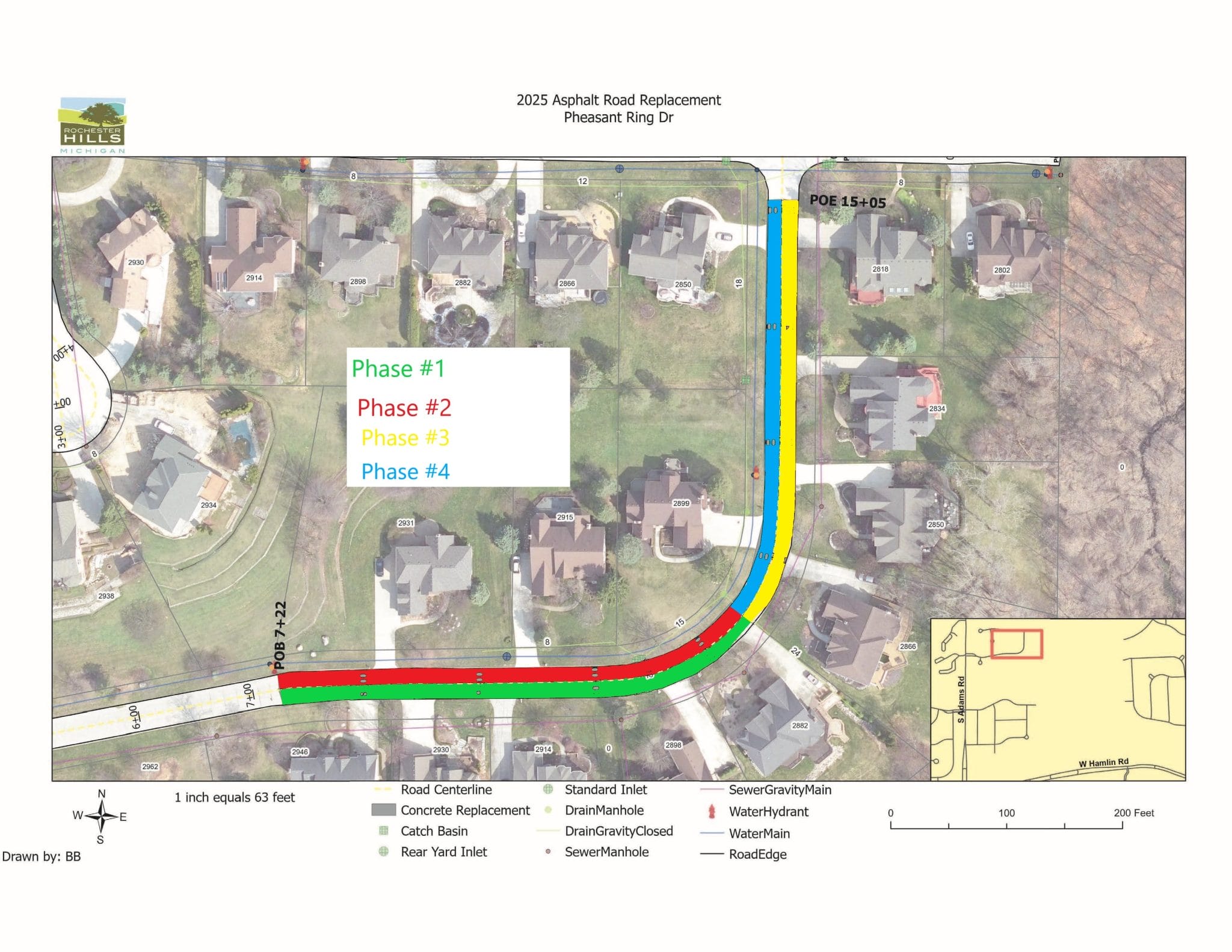

Pheasant Ring/Eagle Drive (Phase 1-4)
Cedar Shake/Lakewood Drive (Phase 1-4)
Independence Drive/Court (Phase 1-3)
Charlwood Drive

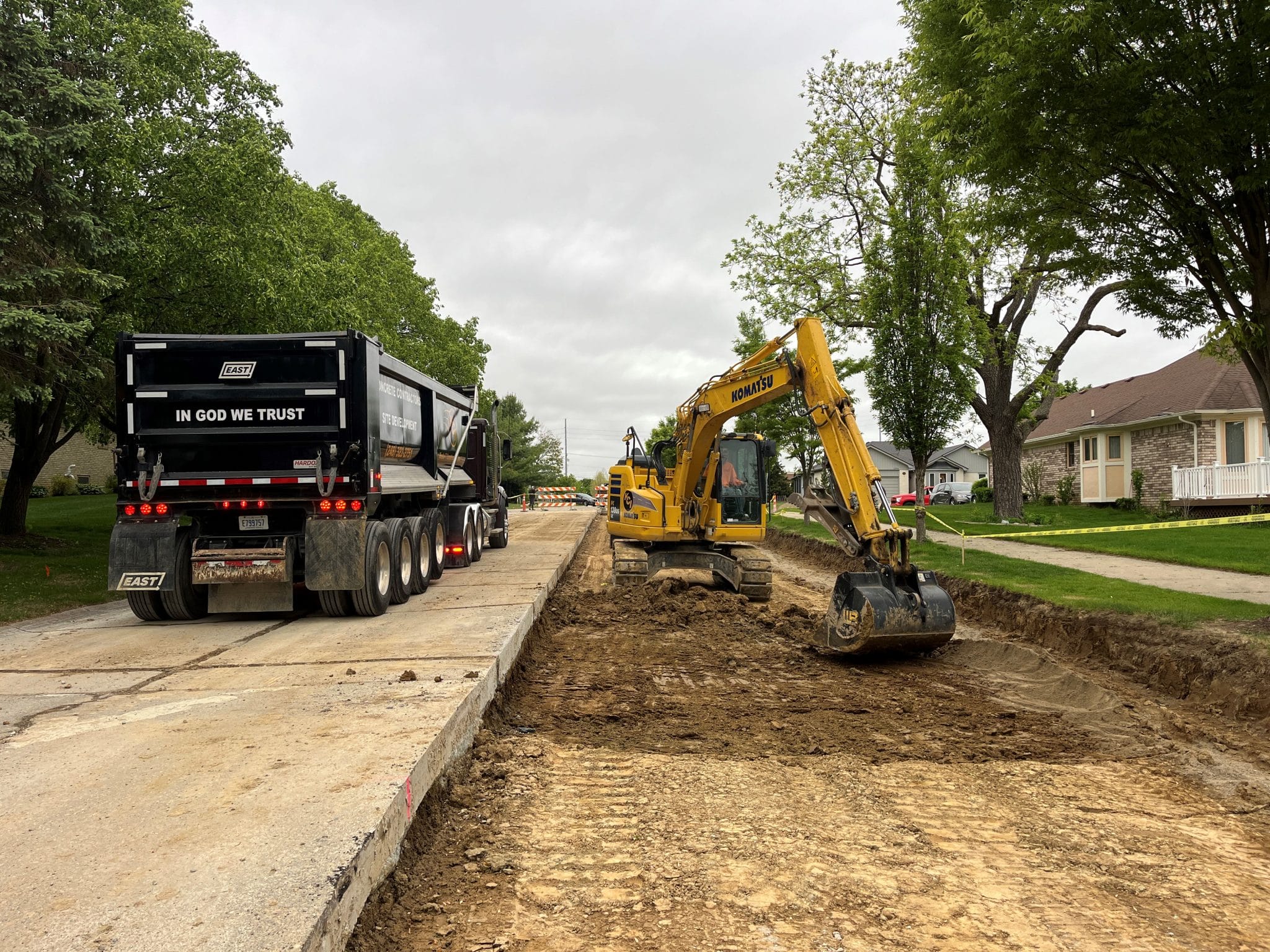

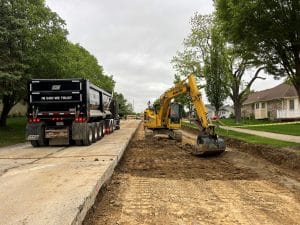

Eddington Boulevard (Phase 1-4) Farnborough to Essex
- The new pavement is open to traffic.
- Speed hump installation to be determined.
- The new pavement is open to traffic.
- The new pavement is open to traffic.
- Completed.
Pheasant Ring/Eagle Drive (Phase 1-4)
- The new pavement is open to traffic.
- Continue restoration.
- The new pavement is open to traffic.
- Remove and replace remaining concrete at Pheasant Ring Court.
- Continue restoration.

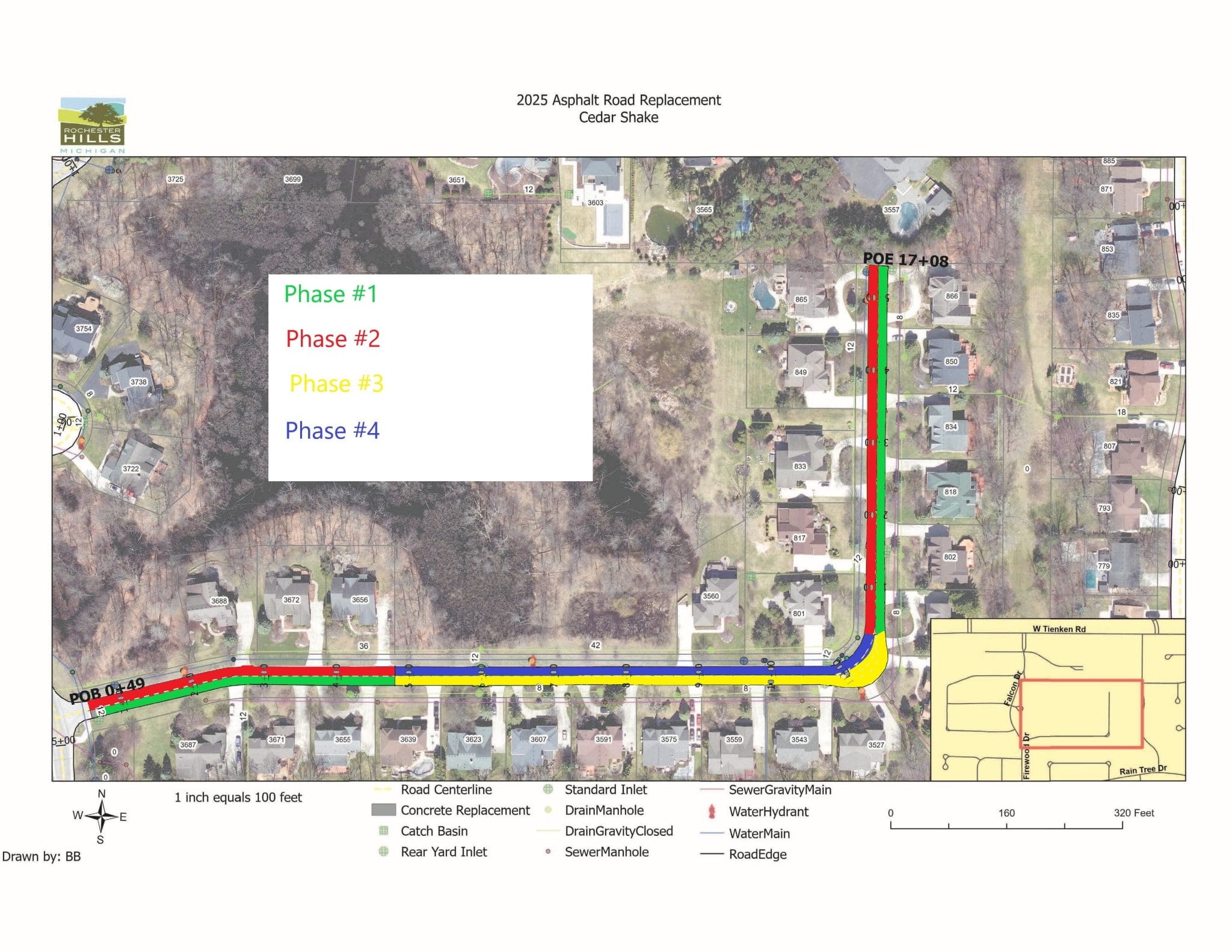

Cedar Shake/Lakewood Drive (Phase 1-4)
- The new pavement is open to traffic.
- Restoration is complete.
Independence Drive/Court (Phase 1-3)
- The new pavement is open to traffic.
- Removing concrete and earth excavation.
- Installing edge drain and placing aggregate base.
- Pave remaining concrete.
Charlwood Drive
- Open to traffic mid-week.
- Complete concrete in the southwest corner of Charlwood Dr & Whitehouse Ct to complete the intersection.

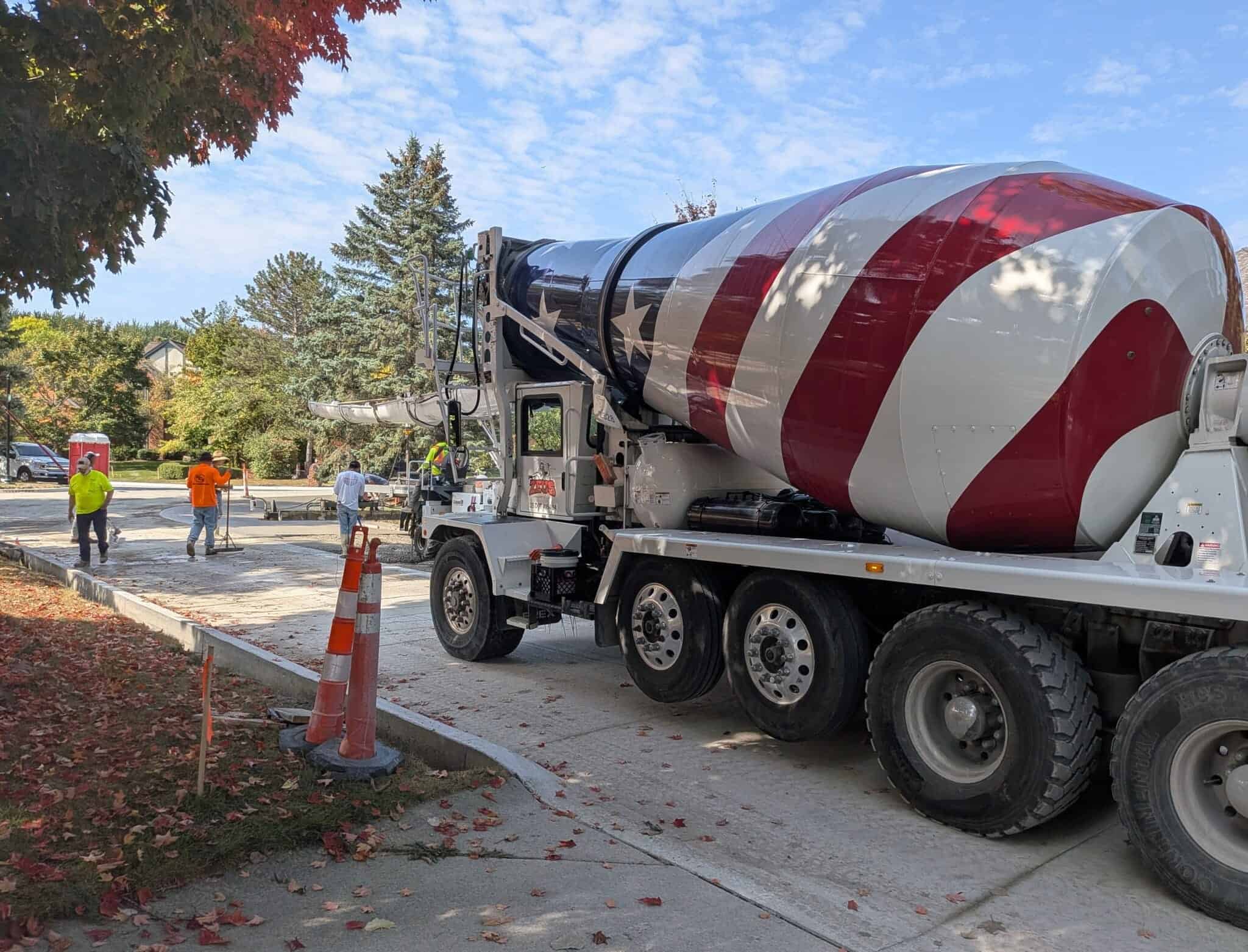

- Concrete sidewalk repairs are complete Rookery woods. Restoration to follow.
- Pouring concrete sidewalk in the Clear Creek subdivision.
- Pouring concrete sidewalk in the East Hampton subdivision.
Construction Update
on Aug 08, 2025
+
For the week of August 11th, 2025
Eddington Boulevard (Phases 1 & 2) Farnborough to Windrift
Flanders Drive (Phase 1 & 2)
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phases 1 & 2)
Cedar Shake/Lakewood Drive (Phases 1 & 2)
Independence Drive/Court (Phase 1)
Eddington Boulevard (Phases 1 & 2) Farnborough to Windrift
- New pavement is open to traffic.
- New pavement is open to traffic.
- Continue restoration.
- Open the new pavement to traffic.
- Continue restoration.
Flanders Drive (Phase 1 & 2)
- New pavement is open to traffic.
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple
- New pavement is open to traffic.
- New pavement is open to traffic.
- Continue restoration.
- Open to new pavement.
- Pour driveways.
- Continue restoration.
- Complete.
Pheasant Ring/Eagle Drive (Phases 1 & 2)
- New pavement is open to traffic.
- Installing aggregate base and concrete forms.
- Begin paving.
Cedar Shake/Lakewood Drive (Phases 1 & 2)
- New pavement is open to traffic.
- Placing aggregate base and installing concrete forms.
- Begin paving.
Independence Drive/Court (Phase 1)
- New pavement is open to traffic .
- Begin removing pavement and earth excavation.
- Begin removals in the Rookery Woods subdivision.
Construction Update

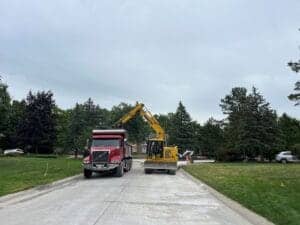

on Aug 29, 2025
+
Construction schedule for the week of September 1st:
No work Labor Day Monday 9/1/25
Eddington Boulevard (Phase 1-4) Farnborough to Essex
Pheasant Ring/Eagle Drive (Phase 1-3)
Cedar Shake/Lakewood Drive (Phase 1 & 2)
Independence Drive/Court (Phase 1)
Charlwood Drive
- The new pavement is open to traffic.
- Speed Hump installation TBD.
- New pavement is open to traffic.
- New pavement is open to traffic.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1-3)
- New pavement is open to traffic.
- Continue paving the final section of concrete
- Paving the final section of concrete.
Cedar Shake/Lakewood Drive (Phase 1 & 2)
- New pavement is open to traffic.
- Open new pavement to traffic.
- Placing aggregate base and installing concrete forms.
- Paving remaining concrete.
Independence Drive/Court (Phase 1)
- New pavement is open to traffic.
- New pavement is open to traffic.
- Installing Edge Drain and placing aggregate base.
Charlwood Drive
- Removing pavement and earth excavation.
- Concrete sidewalk repairs are complete Rookery woods. Restoration to follow.
- Clear Creek and East Hampton TBD

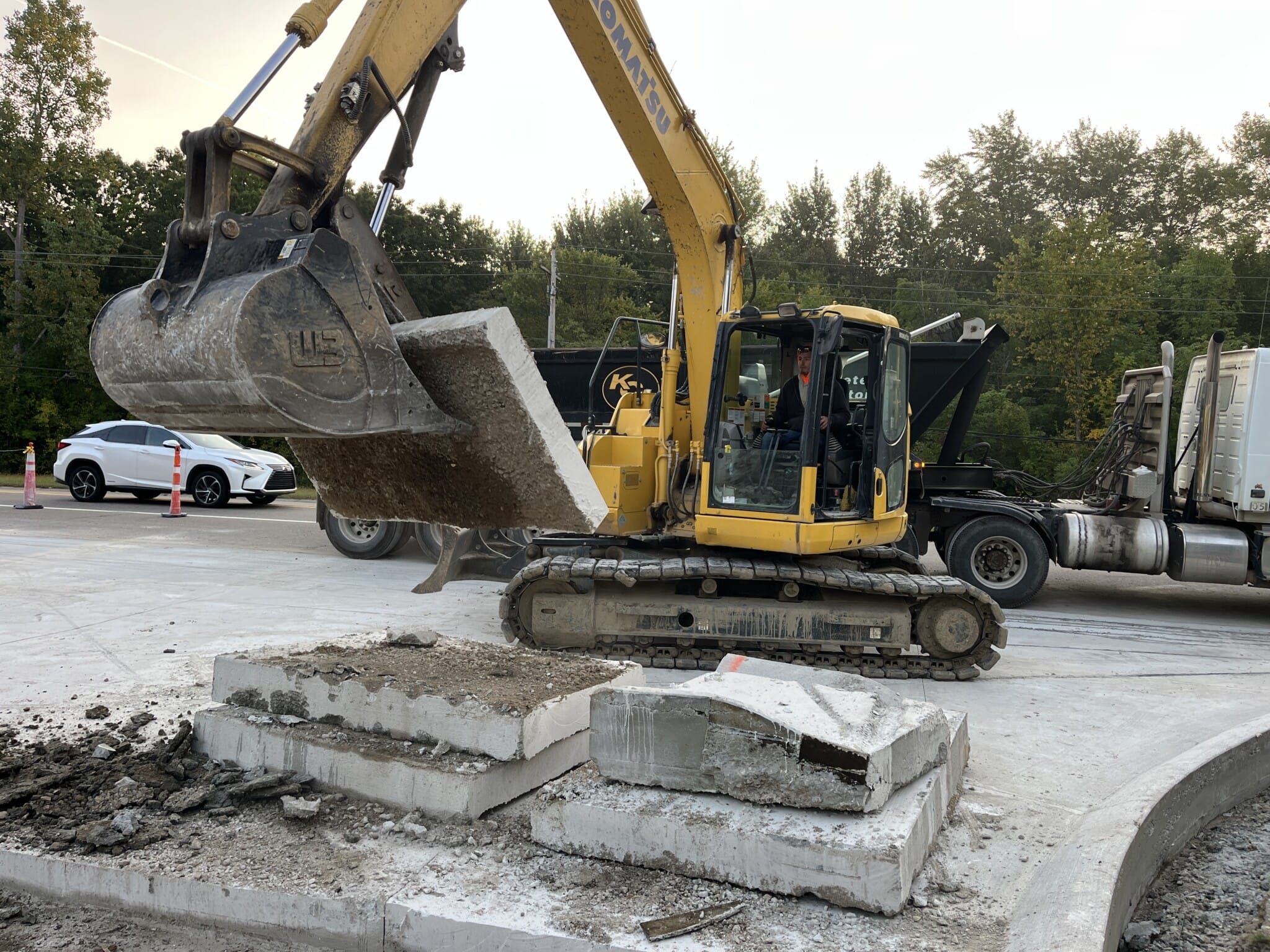

Starting pavement removals. Southbound Independence Drive.
Placing sand over recently installed edge drain pipe within excavated trench. Southbound Independence Drive.
Compacting the sand backfill over edge drain ahead of aggregate base placement. Westbound Cedar Shake Drive.
Construction Update
on Aug 22, 2025
+
For the week of August 25th, 2025:
Eddington Boulevard (Phase 1-4) Farnborough to Essex
Pheasant Ring/Eagle Drive (Phase 1-3)
Cedar Shake/Lakewood Drive (Phase 1 & 2)
Independence Drive/Court (Phase 1)
- The new pavement is open to traffic.
- Continue restoration.
- New pavement is open to traffic.
- New pavement is open to traffic.
- Continue restoration.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1-3)
- New pavement is open to traffic.
- Trimming aggregate base and placing concrete forms.
- Begin paving the final section of concrete.
- Trimming aggregate base and placing concrete form.
- Begin paving the final section of concrete.
Cedar Shake/Lakewood Drive (Phase 1 & 2)
- New pavement is open to traffic.

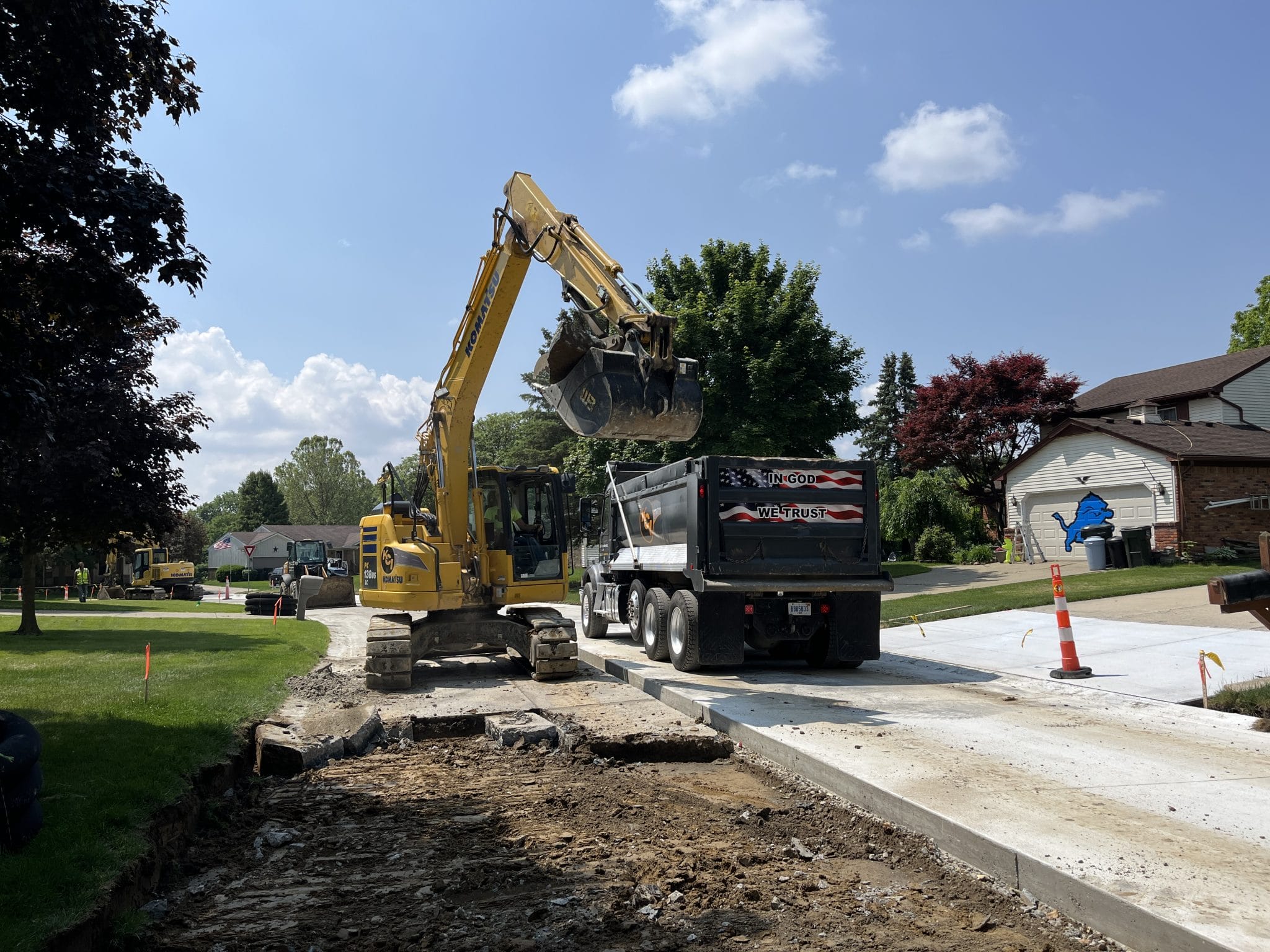

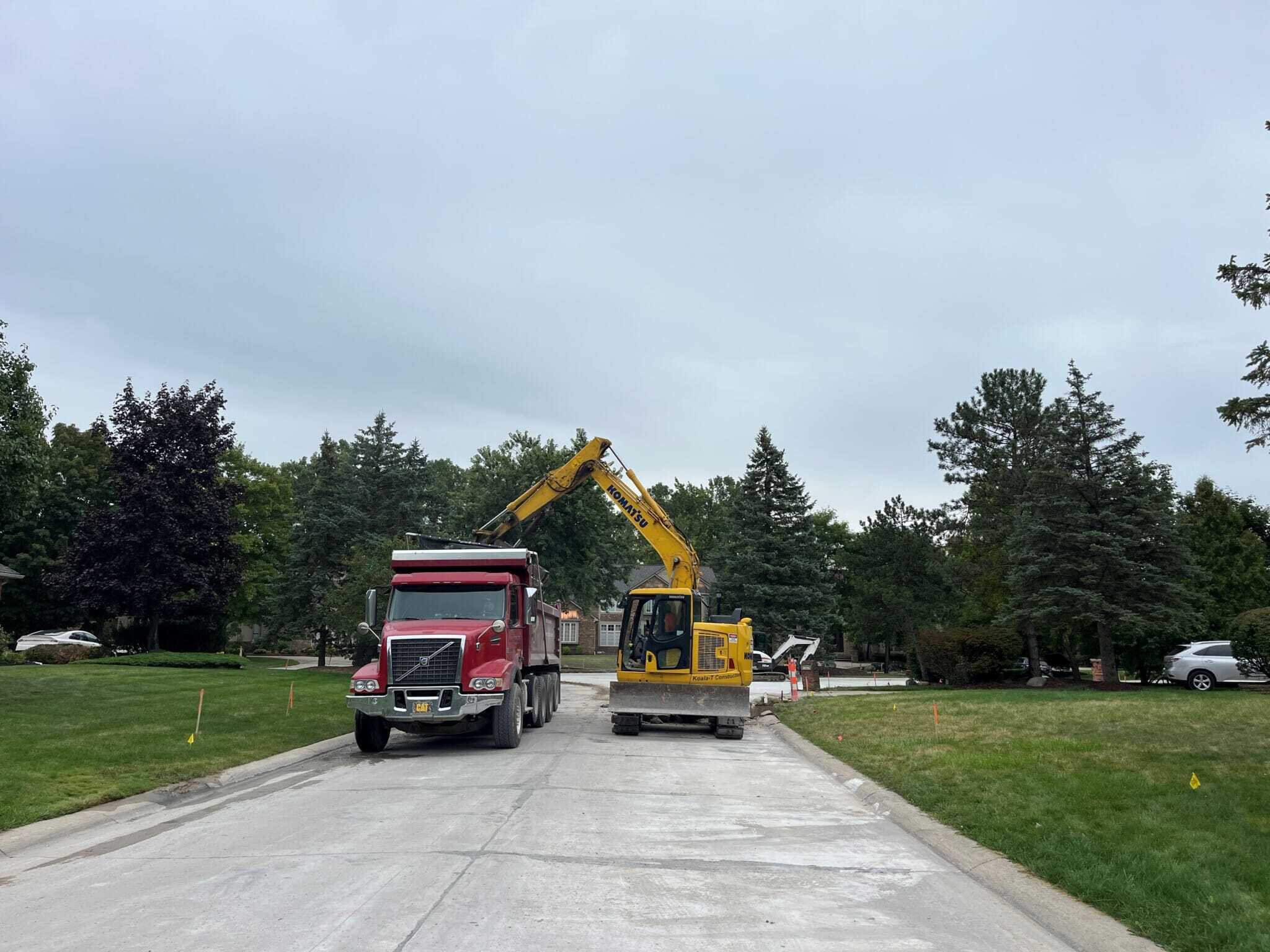

- Open new pavement to traffic.

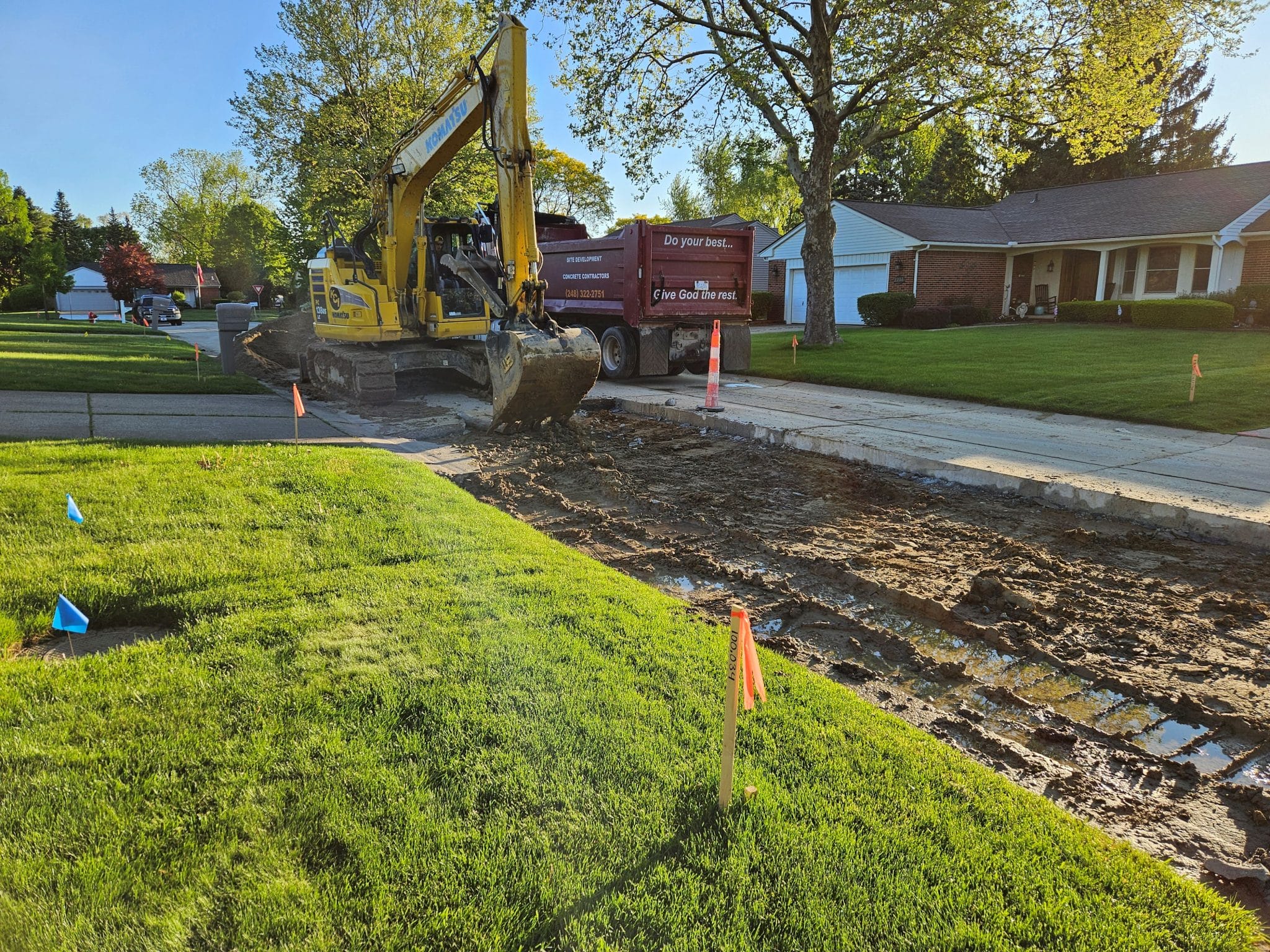

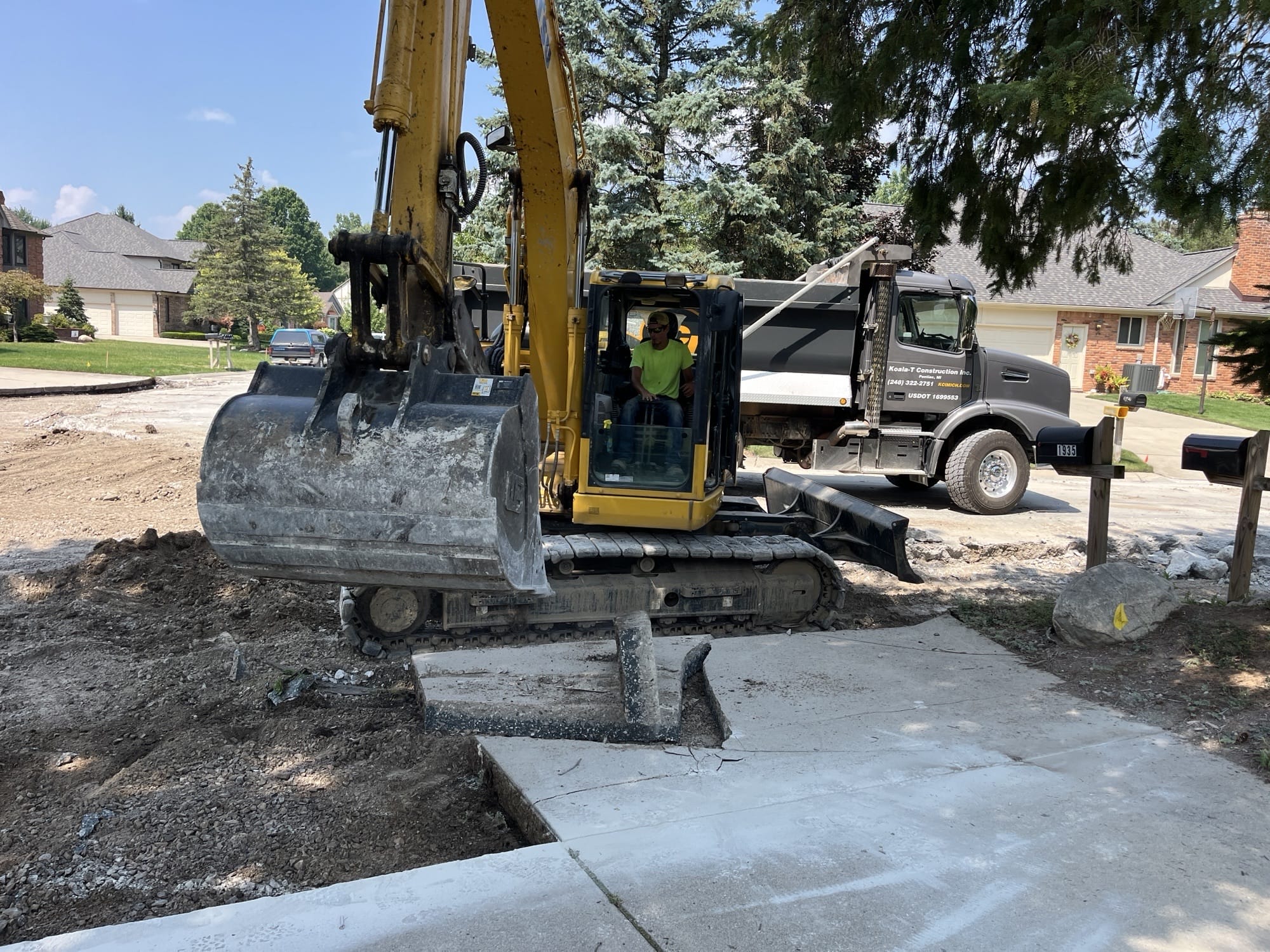

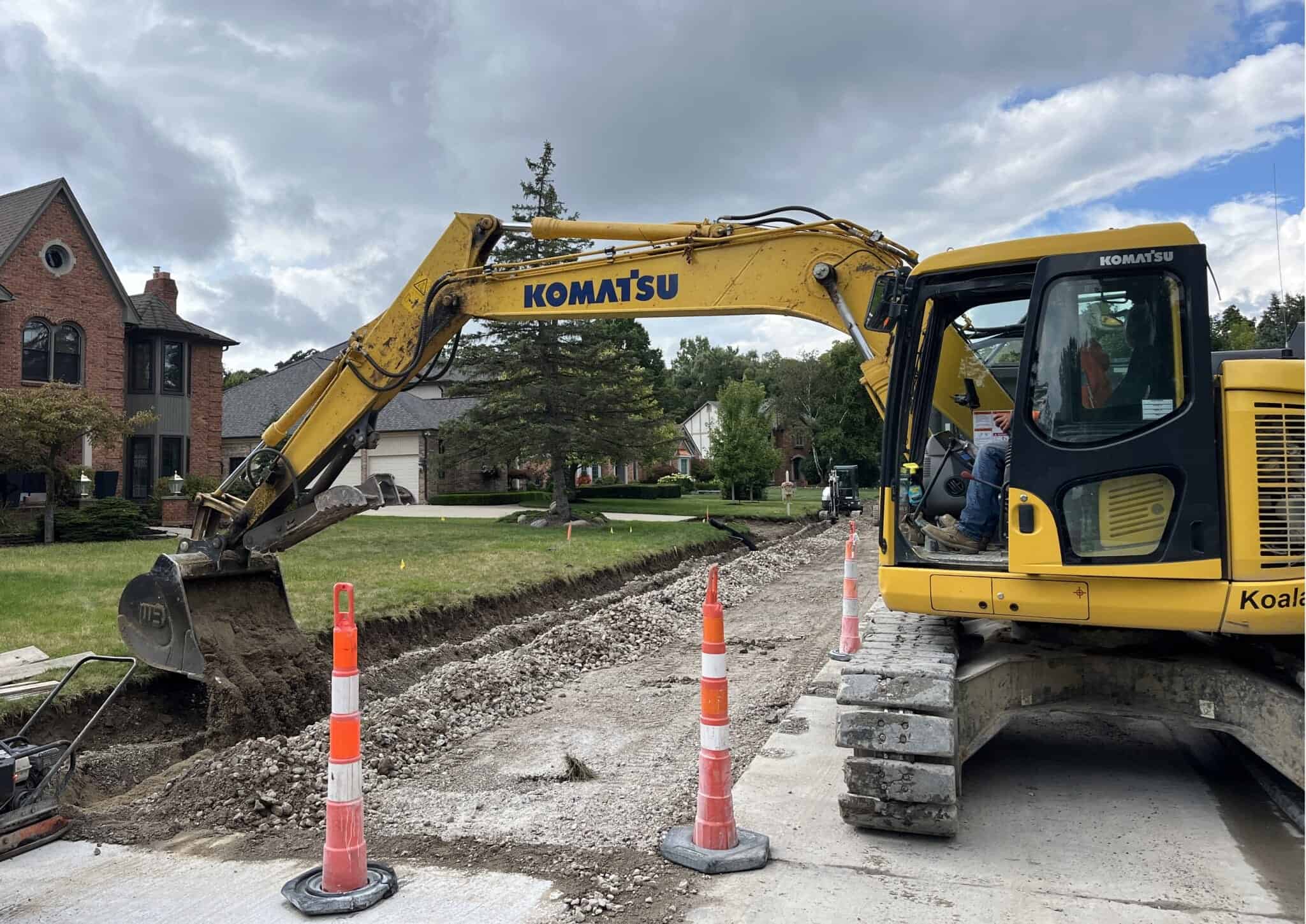

- Removing pavement and earth excavation.

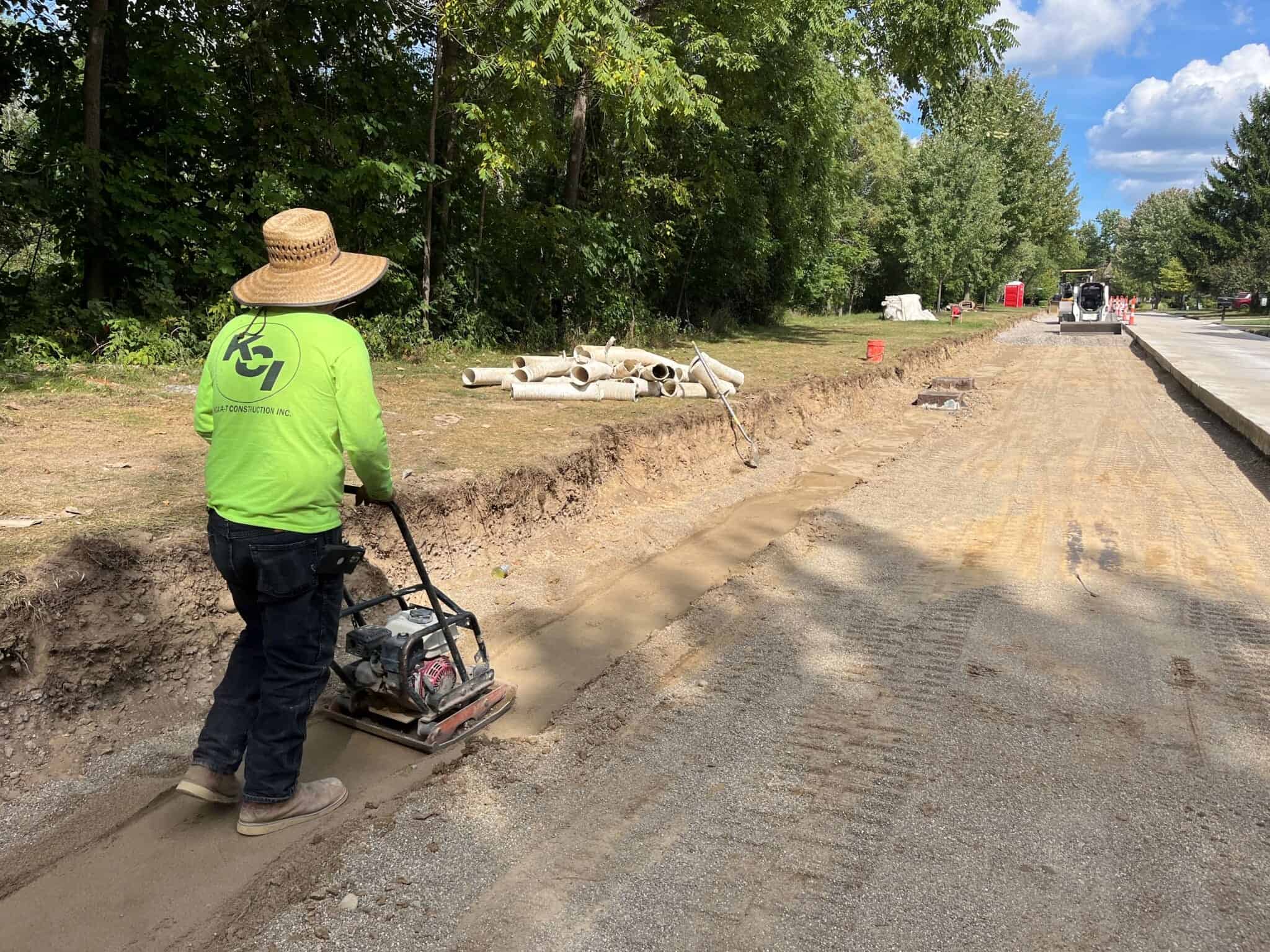

- Installing edge drain and aggregate base.
Independence Drive/Court (Phase 1)
- New pavement is open to traffic.
- Allow cure time for new concrete.

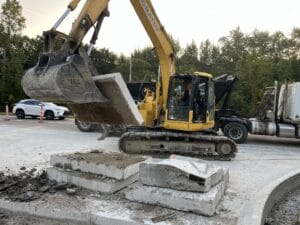

- Begin removing pavement and earth excavation

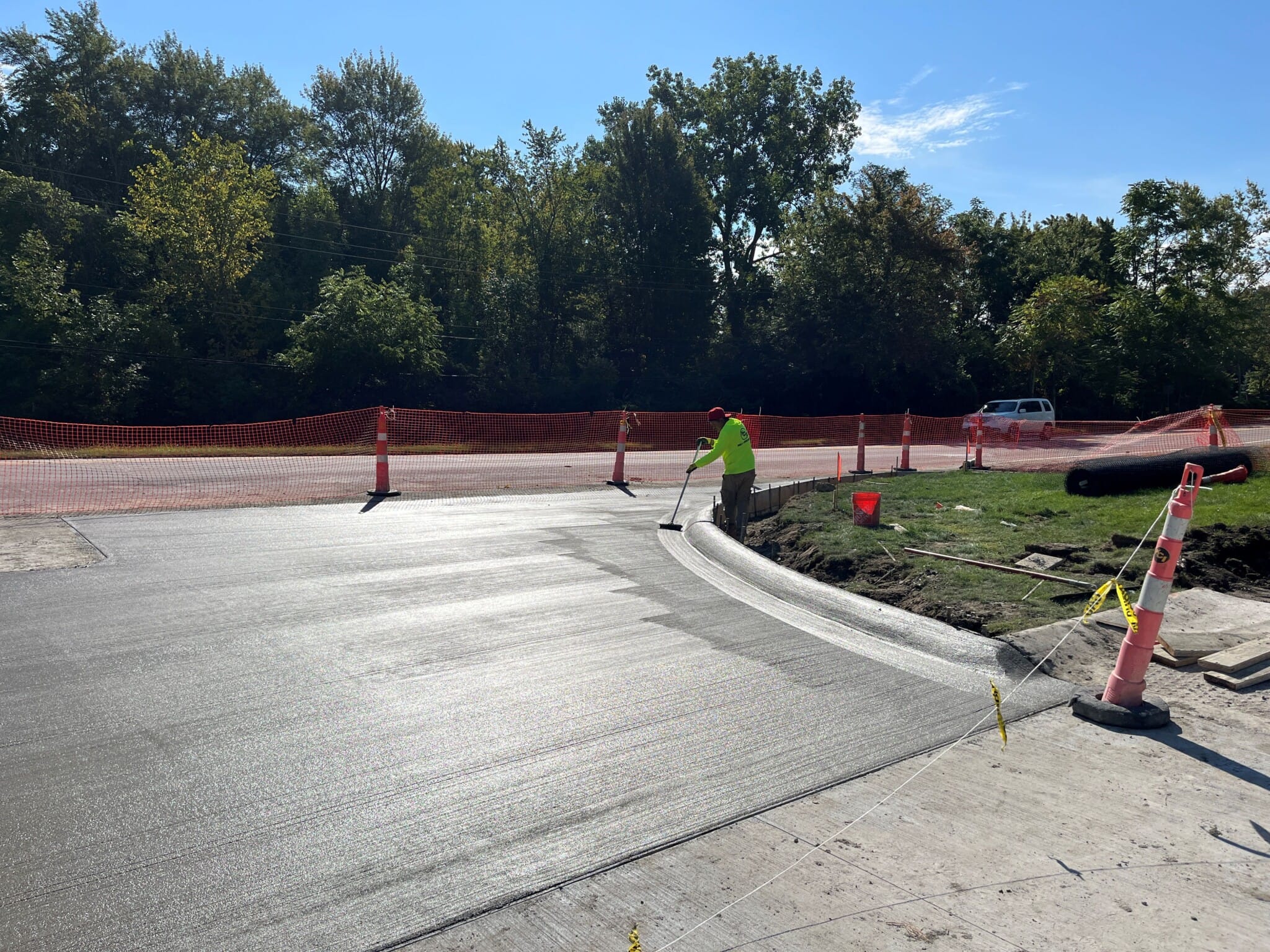

- Concrete sidewalk repairs are complete Rookery woods. Restoration to follow.
Construction Update
on Aug 15, 2025
+
For the week of August 18th, 2025
Eddington Boulevard (Phases 1 & 2) Farnborough to Windrift
Flanders Drive (Phase 1 & 2)
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phases 1 & 2)
Cedar Shake/Lakewood Drive (Phases 1,2, & 3)
Independence Drive/Court (Phase 1)

Eddington Boulevard (Phases 1 & 2) Farnborough to Windrift
- New pavement is open to traffic.
- New pavement is open to traffic.
- Continue restoration.
Flanders Drive (Phase 1 & 2)
- New pavement is open to traffic.
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple
- New pavement is open to traffic.
- New pavement is open to traffic.
- Continue restoration.
- Complete.
Pheasant Ring/Eagle Drive (Phases 1 & 2)
- New pavement is open to traffic.
- New pavement is open to traffic.
- Begin removing pavement and earth excavation.
- Install edge drain and aggregate base.
- New pavement is open to traffic.
- Begin removing pavement and earth excavation.
Cedar Shake/Lakewood Drive (Phases 1,2, & 3)
- New pavement is open to traffic.
- Begin removing pavement and earth excavation.
Independence Drive/Court (Phase 1)
- New pavement is open to traffic .

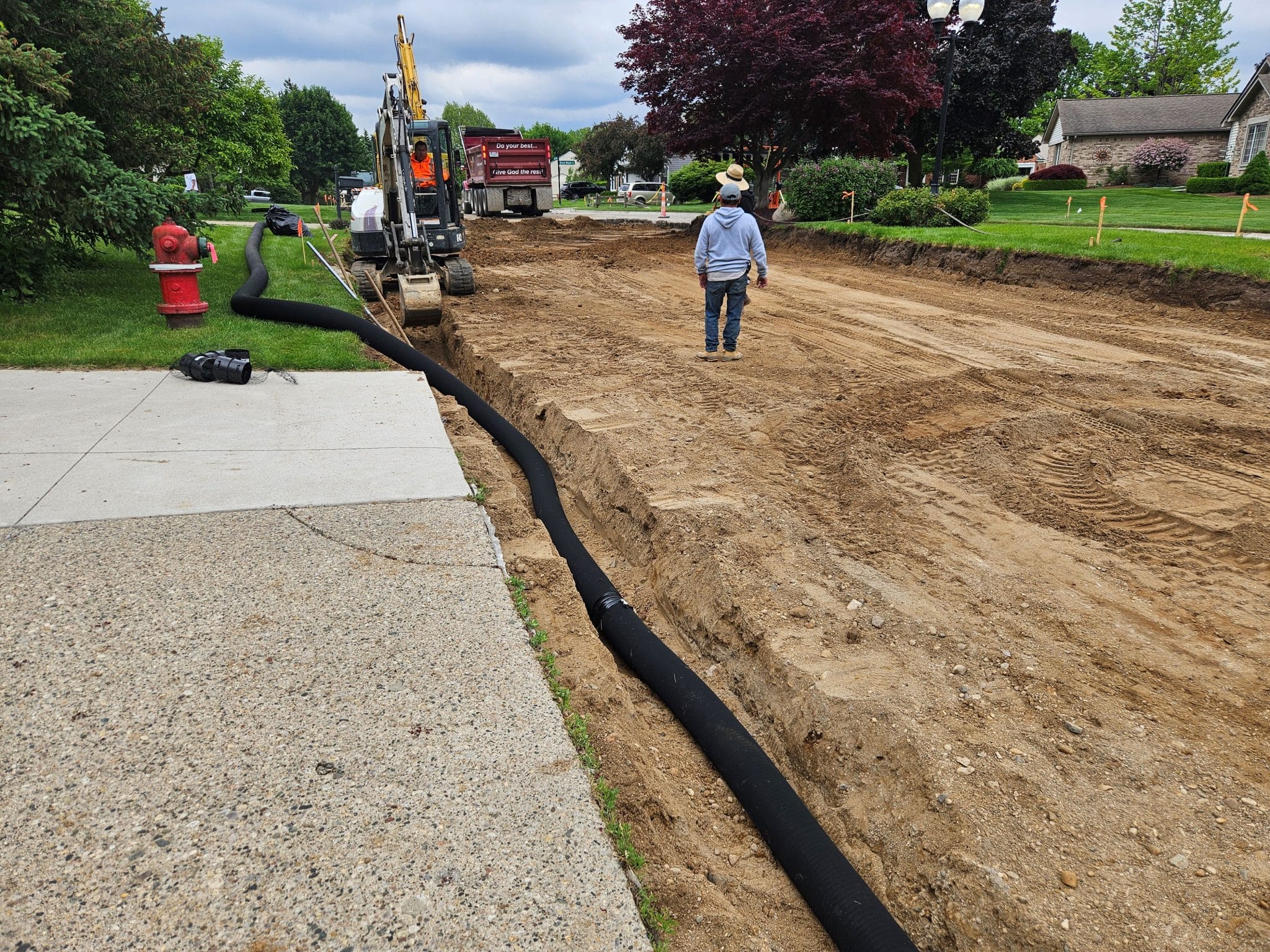

- Installing edge drain and aggregate base south of Dutton Road.
- Begin paving.
- Concrete sidewalk repairs are complete in the Rookery Woods. Restoration to follow.

Construction Update
on Sep 05, 2025
+
Construction schedule for the week of September 8th:
Eddington Boulevard (Phase 1-4) Farnborough to Essex

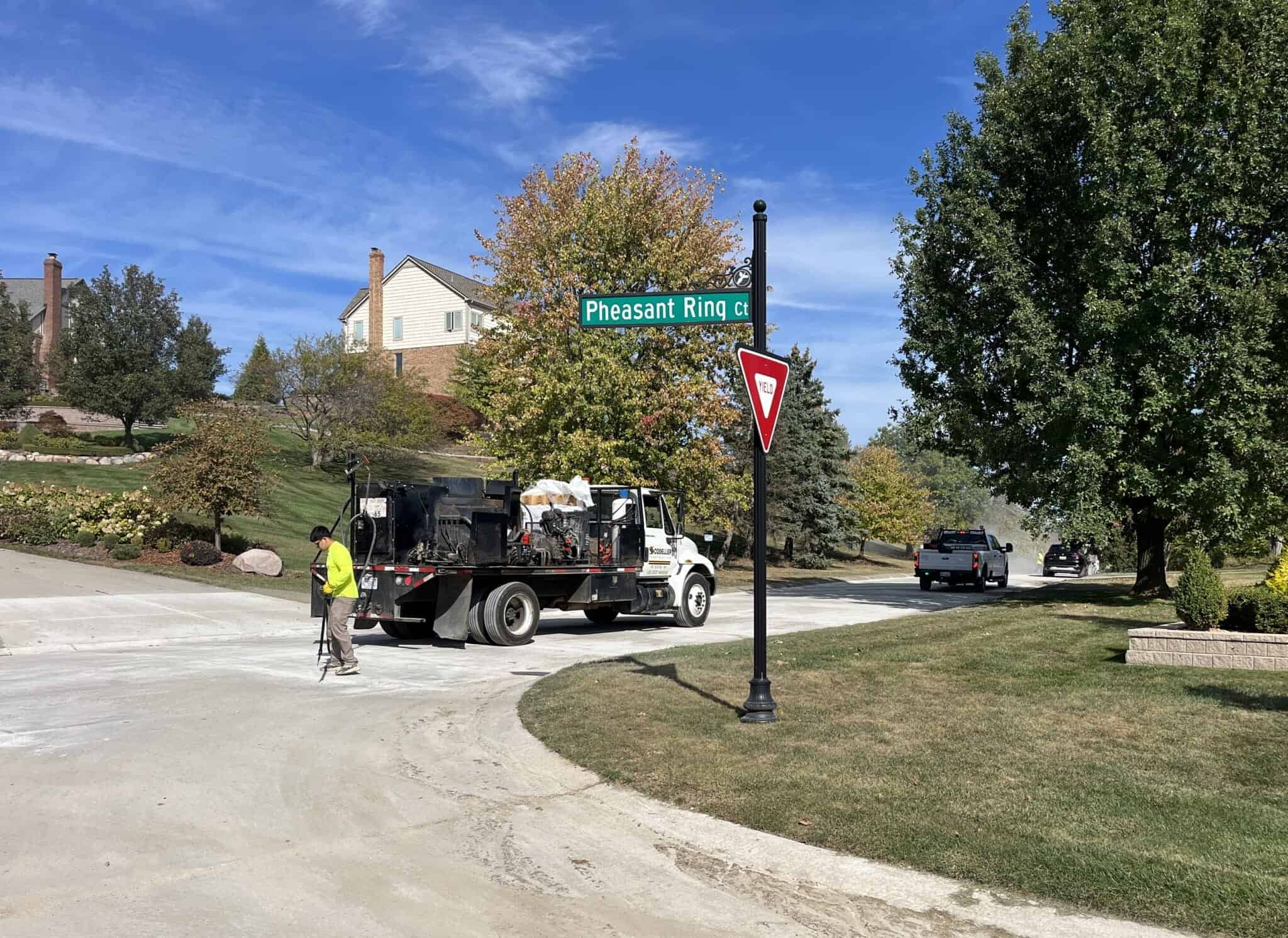

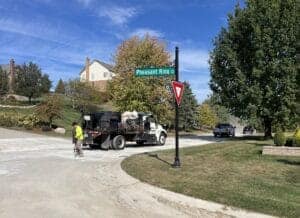

Pheasant Ring/Eagle Drive (Phase 1-3)
Cedar Shake/Lakewood Drive (Phases 1, 2 & 3)
Independence Drive/Court (Phases 1 & 2)
Charlwood Drive
- The new pavement is open to traffic.
- Speed Hump installation TBD.
- New pavement is open to traffic.
- New pavement is open to traffic.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1-3)
- New pavement is open to traffic.
- Continue restoration.
- Allow cure time for final section of new pavement.
- Allow cure time for final section of new pavement.
Cedar Shake/Lakewood Drive (Phases 1, 2 & 3)
- New pavement is open to traffic.
- Continue restoration.
- Allow for cure time for final section of new pavement.
Independence Drive/Court (Phases 1 & 2)
- New pavement is open to traffic.
- Paving concrete.
- Allow cure time for new concrete.
Charlwood Drive
- Place aggregate base and concrete forms.

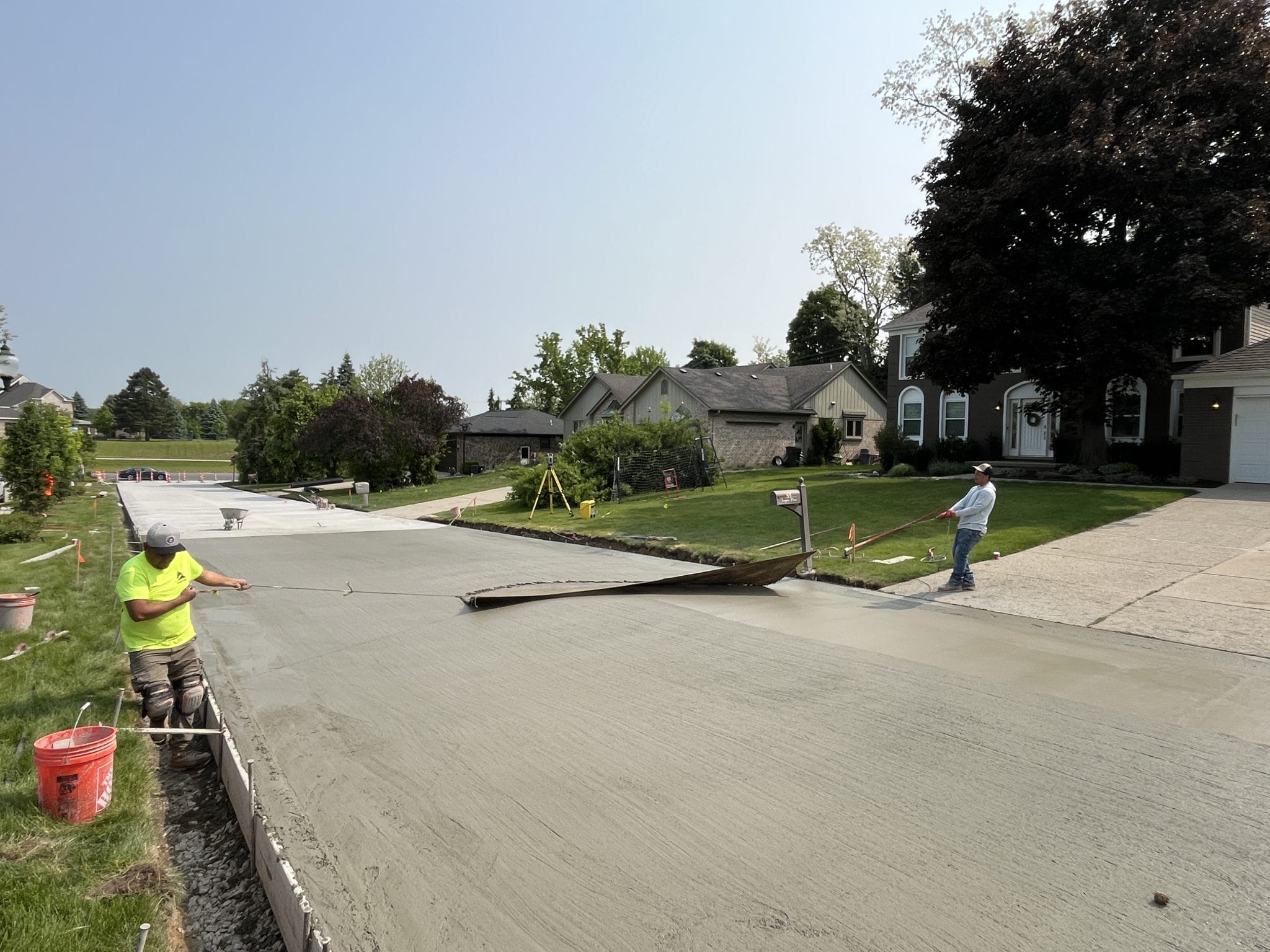

- Pave concrete.
- Concrete sidewalk repairs are complete in Rookery woods. Restoration to follow.
- Begin removing sidewalk in the Clear Creek subdivision.
- East Hampton TBD.
Construction Update
on Aug 01, 2025
+
For the week of August 4th, 2025
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
Flanders Drive (Phase 1 & 2)
Sugar Pine Road (Phase 1, 2, & 3) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phase 1)
Cedar Shake/Lakewood Drive (Phase 1)
Independence Drive/Court (Phase 1)
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
- New pavement is open to traffic.
- New pavement is open to traffic.
- Backfilling behind curb with dirt.
- Open the new pavement to traffic.
- Pour driveway approaches.
- Backfilling behind curb with dirt.
Flanders Drive (Phase 1 & 2)
- New pavement is open to traffic.
Sugar Pine Road (Phase 1, 2, & 3) Walton to Black Maple
- New pavement is open to traffic.
- Complete paving the northbound lane.
- Waiting for cure time on the new pavement.
- Prepare concrete drive approaches.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1)
- New pavement is open to traffic.
- Open to traffic.
- Pour driveway approaches.
- Remove pavement and earth excavation.
- Install edge drain and aggregate base.
Cedar Shake/Lakewood Drive (Phase 1)
- New pavement is open to traffic.
- Open to Traffic.
- Pour concrete driveway approaches.
- Begin removing pavement and earth excavation.
Independence Drive/Court (Phase 1)
- Install edge drain and aggregate base.
- Begin paving.
- Removals are scheduled to start the week of August 12th
Construction Update
on Jul 28, 2025
+
For the week of July 28th, 2025
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
Flanders Drive (Phase 1 & 2)
Sugar Pine Road (Phase 1, 2, & 3) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phase 1)
Cedar Shake/Lakewood Drive (Phase 1)
Independence Drive/Court
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
- New pavement is open to traffic.
- New pavement is open to traffic.
- Complete paving.
- Waiting for cure time on new pavement.
Flanders Drive (Phase 1 & 2)
- New pavement is open to traffic.
Sugar Pine Road (Phase 1, 2, & 3) Walton to Black Maple
- New pavement is open to traffic.
- Paving northbound lane.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1)
- New pavement is open to traffic
- Open to traffic.
- Begin removing pavement.
Cedar Shake/Lakewood Drive (Phase 1)
- New pavement is open to traffic.
- Prepare driveway approaches.
- Open to Traffic.
- Prepare driveway approaches.
Independence Drive/Court
- Removing pavement and earth excavation.
- Installing edgedrain and aggregate base.
- Removals are scheduled to start the week of August 12th
Construction Update
on Jul 18, 2025
+
For the week of July 21st, 2025
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
Flanders Drive (Phase 1 & 2)
Sugar Pine Road (Phase 1 & 2) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phase 1)
Cedar Shake/Lakewood Drive (Phase 1)
Independence Drive/Court (Phase 1)
Applying curing compound over new concrete pavement on Westbound Pheasant Ring Drive
Installing form boards along proposed curb line on westbound Cedar Shake.

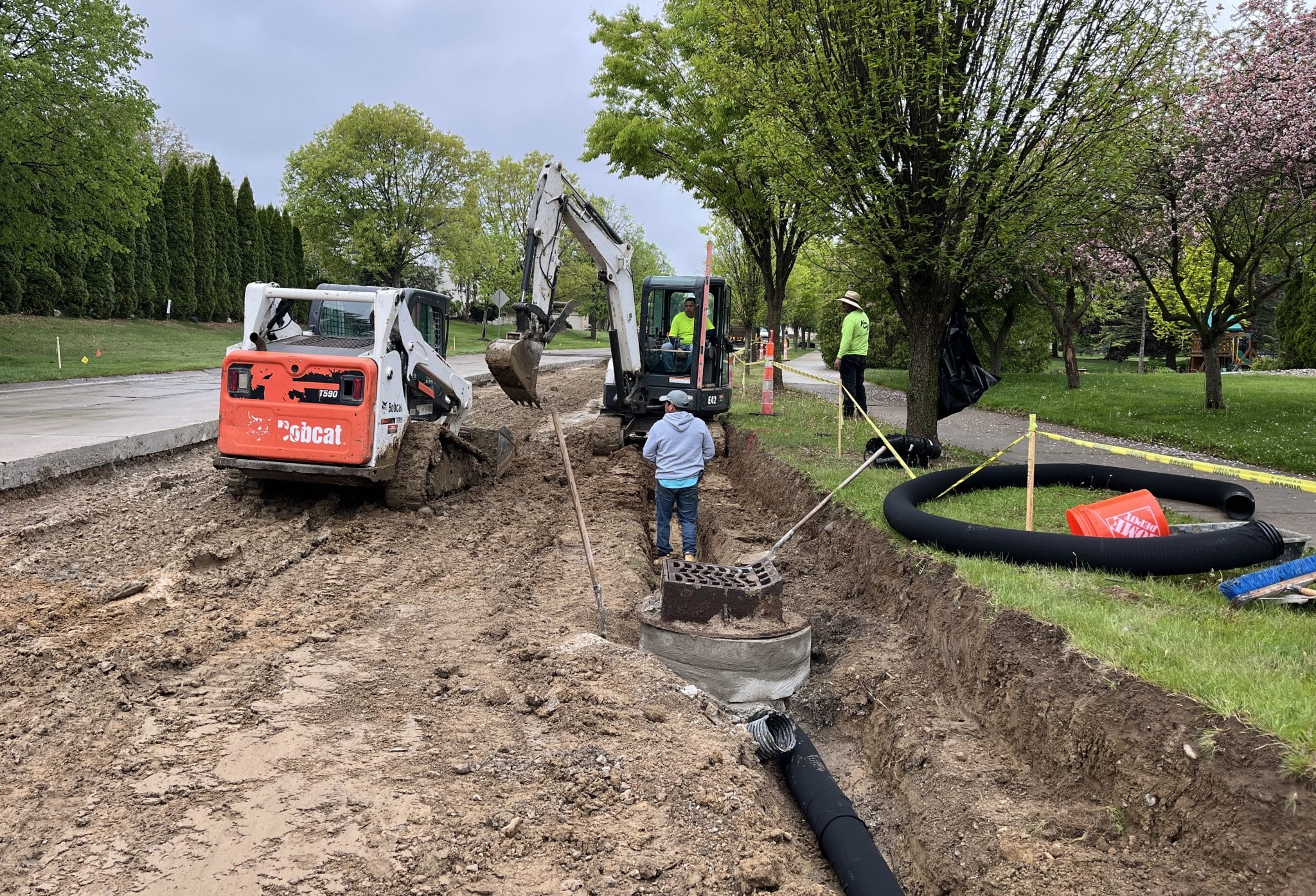

Placing sand over the top of the recently placed edge drain pipe before compacting this backfill on Lakewood Drive.
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift
- New pavement is open to traffic.
Flanders Drive (Phase 1 & 2)
- New pavement is open to traffic.
Sugar Pine Road (Phase 1 & 2) Walton to Black Maple
- New pavement is open to traffic.
- New pavement is open to traffic.
- Pour concrete driveway approaches.
- Begin pavement removal and earth excavation.
- Begin installing edge drain and placing aggregate base.
- Complete.

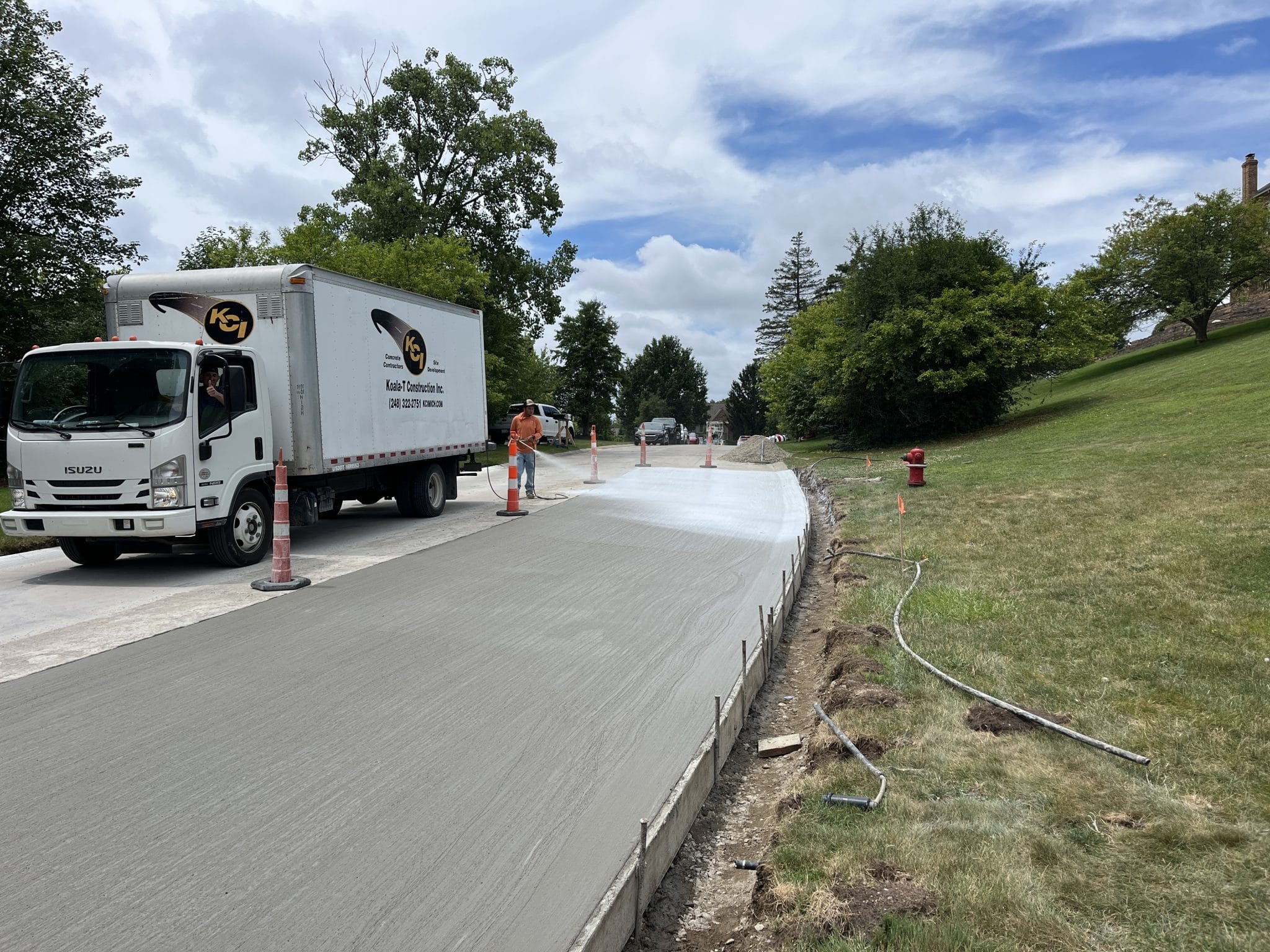

Pheasant Ring/Eagle Drive (Phase 1)
- New pavement is open to traffic
- Waiting for concrete cure time
Cedar Shake/Lakewood Drive (Phase 1)
- New pavement is open to traffic.
- Complete paving.
Independence Drive/Court (Phase 1)
- Removing pavement and earth excavation
Applying curing compound over new concrete pavement on Westbound Pheasant Ring Drive
Installing form boards along proposed curb line on westbound Cedar Shake.
Placing sand over the top of the recently placed edge drain pipe before compacting this backfill on Lakewood Drive.
Construction Update
on Jul 11, 2025
+
For the Week of July 14th
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift -
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple -
Pheasant Ring/Eagle Drive (Phase 1) -
Cedar Shake/Lakewood Drive (Phase 1) -

Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift -
- The new pavement is open to traffic.
- The new pavement is open to traffic.
- Begin removing pavement and earth excavation.
- The new pavement is open to traffic.
Sugar Pine Road (Phases 1 & 2) Walton to Black Maple -
- The new pavement is open to traffic.
- The new pavement is open to traffic.
- Pour concrete driveway approaches.
Pheasant Ring/Eagle Drive (Phase 1) -
- The new pavement is open to traffic.
- Begin paving.
Cedar Shake/Lakewood Drive (Phase 1) -
- The new pavement is open to traffic.
- Pour concrete driveway approaches.
- Remove pavement and excavate earth.
- Install edge drain and place aggregate base.
- Possibly begin paving.
- Work to be announced.

Construction Update
on Jul 03, 2025
+
For the Week of July 7th
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift -
Sugar Pine Road (Phase 1) Walton to Black Maple -
Pheasant Ring/Eagle Drive (Phase 1) -

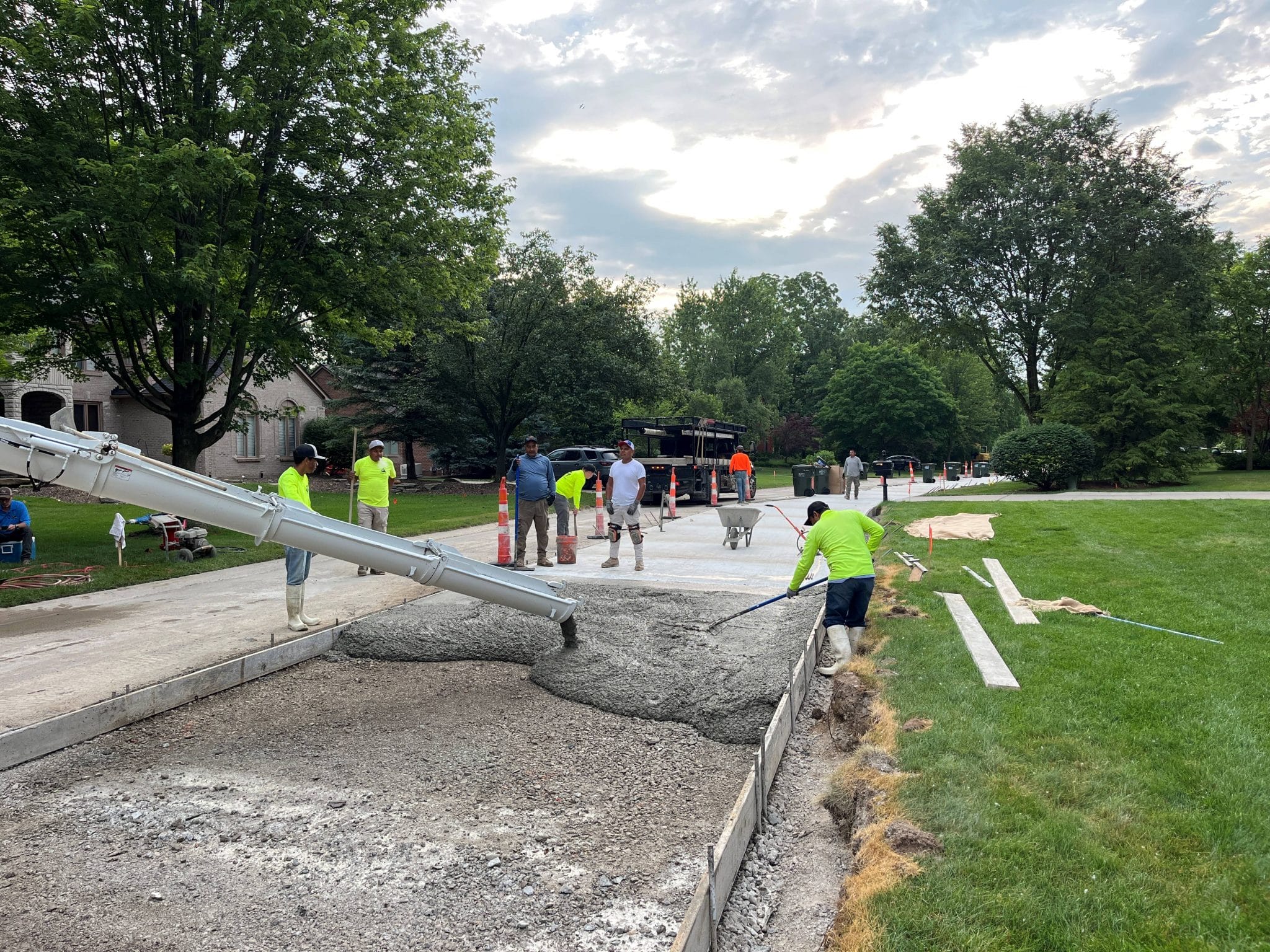

Cedar Shake/Lakewood Drive (Phase 1) -
Eddington Boulevard (Phase 1 & 2) Farnborough to Windrift -
- Complete.
- Paving is complete. Allow cure time.
- Continue topsoil and hydro seed along the back of curb.
Sugar Pine Road (Phase 1) Walton to Black Maple -
- Open to traffic.
- Continue top soil and hydro seed.
- Open to Traffic.
- Continue topsoil and hydro seed.
- Complete earth excavation.
- Complete installation of edge drain and aggregate base.
- Complete form work and pave.
Pheasant Ring/Eagle Drive (Phase 1) -
- Paving is complete.
- Driveways waiting for cure time.
- Removing pavement and earth excavation.
- Installing edge drain and placing aggregate base course.
Cedar Shake/Lakewood Drive (Phase 1) -
-
- Open to traffic.
- Preparing driveways for concrete.
- Begin removing pavement and earth excavation on Lakewood.
- Work to be announced.

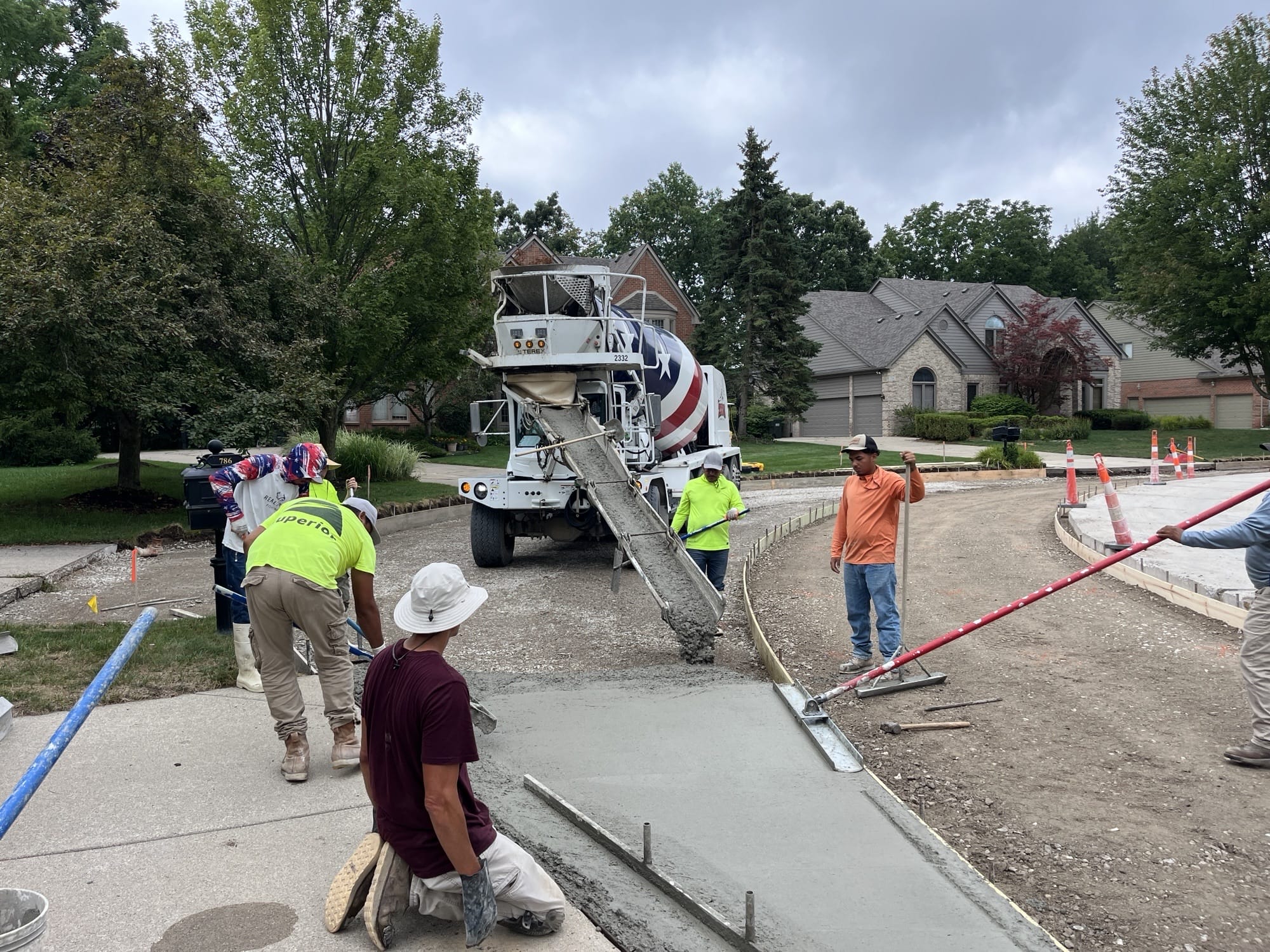

Pouring concrete on Cedar Shake Drive.

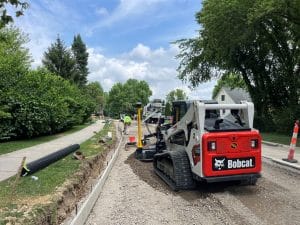

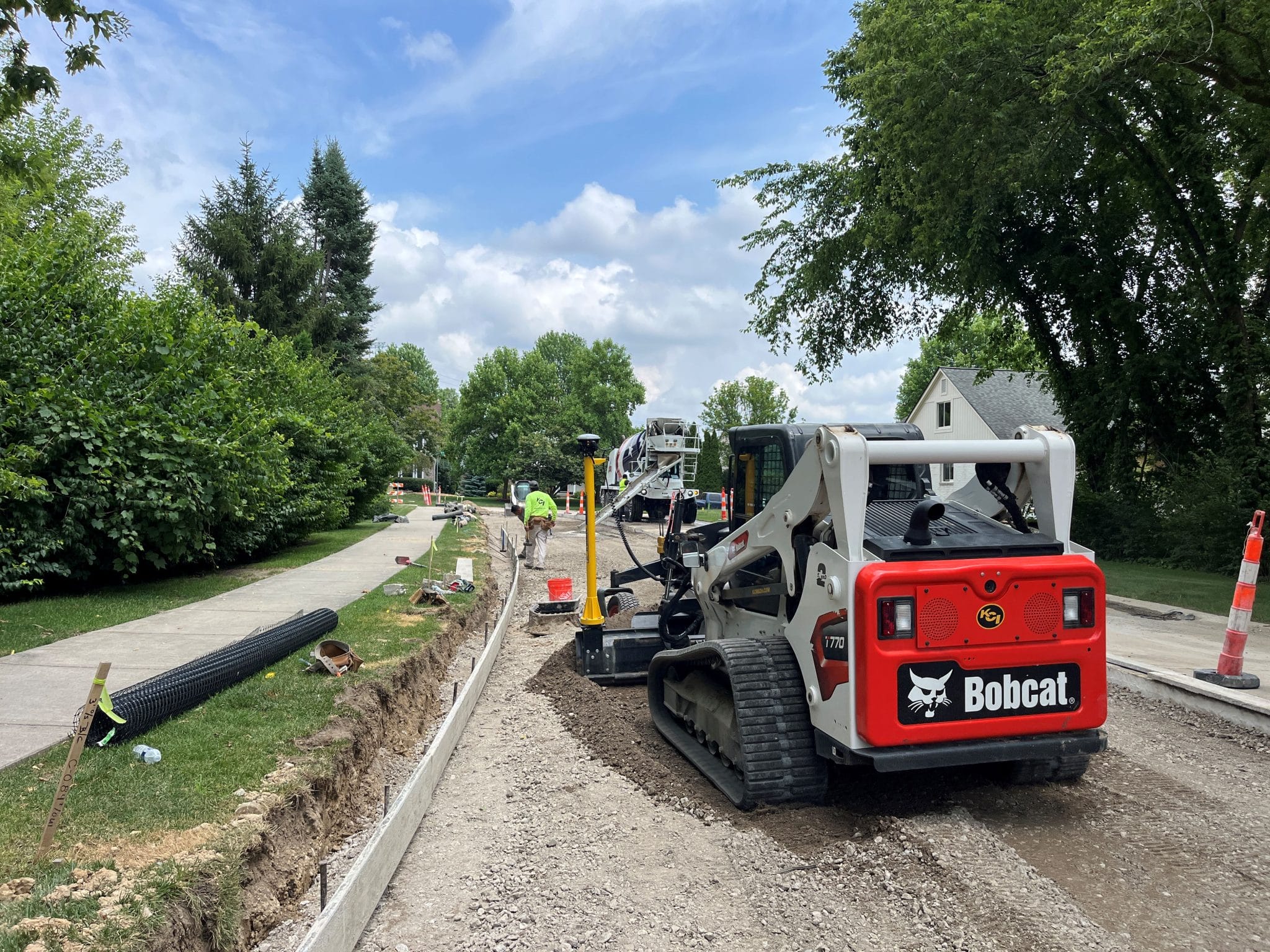

Machine grading the 21AA aggregate base on Eddington Boulevard.
Applying curing compound over the surface of concrete paving on Cedar Shake Drive.
Construction Update
on Jun 27, 2025
+
For the week of June 30th, 2025
No work will be performed on July 4th.
Eddington Boulevard (Phase 1 and 2) Farnborough to Windrift
Flanders Drive (Phase 1 and 2)
Sugar Pine Road (Phase 1) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phase 1)
Cedar Shake/Lakewood Drive (Phase 1)

Eddington Boulevard (Phase 1 and 2) Farnborough to Windrift
- Complete
- Installing edge drain, placing aggregate and concrete forms.
- Begin paving.
Flanders Drive (Phase 1 and 2)
- Open to traffic.
- Topsoil and hydroseed along the back of the curb.
Sugar Pine Road (Phase 1) Walton to Black Maple
- Open to traffic.
- Begin backfilling at the back of the curb.
- Place topsoil and hydroseed.
- Open to traffic.
- Begin backfilling at the back of the curb.
- Place topsoil and hydroseed.
- Begin removing pavement.
- Install edge drain and place aggregate base.
- Complete.
Pheasant Ring/Eagle Drive (Phase 1)
- Paving is complete. Allow for cure time.
- Begin forming driveway approaches.
- Start Phase 2 demo.
Cedar Shake/Lakewood Drive (Phase 1)
- Complete paving. Allow for cure time.
- Begin forming driveway approaches.
- Work to be announced.

Construction Update
on Jun 20, 2025
+
Eddington Boulevard (Phase 1) Farnborough to Windrift
- Restoration along the back of curb.
- Open to traffic mid week.
- Restoration along the back of curb.
- Open to traffic mid week.
-
- Begin removing pavement and earth excavation.
- Installing edge drain, aggregate and concrete forms.
Flanders Drive (Phase 1)
- Open to traffic.
- Topsoil and hydro seed along the back of curb.
-
- Complete paving at south end. Allow cure time for strength.
- Pour concrete drive approaches. Allow cure time for strength.
- Topsoil and hydro seed along the back of curb.
Sugar Pine Road (Phase 1) Walton to Black Maple
- Open to traffic.

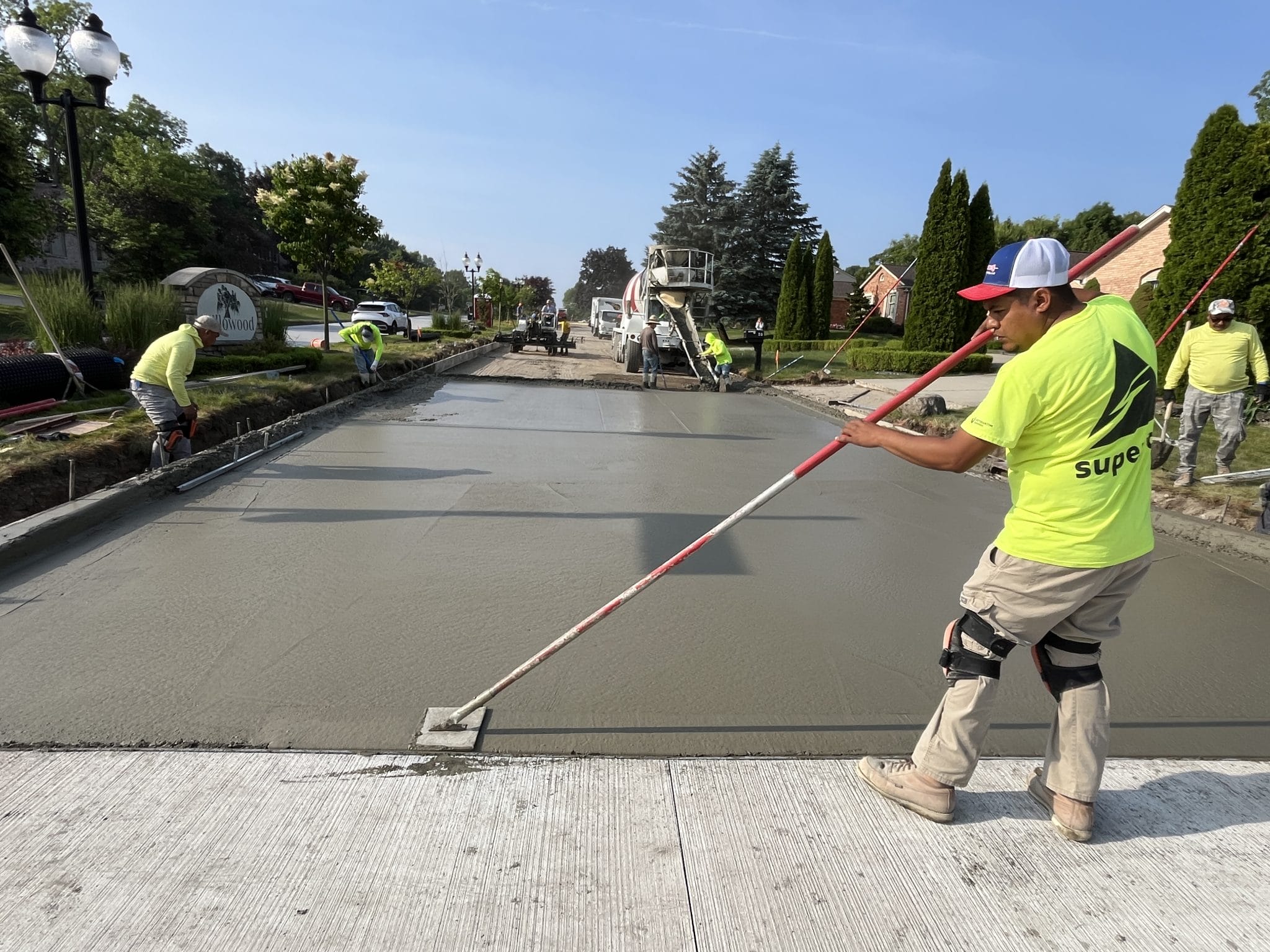

- Begin backfilling at back of curb.
- Paving is complete. Allowing cure time for strength.
- Will be opened this week.
Pheasant Ring/Eagle Drive (Phase 1)
-
- Continue placing aggregate base and concrete forms.
- Paving begins.
Cedar Shake/Lakewood Drive (Phase 1)

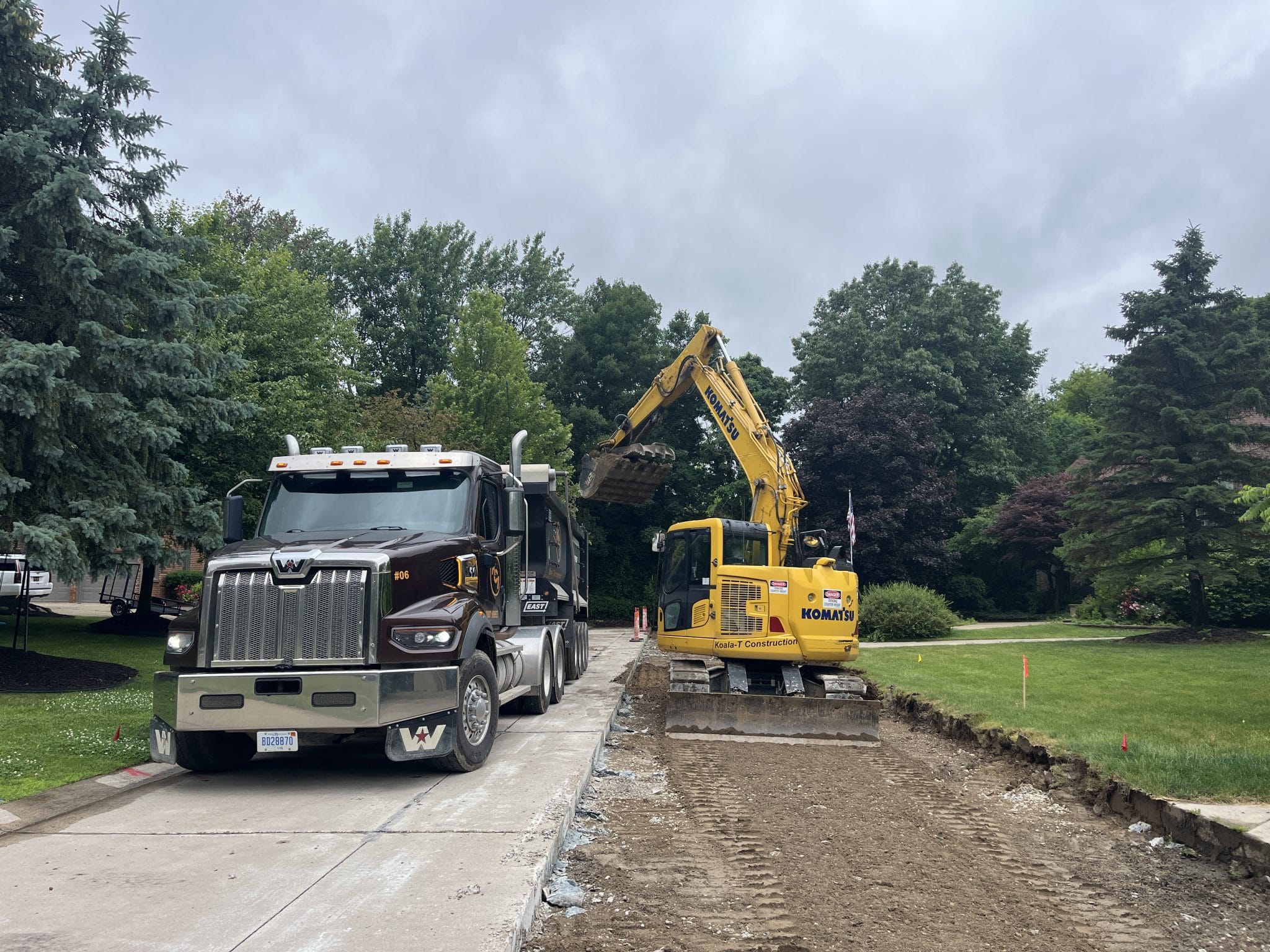

- Continue removing pavement and earth excavation.
- Continue installing edge drain.
- Begin placing aggregate base.
-
- Removing miscellaneous sidewalk panels, prep and begin pouring concrete in the Rookery Woods subdivision.
Nearing the end of earth excavation for Phase 2 Sugar Pine at Black Maple Drive.

Construction Update
on Jun 13, 2025
+
For the week of June 16th, 2025
Eddington Boulevard (Phase 1) Farnborough to Windrift
Flanders Drive (Phase 1)
Sugar Pine Road (Phase 1) Walton to Black Maple
Pheasant Ring/Eagle Drive (Phase 1)
Cedar Shake/Lakewood Drive (Phase 1)

Eddington Boulevard (Phase 1) Farnborough to Windrift
- Open to construction traffic only.
- New pavement and driveway approaches have been completed.
Flanders Drive (Phase 1)
- New pavement and driveway approaches have been compelted.
- Complete paving. Allow time for cure strength.
Sugar Pine Road (Phase 1) Walton to Black Maple
- New pavement and driveway approaches have been completed.
- Complete installation of edge drain.
- Continue placing aggregate and concrete forms.
- Paving.
Pheasant Ring/Eagle Drive (Phase 1)
- Begin removing pavement and earth excavation.
- Begin installing edge drain.
- Begin placing aggregate base.
- May begin paving at the end of the week.
Cedar Shake/Lakewood Drive (Phase 1)
- Begin removing pavement and earth excavation.
- Begin installing edge drain.
- Begin placing aggregate base.
- Complete concrete on the west half of the boulevard.
- Begin removing miscellaneous sidewalk panels in the Rookery Woods subdivision.

Construction Update
on Jun 06, 2025
+
Eddington Boulevard (Phase 1) Farnborough to Windrift
- Open to construction traffic only.
- Placing aggregate base and installing forms.
- Pave the eastbound lane.
Flanders Drive (Phase 1)
- New concrete driveways require cure time for strength.
- Continue pavement removal and earth excavation in the northbound lane.
- Install edge drain and aggregate base in the northbound lane.
- Begin paving the northbound lane if scheduling allows.
Sugar Pine Road (Phase 1) Walton to Black Maple
- Begin placing driveway approaches along the east side of the street.
- Begin removing west side of the boulevard.
- Place aggregate and pour concrete curb and gutter on the west half of the intersection.

Construction Update
on May 30, 2025
+
Eddington Boulevard (Phase 1) Farnborough to Windrift
- Open to construction traffic only.
- Removing existing pavement and earth excavation.
- Installing edge drain and placing aggregate base.
Flanders Drive (Phase 1)
- New concrete requires cure time for strength.
- Begin placing aggregate base for driveway approaches if required strengths are obtained on new pavement.
- Start pavement removal in the northbound lane if required strengths are obtained on new pavement.
Sugar Pine Road (Phase 1) Walton to Black Maple -
- Continue placing aggregate base course.
- Continue installing concrete forms.
- Pave full width concrete in the northbound lanes.
Koala T Construction onsite placing 6" edge drain from east/northbound Sugar Pine Road.
Koala T Construction onsite removing existing concrete pavement from west/southbound Flanders Drive. Existing subgrade removed to limits 14 inches below proposed pavement grade.Construction Update
on May 23, 2025
+
During the Week of May 23rd
Eddington Boulevard (Phase 1) Farnborough to Windrift

- Complete concrete paving in the westbound lane.
- Cure time is required for the new concrete.
- Possibly begin removing pavement in the eastbound lane if required strength is obtained on new westbound concrete.
- Complete earth excavation in the southbound lane.
- Complete edge drain installation and placing aggregate base in the southbound lane.
- Begin placing forms and paving concrete in the southbound lane.
- Begin pavement removal and earth excavation in the northbound lane.
- Begin installing the edge drain along the east side of the street.
- Begin placement of aggregate base in the northbound lane.

Construction Update
on May 16, 2025
+
During the Week of May 19th
Eddington Boulevard
Contractor will be installing edgedrain, placing aggregate base, and placing concrete forms in the westbound lane between Windrift and Farnsborough.
Flanders Drive
Begin removing pavement, earth excavation, installing edge drain, and placing aggregate base course in the southbound lane between Highsplint and Harlan Court.


Construction Updates Coming Soon
on May 06, 2025
+
Sign up HERE to receive updates on project progress, schedule changes, weather delays, detours, and other relevant information. Concrete replacement locations: Independence Dr/Ct, Cedar Shake Dr, Lakewood Dr, Sugar Pine Rd, Pheasant Ring Dr, Eagle Dr, Eddington Blvd, Sanctuary Blvd entrance, Flanders Dr, and Charlwood Dr.
Questions? We have answers
If you have any questions or concerns about the project, we are here for you. Our project manager is here to answer any of your questions. Feel free to email or call us at any time.
