Latest Update
Construction Update

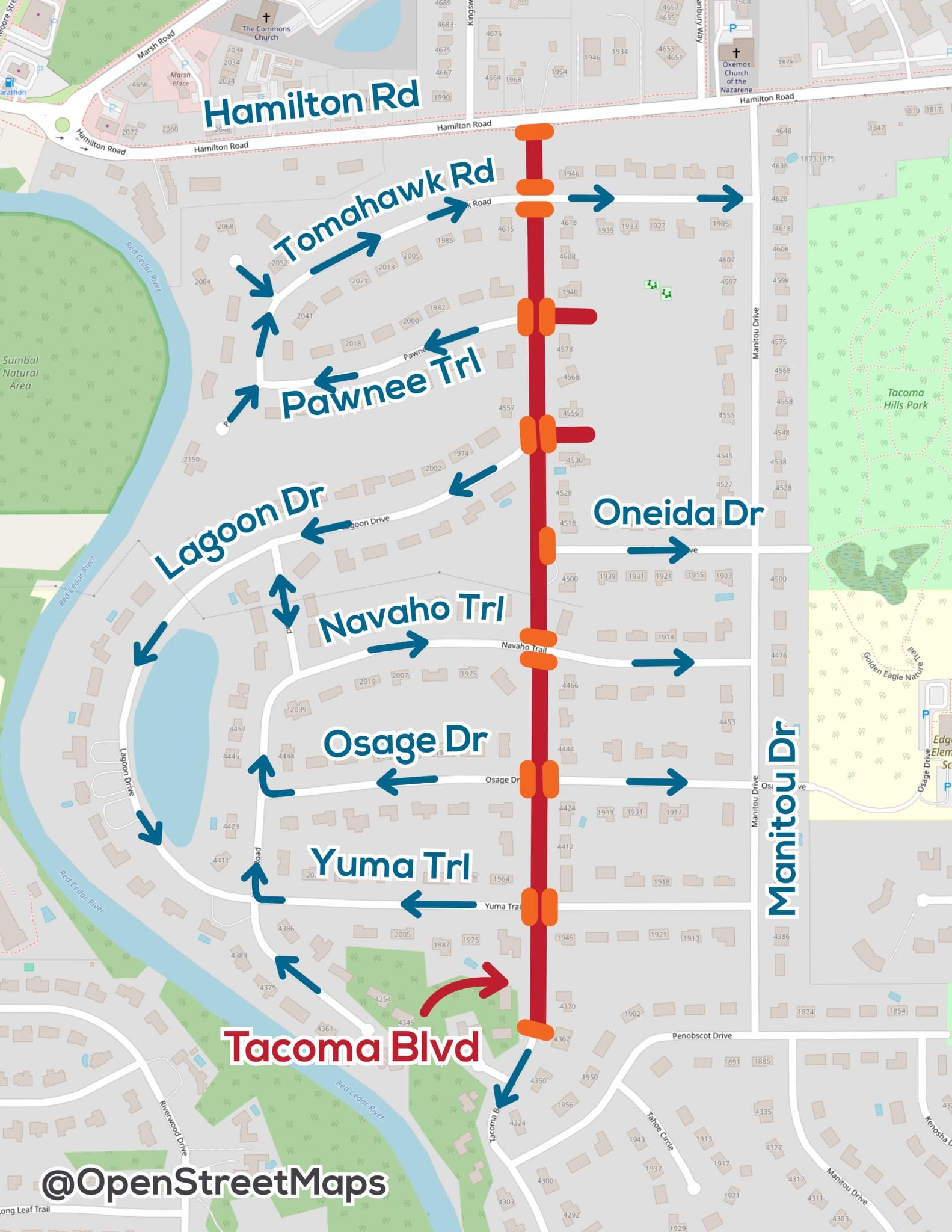

Area: Tacoma Hills, Tihart Road, and Newman Road

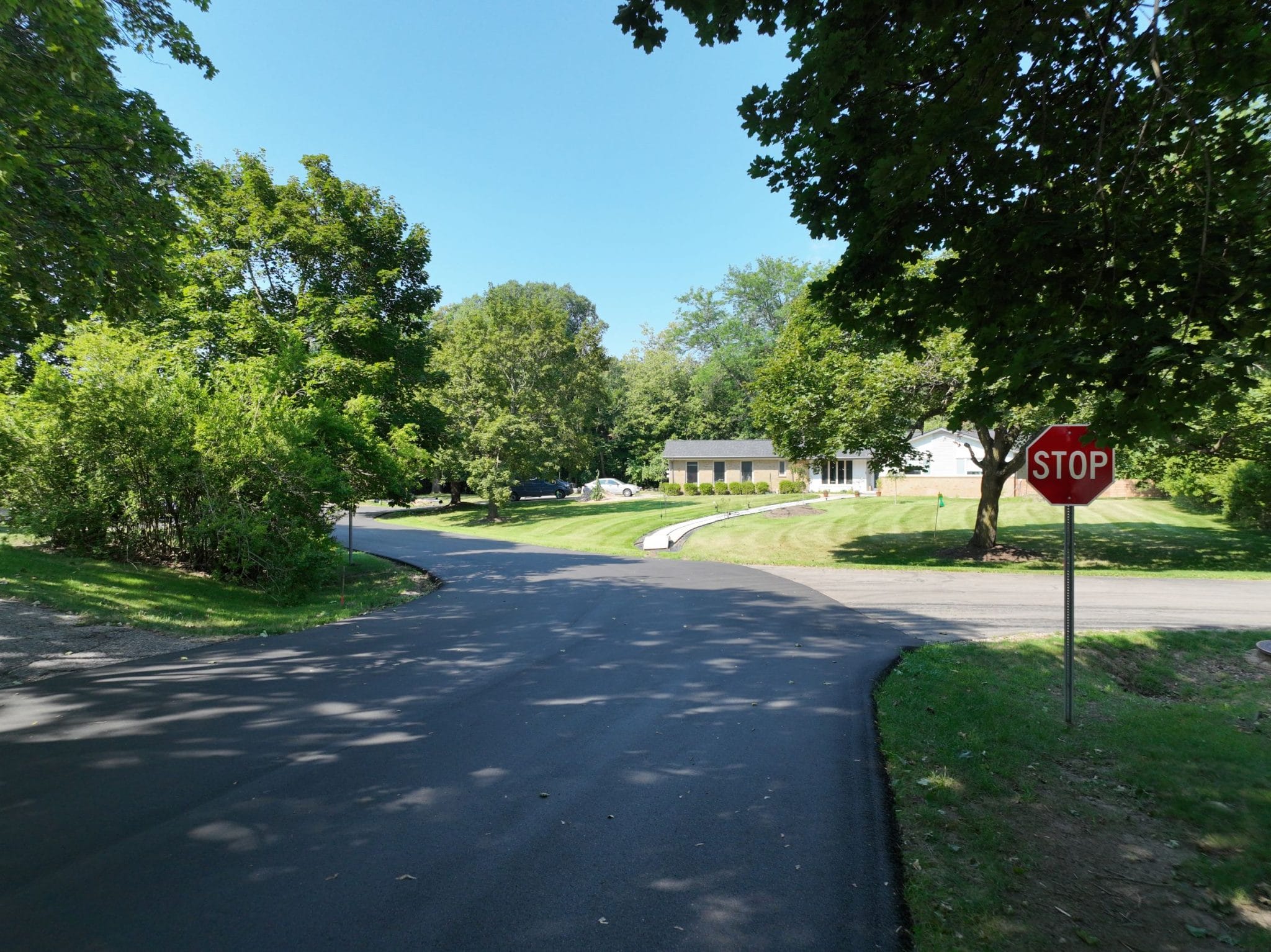

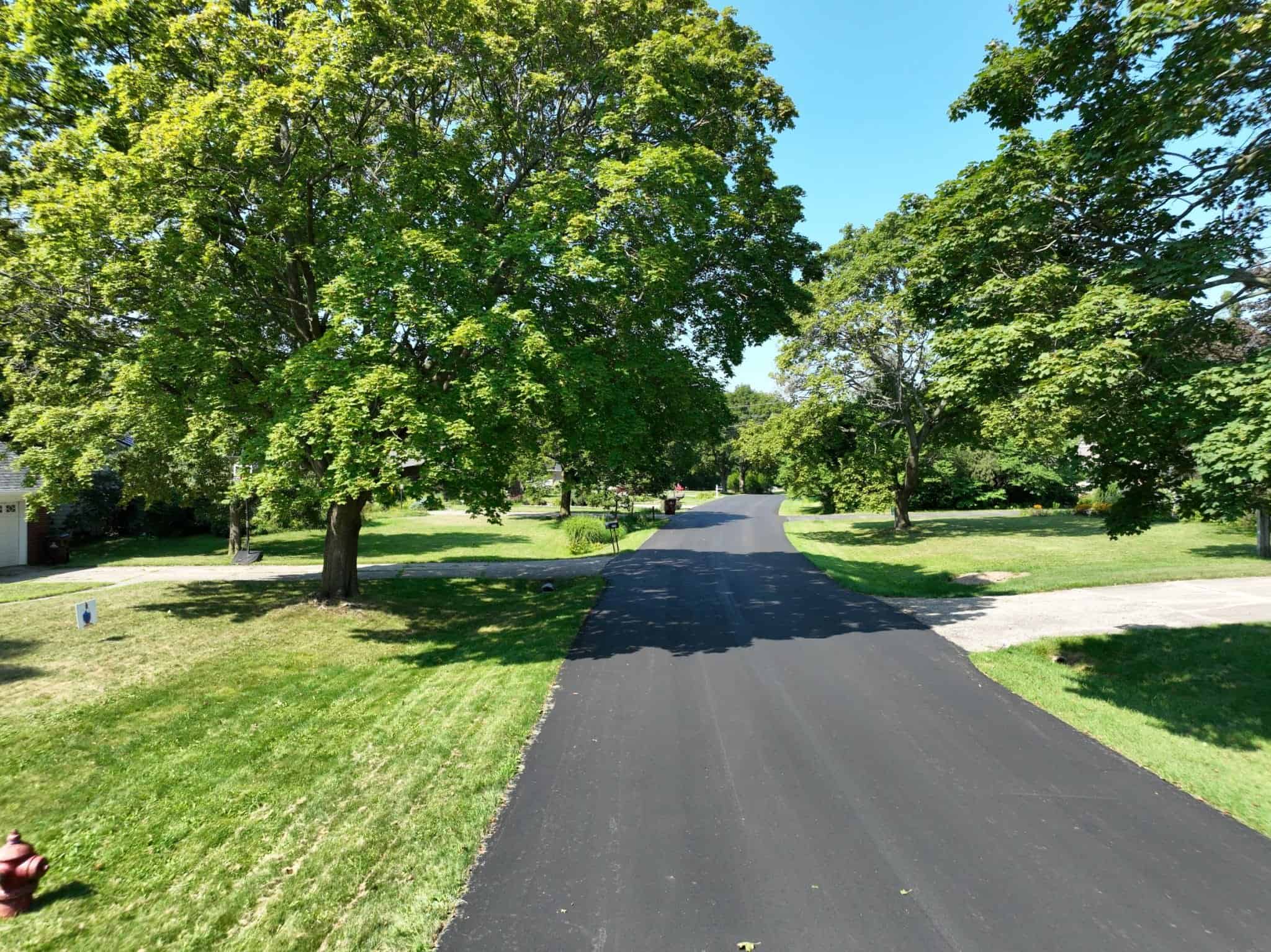

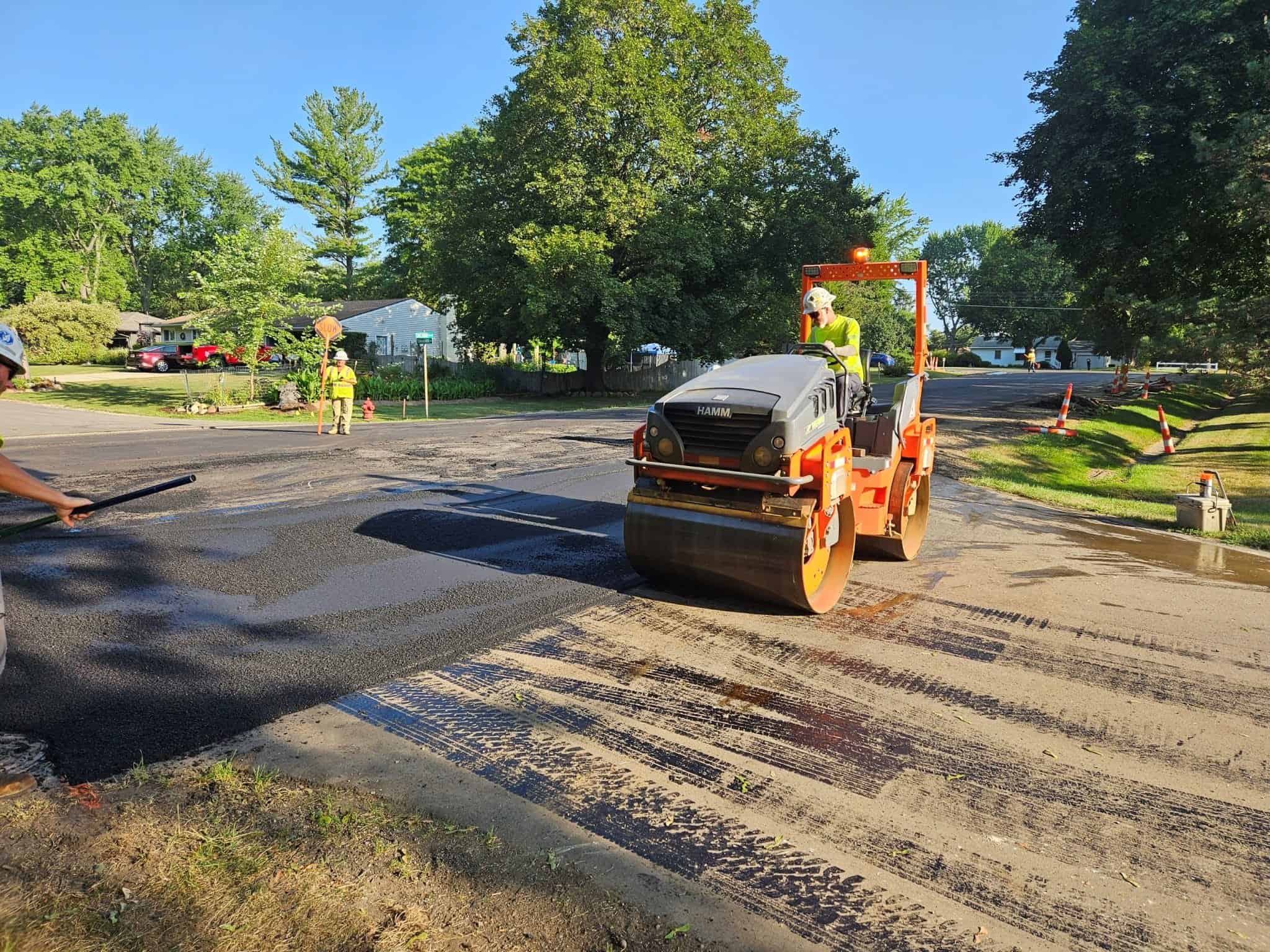

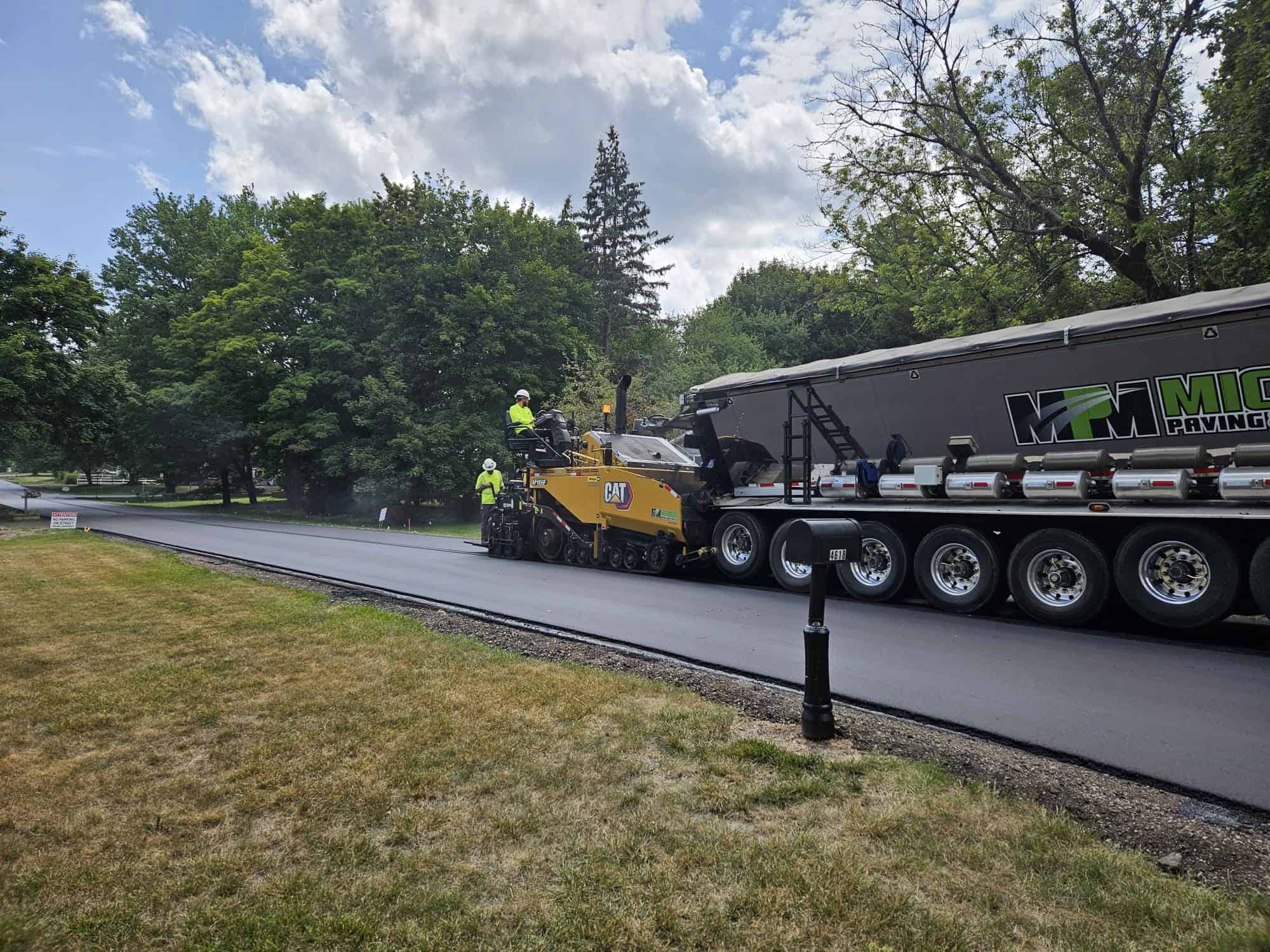

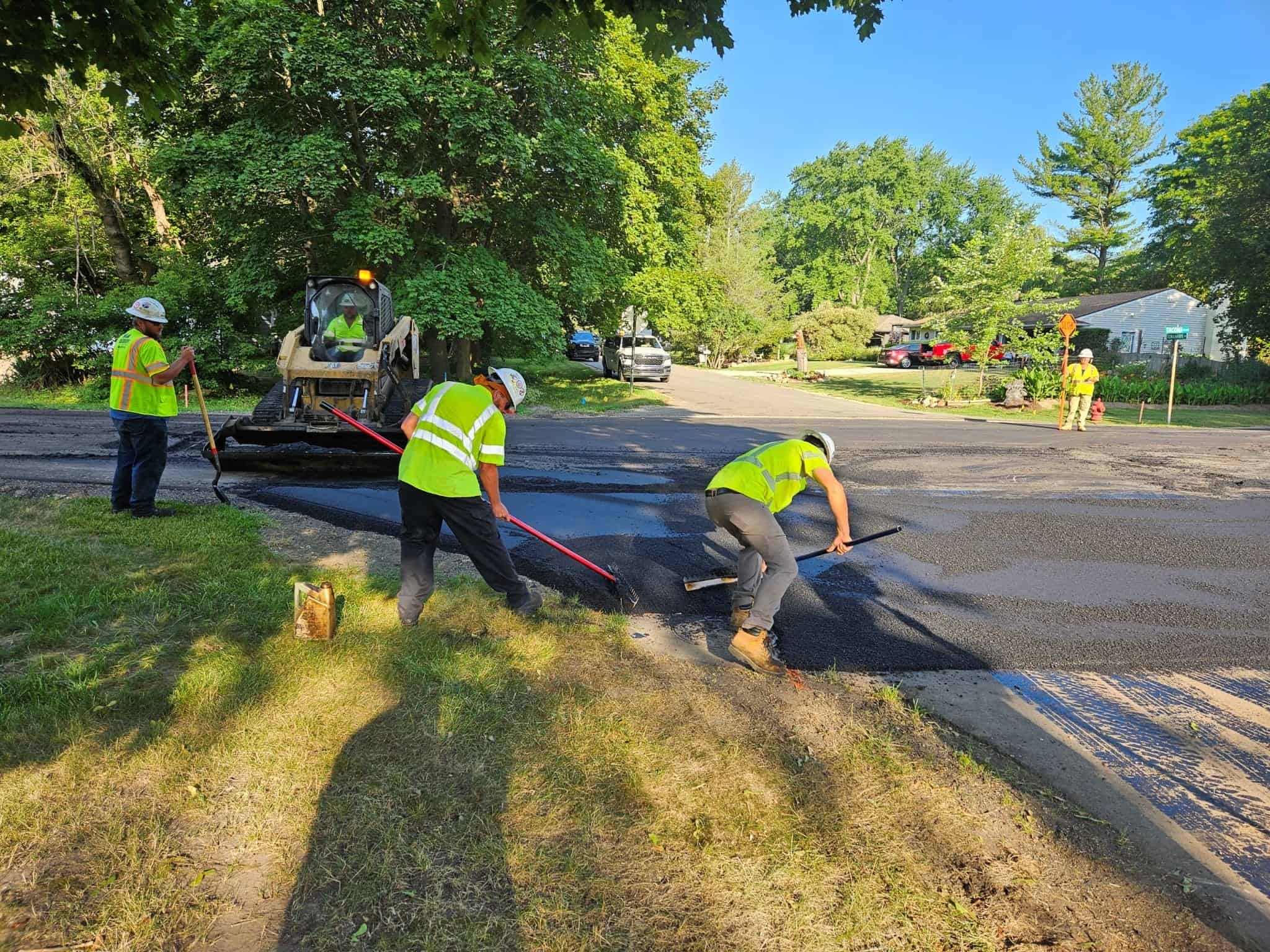

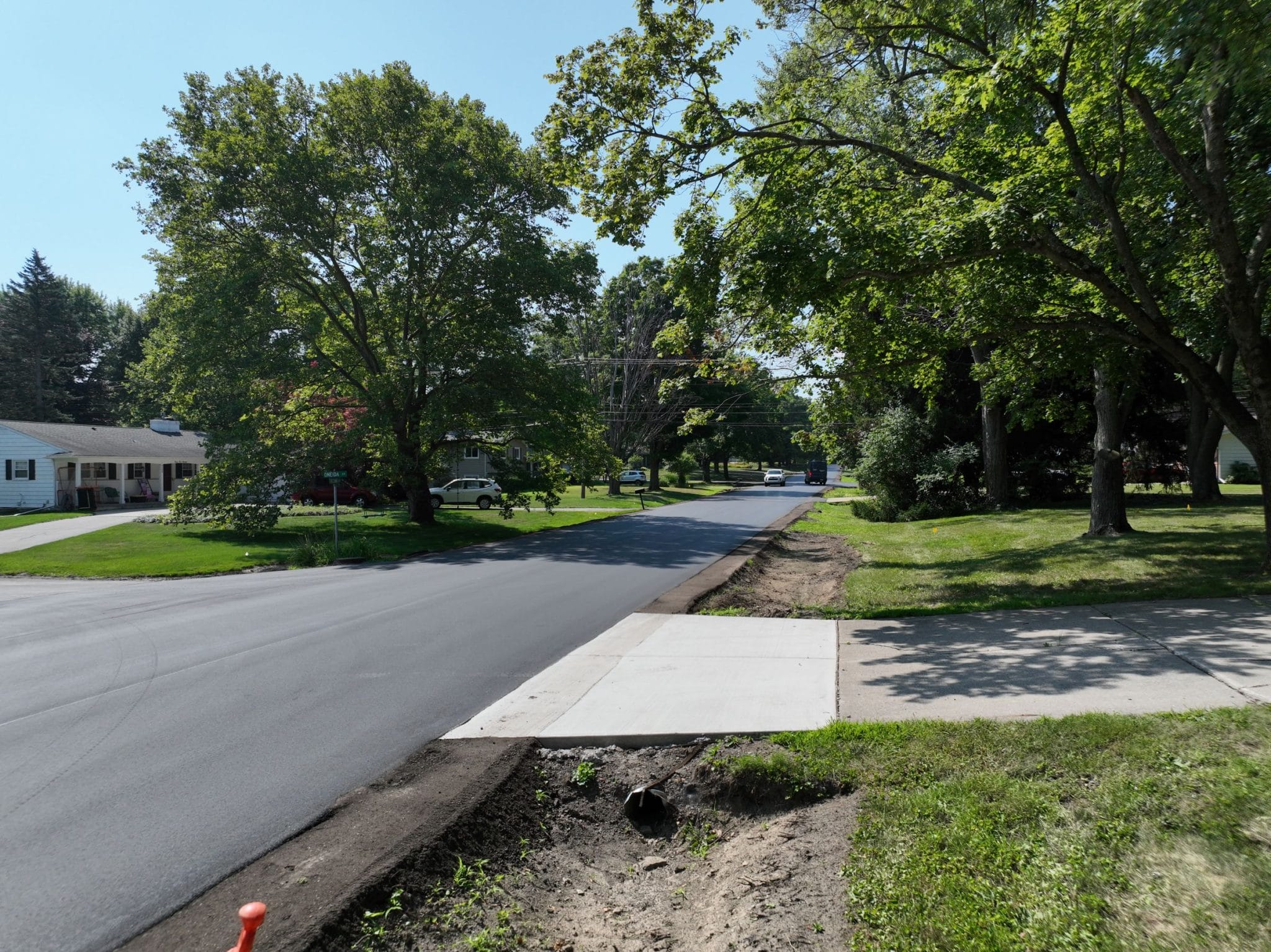

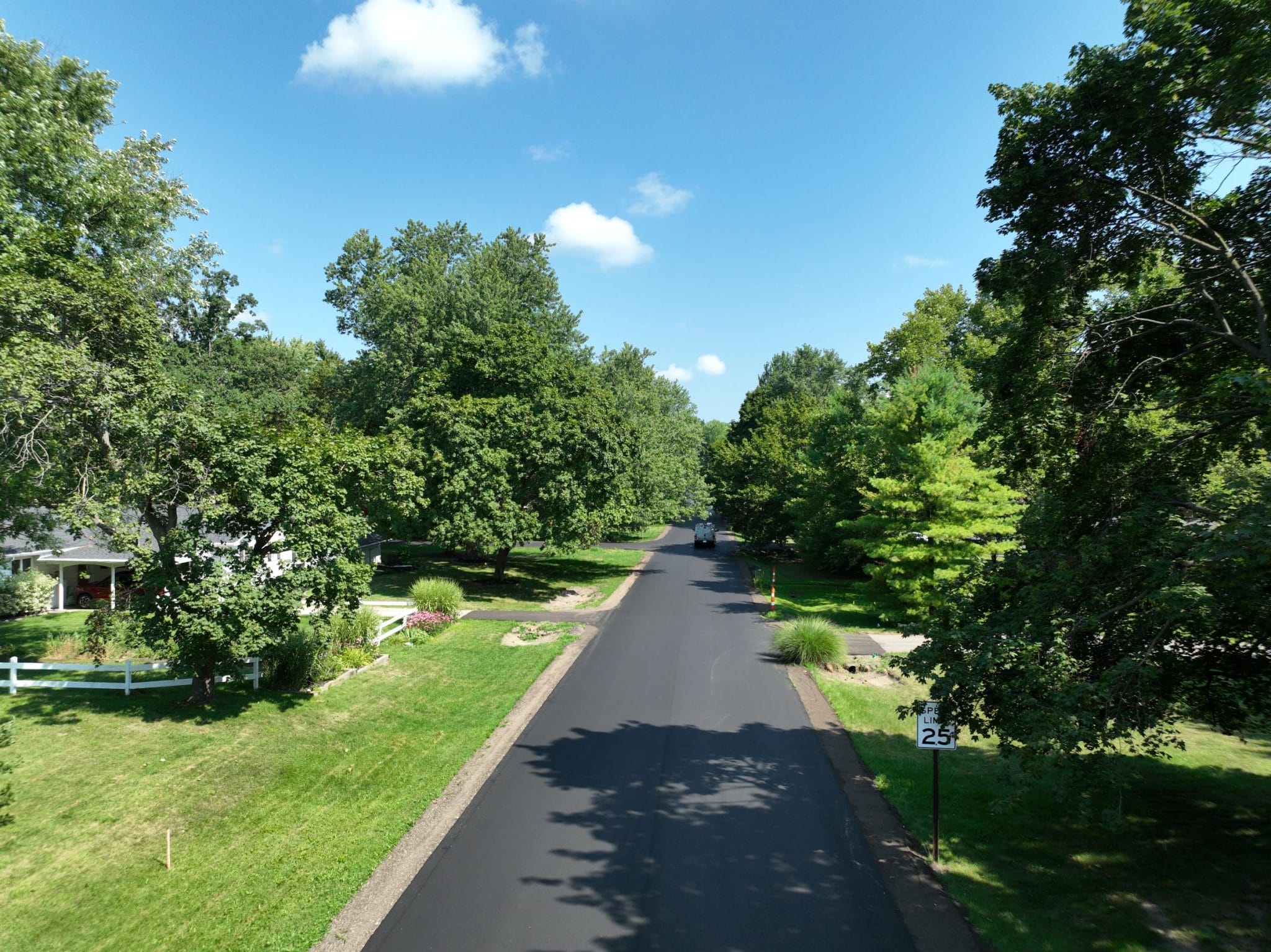

The contractor has completed all asphalt placement for this year’s program. Restoration work has been completed for Tihart, Newman and Tacoma Hills except at Pawnee Circle (as of 10/4/25).
COMING UP

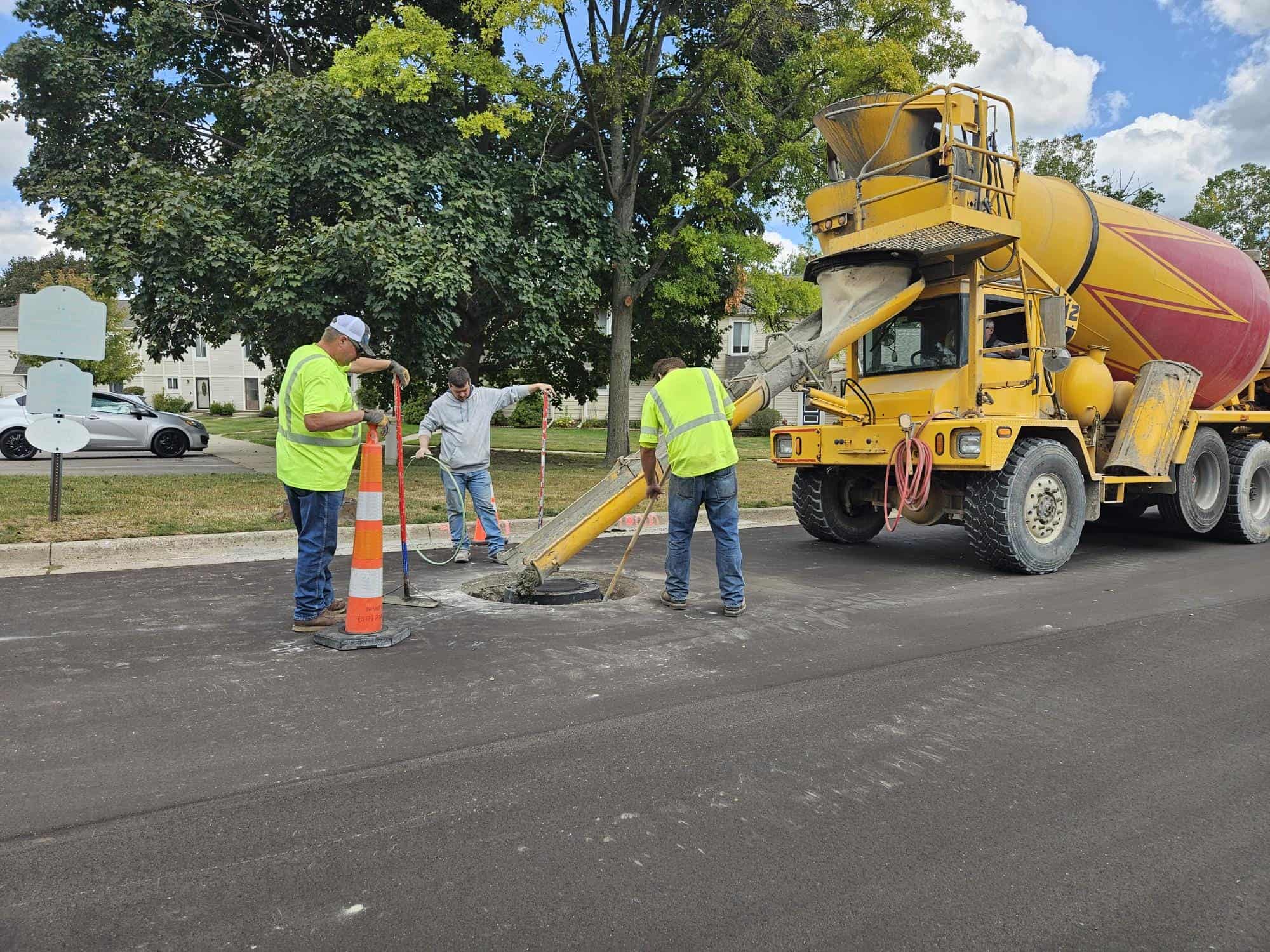

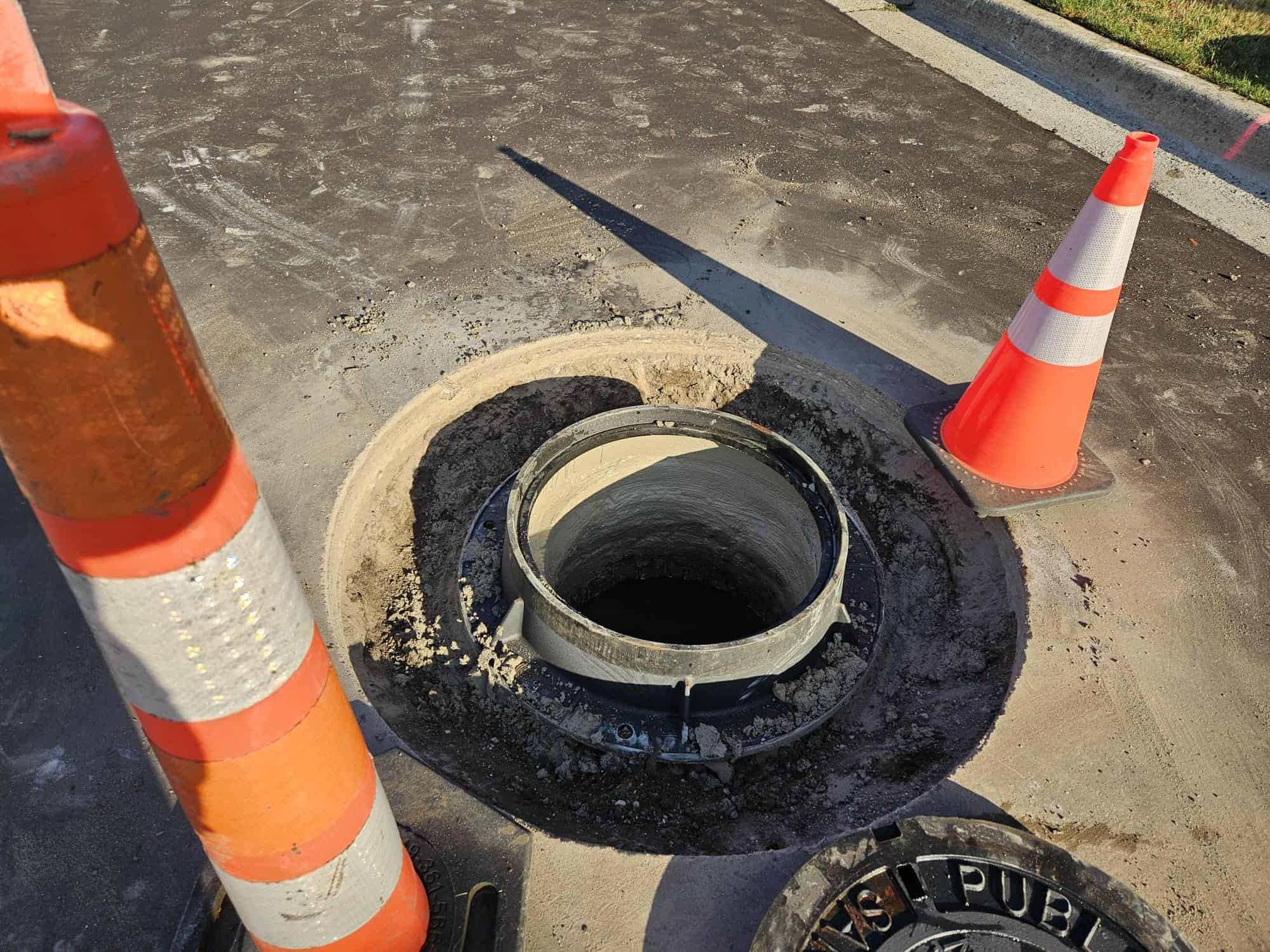

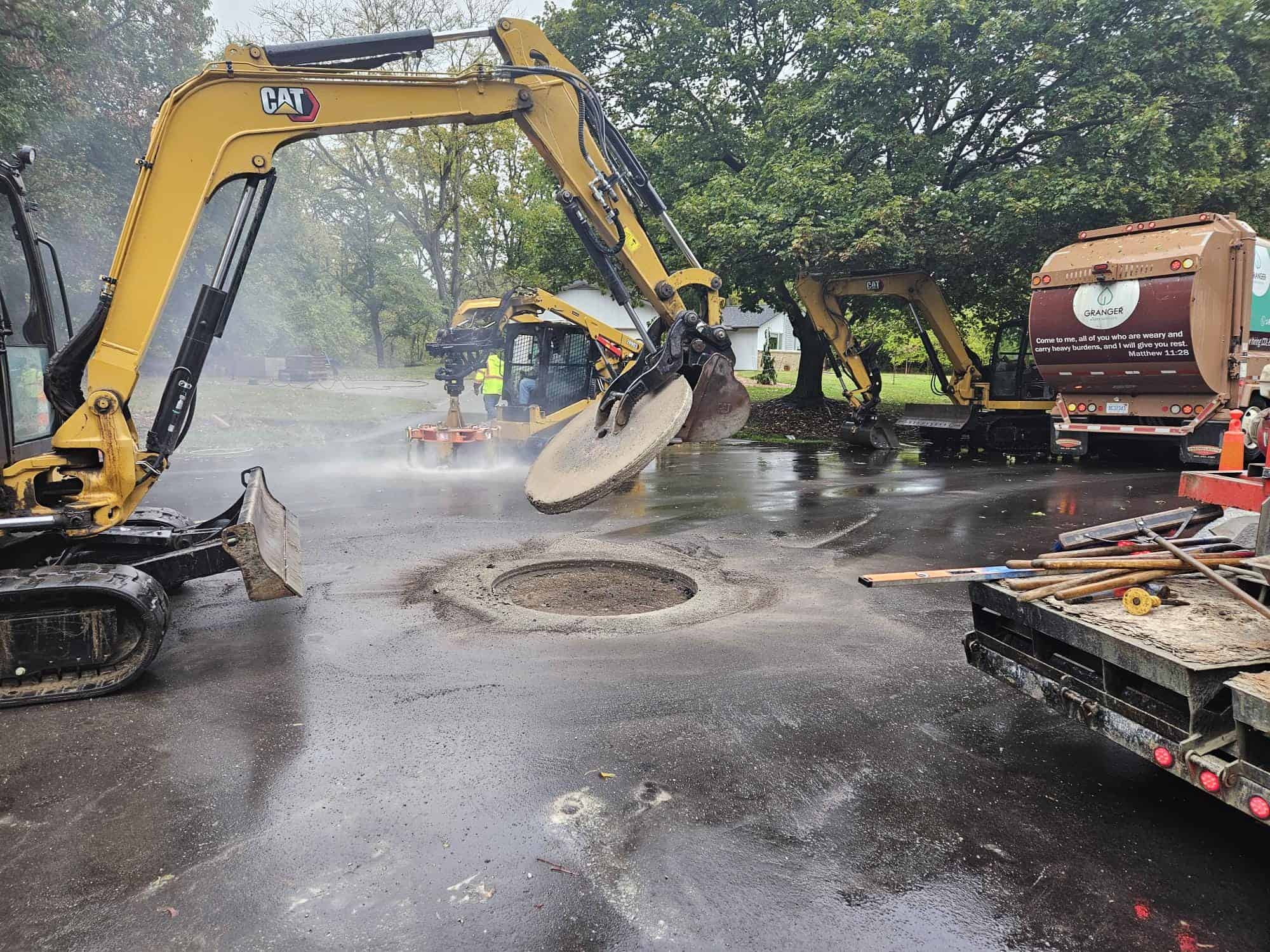

Pawnee Circle manhole adjustments and ditch restoration is scheduled for October 8.
Culvert cleanout will take place within the two weeks.
Ingham County has finished placing the chip seal and fog coat on Tihart Road.
A new split rail fence will be installed near the sidewalk at Powell.
All work is weather-dependent, and the schedule will change every time it rains on a scheduled work day.
We appreciate your patience during construction.
Construction Updates
Construction Update
Area: Tacoma Hills, Tihart Road, and Newman Road
The contractor has completed all asphalt placement for this year’s program. Restoration work has been completed for Tihart, Newman and Tacoma Hills except at Pawnee Circle (as of 10/4/25).
COMING UP
Pawnee Circle manhole adjustments and ditch restoration is scheduled for October 8.
Culvert cleanout will take place within the two weeks.
Ingham County has finished placing the chip seal and fog coat on Tihart Road.
A new split rail fence will be installed near the sidewalk at Powell.
All work is weather-dependent, and the schedule will change every time it rains on a scheduled work day.
We appreciate your patience during construction.
Construction Update

Construction Update

Construction Update - Correction
Construction Update

Construction Update

Construction Update

Construction Update


Construction Update
Construction Update






Construction Update

Construction Update

Construction Update

Construction Update

Construction Update

Construction Update
Construction Update

Construction Update

Construction Update
Construction Update

Construction Update

Construction Update

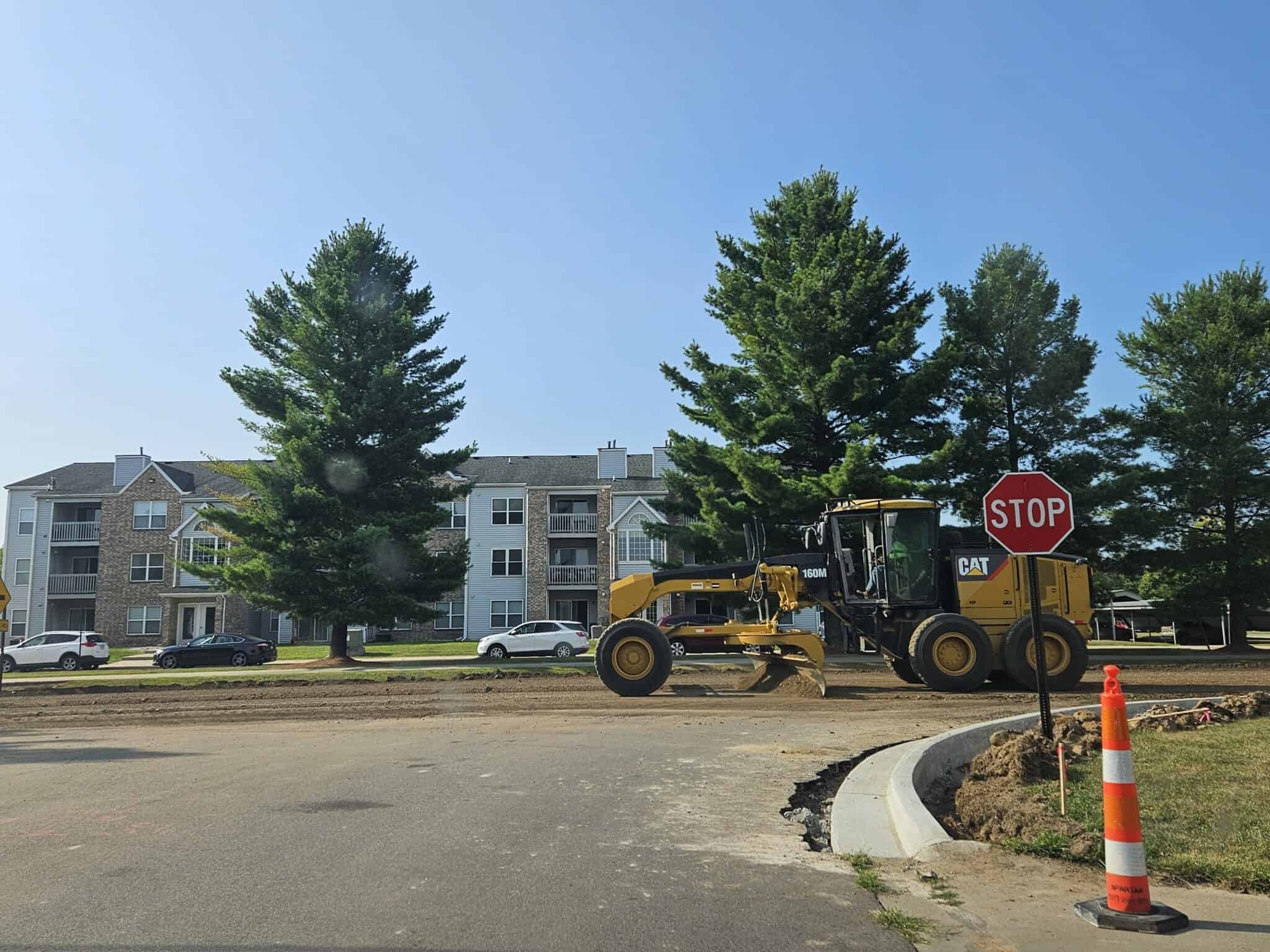

- For roads that do NOT have curb and gutter, the Township’s contractor continues to work on any necessary ditch cleanout and culvert replacement work.
- All ditch roads have had the existing asphalt crushed with the exception of Tacoma Blvd. Tacoma Blvd will likely be crushed the week of June 9 once the other roads have been paved.

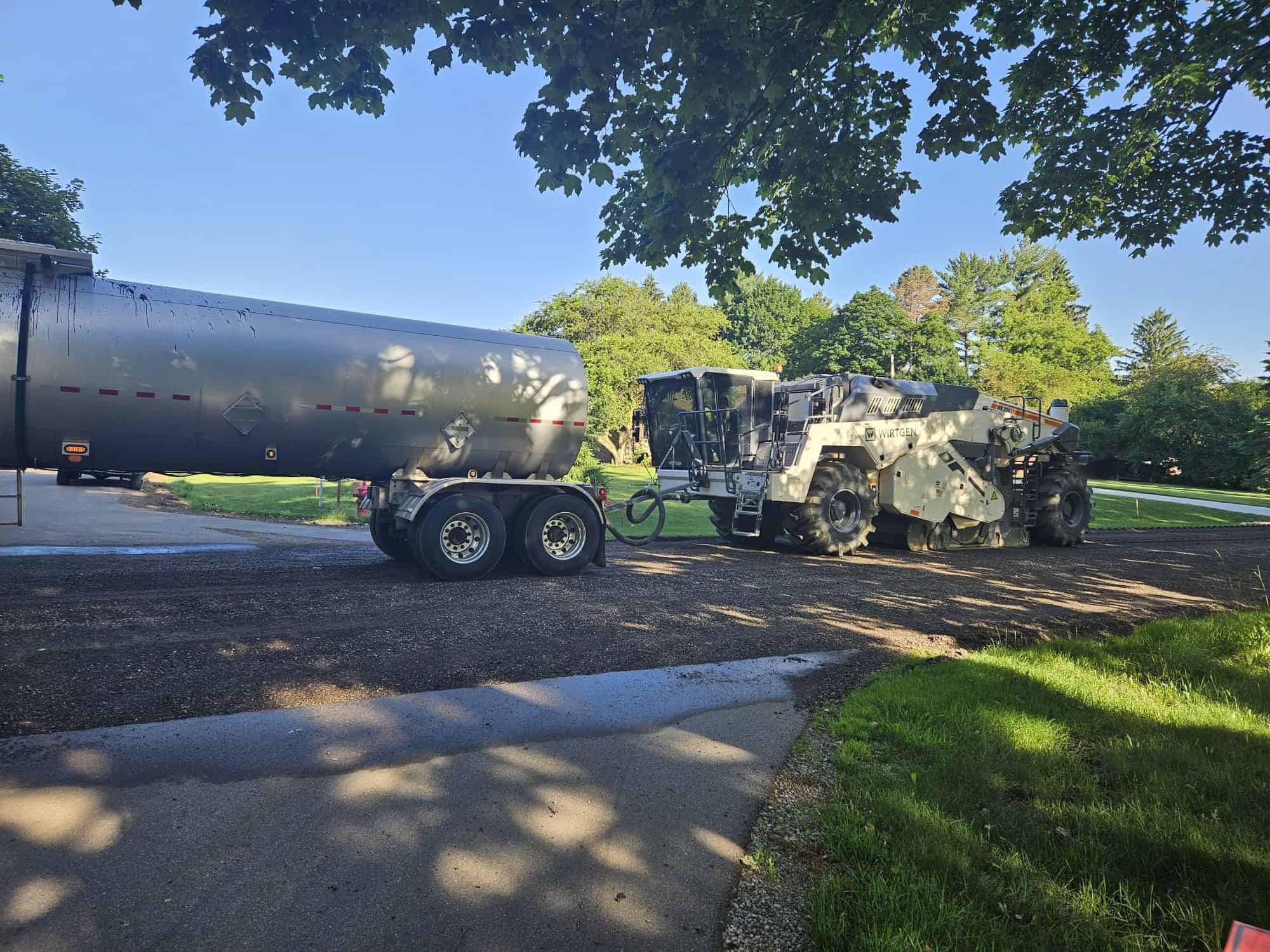

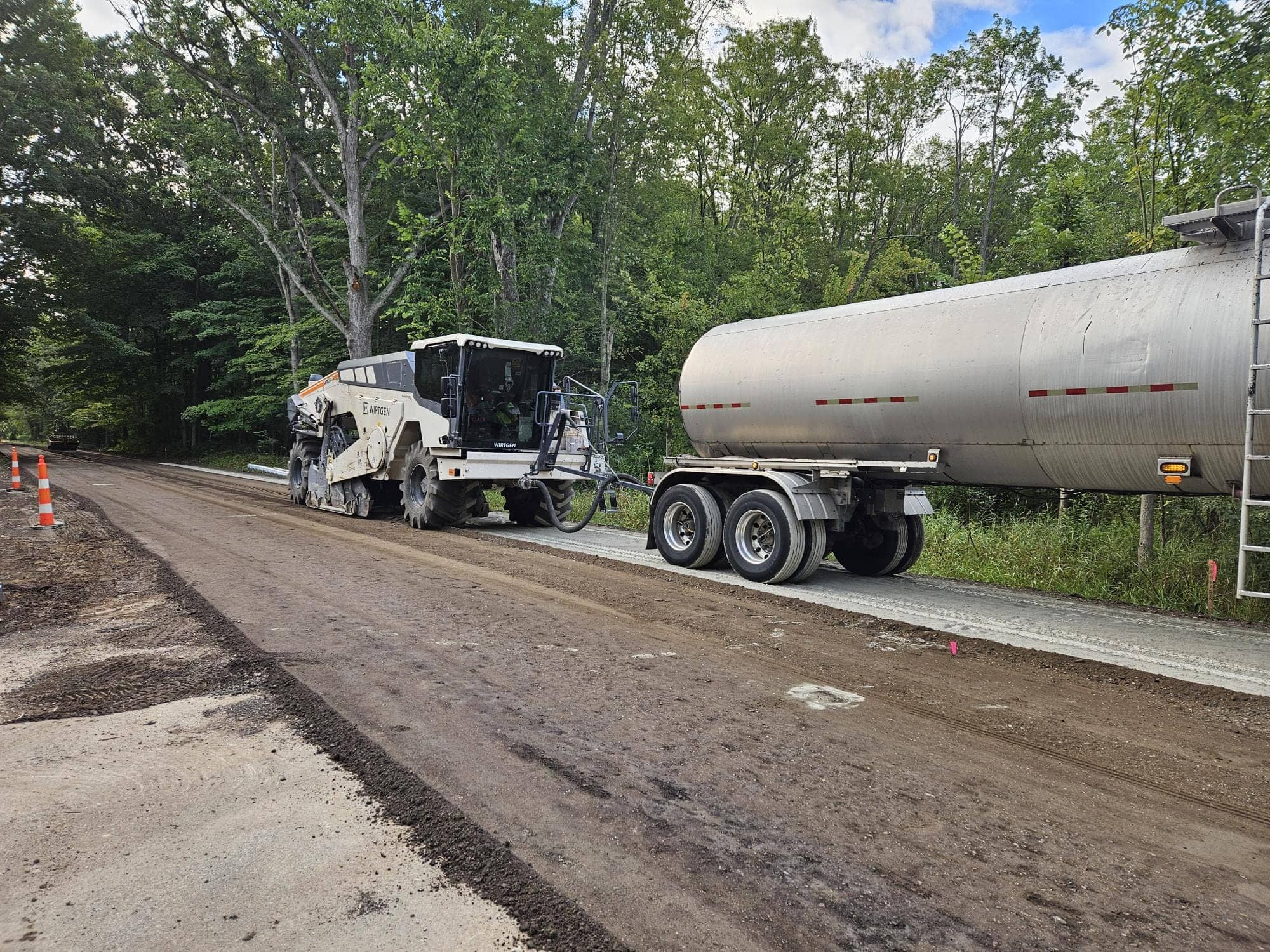

- The Township’s contractor will be completing the final milling (i.e. removing existing asphalt) from roads that have curb and gutter on May 30.

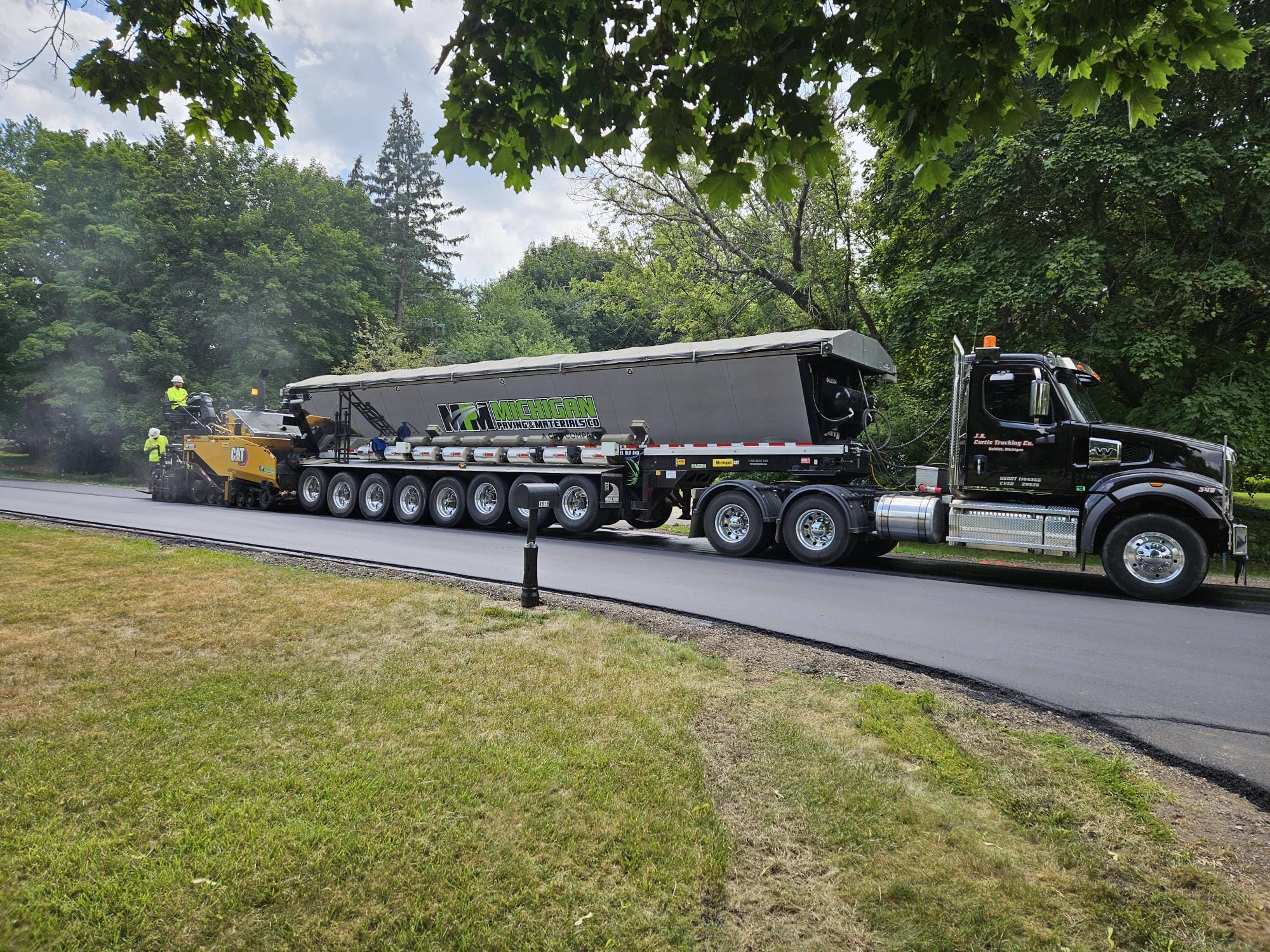

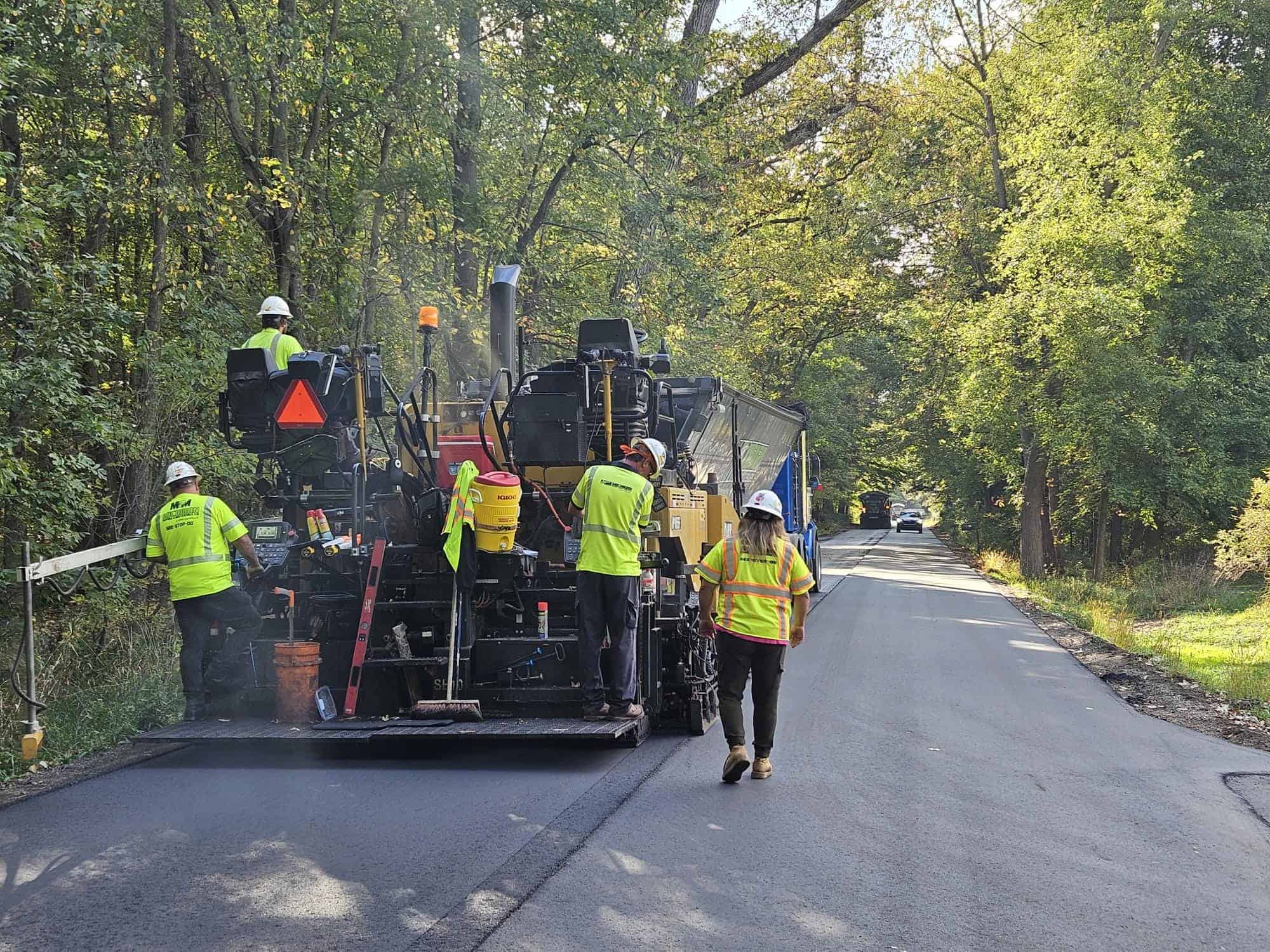

- The milling and crushing work typically moves past a given driveway in approximately 10 minutes, after which there is a rough gravel surface that you can drive on. The milling, crushing and paving work will be completed one lane at a time, thus the streets will be usable on at least one side at almost all times. An entire street is normally milled in one (1) day. Once the milling is finished, the first layer of new asphalt will be placed within 10 days.

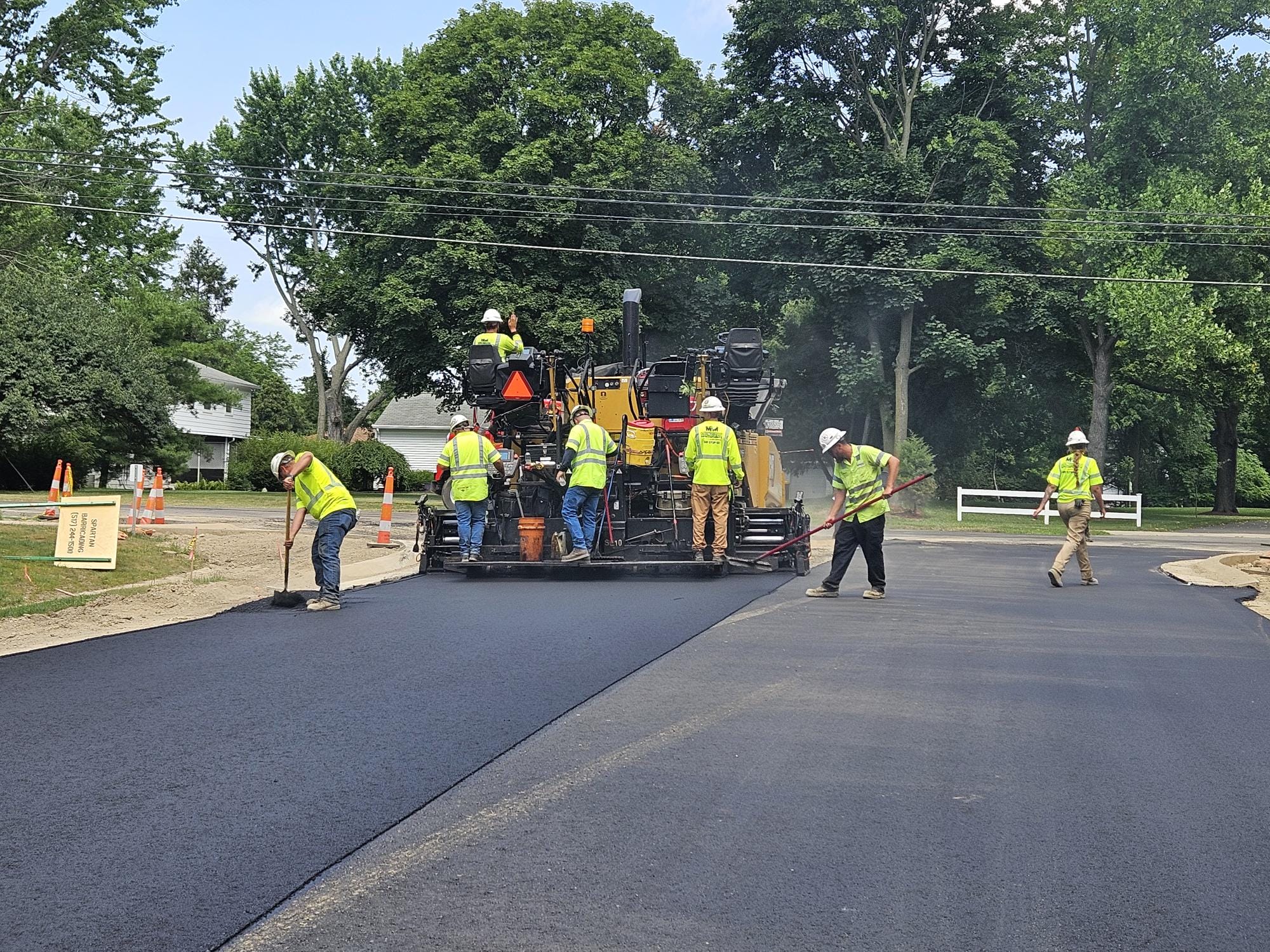

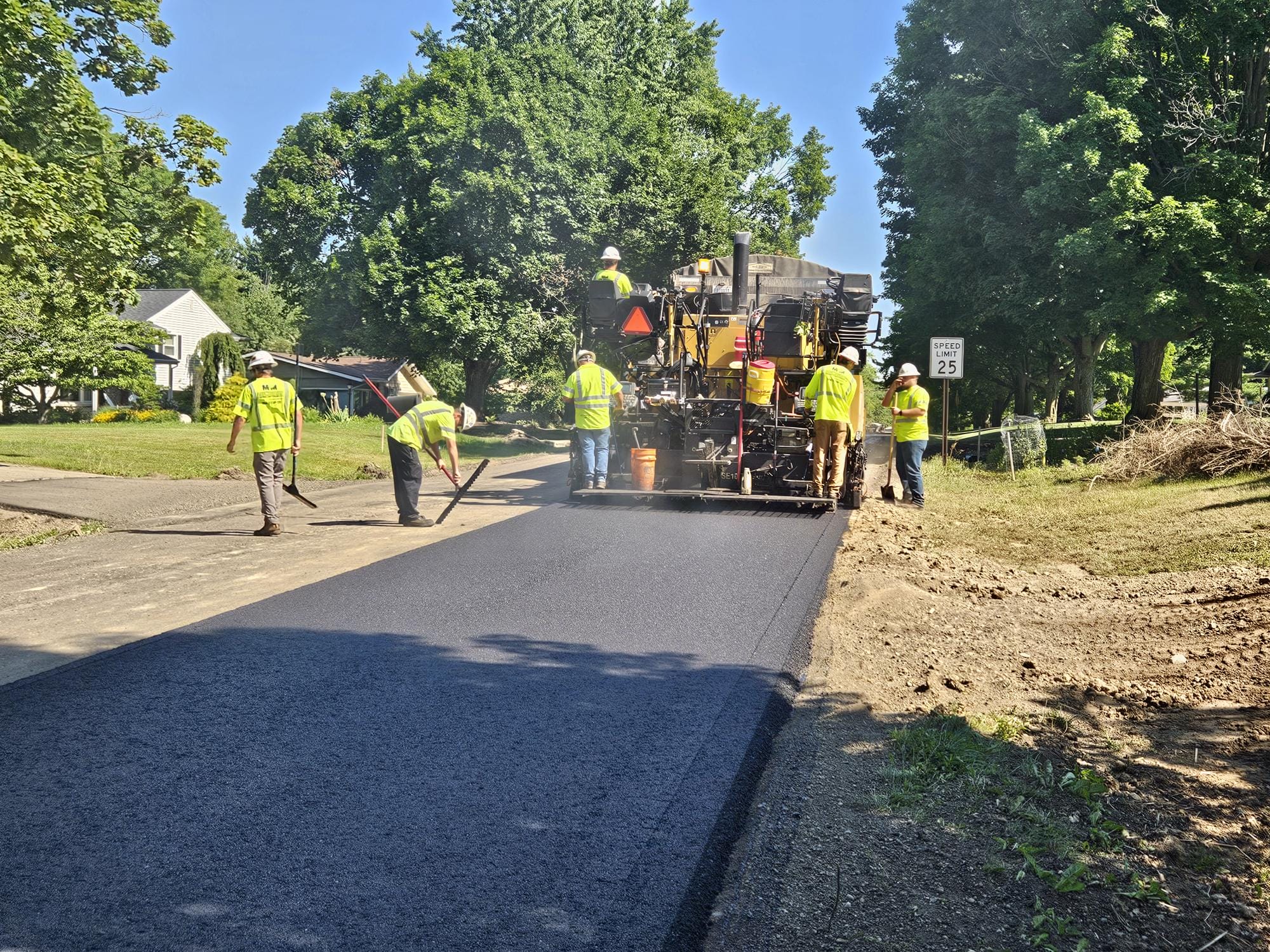

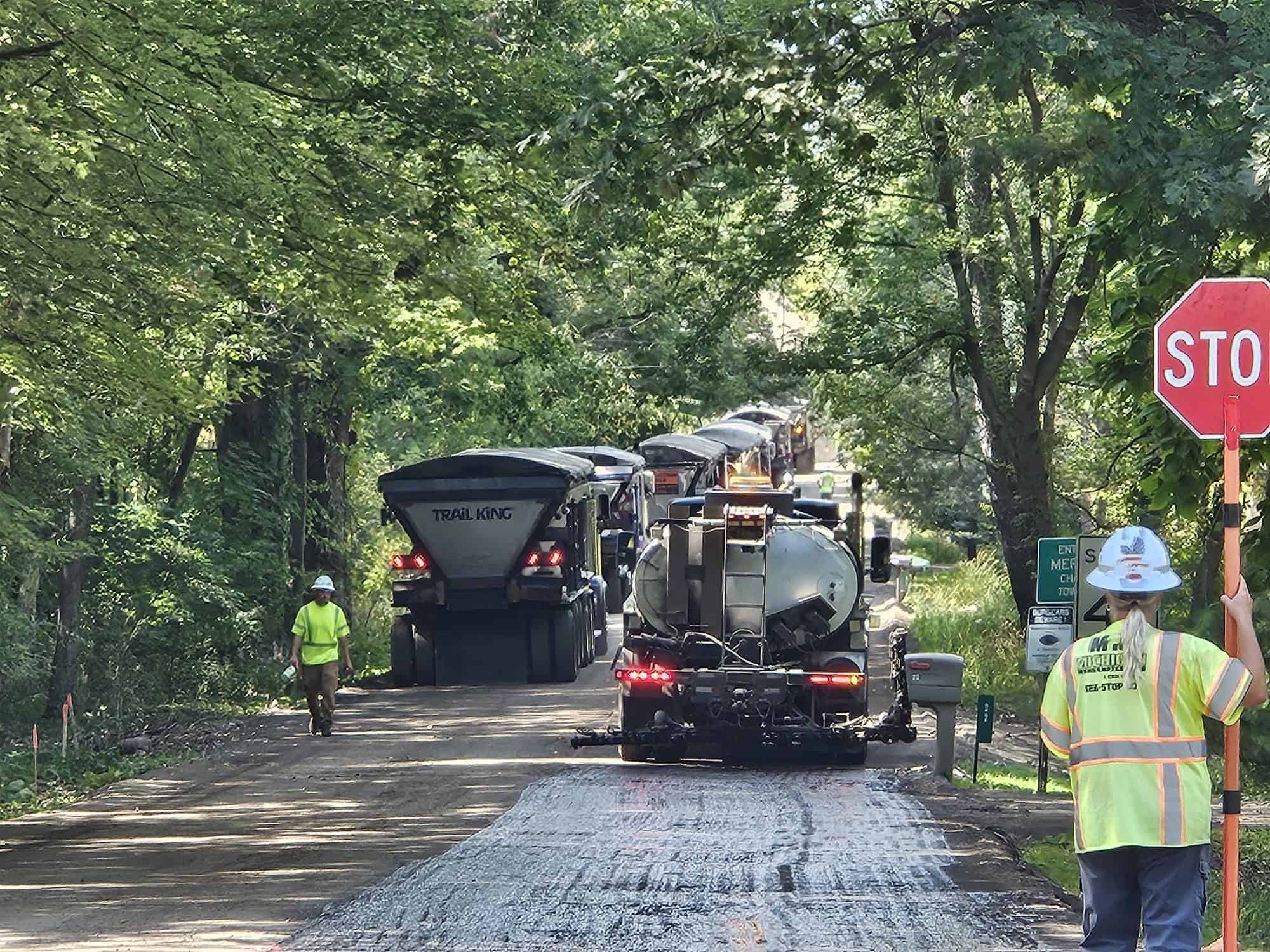

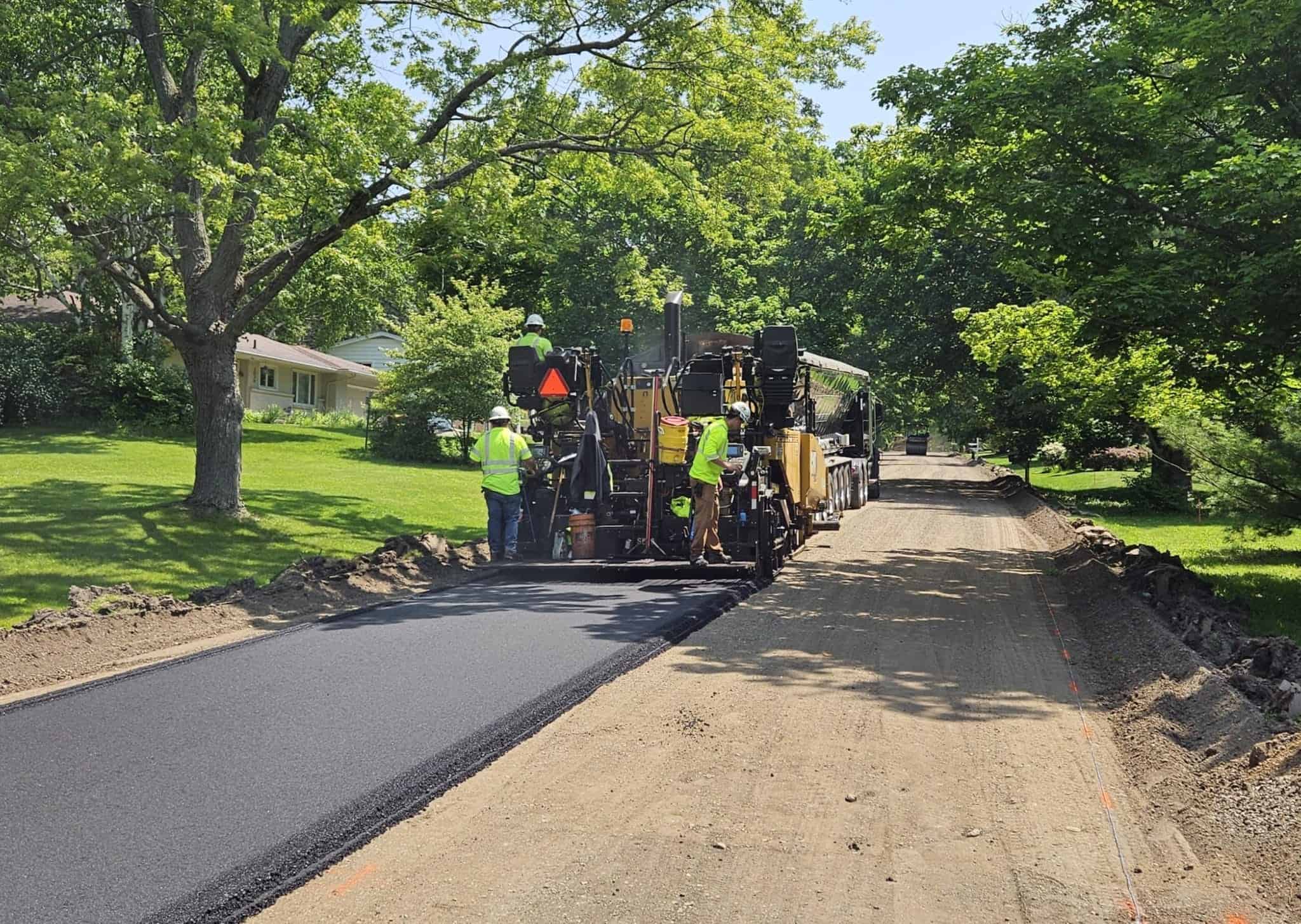

- Weather dependent, the Township’s contractor will be paving roads on May 31 and June 2-6. The roads with curb and gutter are likely to be paved first.
- Additional paving dates will be announced when they are scheduled.
- Saturday may 31st. the contractor may pave Yuma Trail in the late afternoon time permitting.
- Monday June 2nd the contractor will pave Yuma Trail if not completed on Saturday and will finish paving the remaining streets.
- June 3rd – June 6th the contractor will work on ditch clean out and culvert restoration.
Construction Update

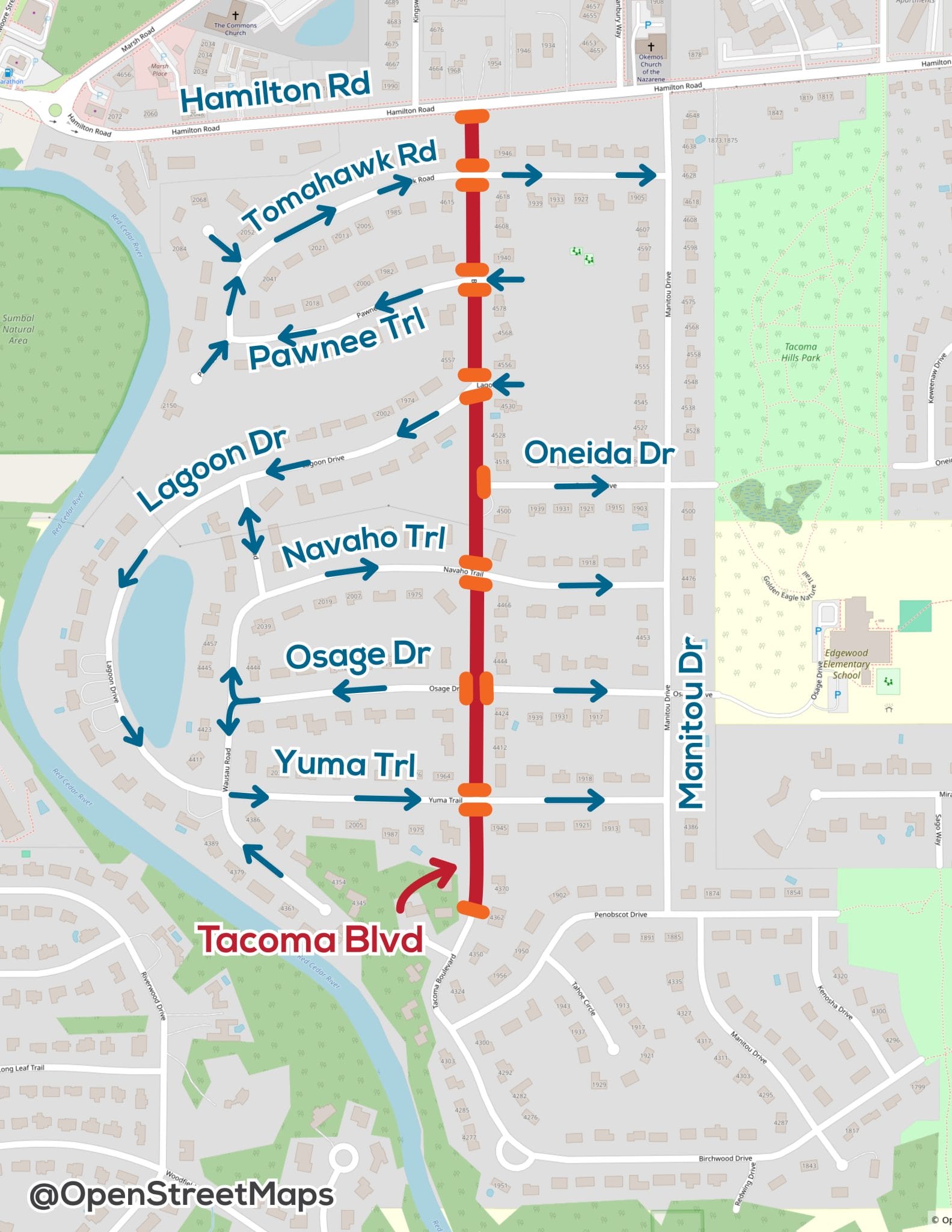

Tacoma Hills Update #3
- All storm sewer spot repairs have been completed.
- All curb and gutter spot repairs have been completed.

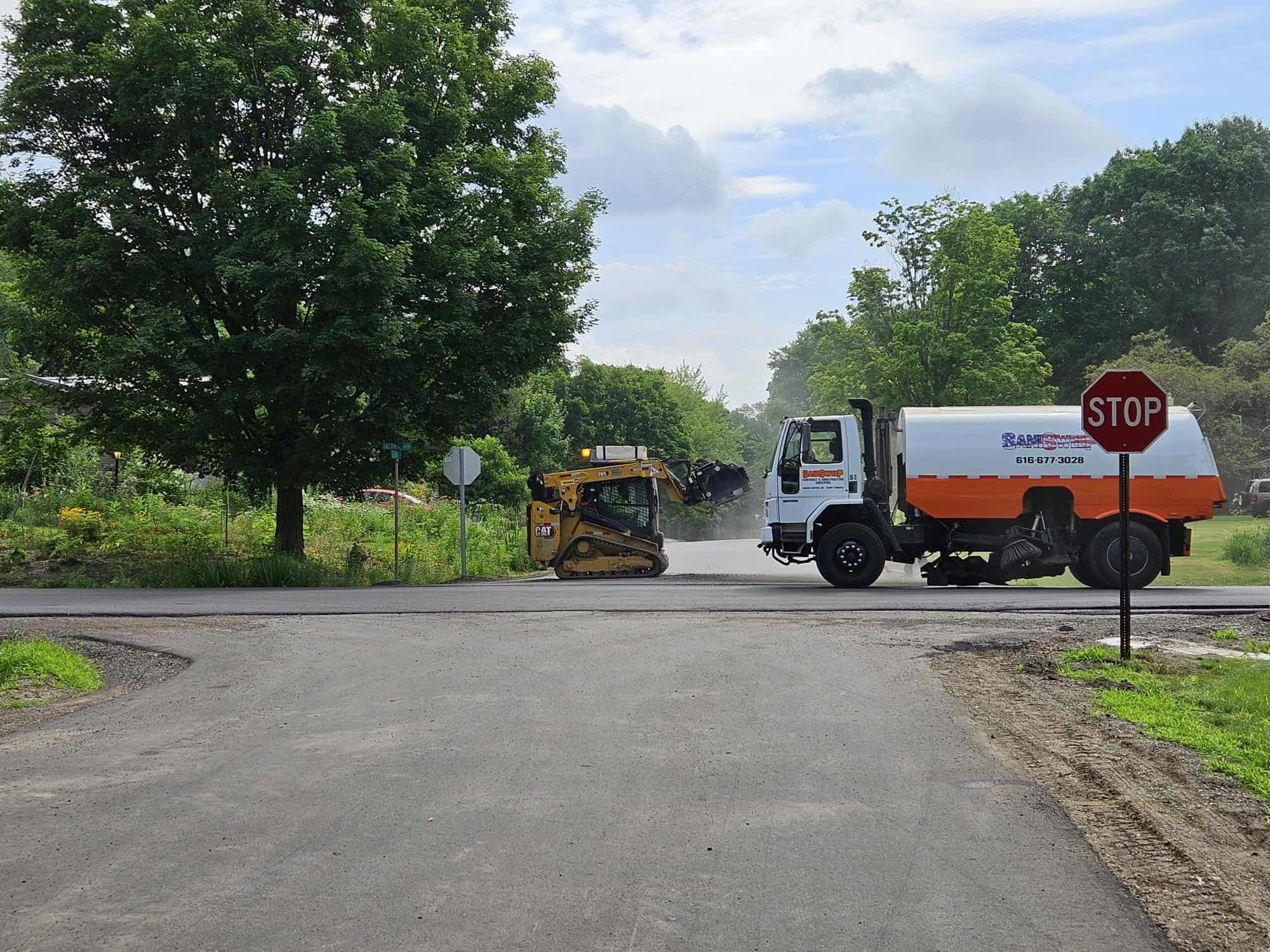

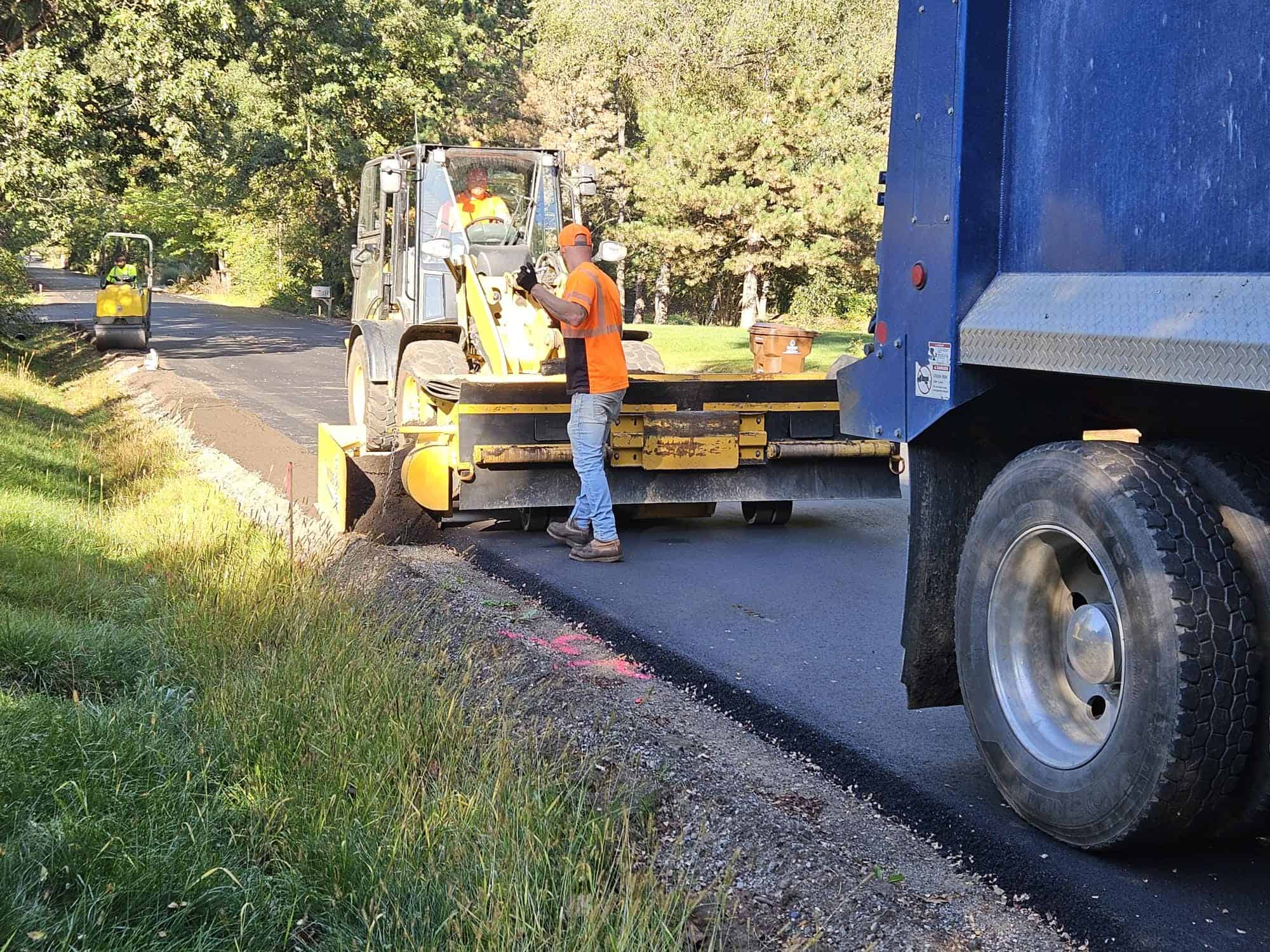

- For roads that do NOT have curb and gutter, the Township’s contractor continues to work on any necessary ditch clean out and culvert replacement work.
- Weather dependent, the Township’s contractor will be lowering manholes on curb and gutter roads on May 22 and 23.
- Weather dependent, the Township’s contractor is scheduled to crush the existing asphalt in place on roads that do NOT have curb and gutter.
- Weather dependent, the Township’s contractor will be milling (i.e. removing existing asphalt) from roads that have curb and gutter on May 29 and 30.
- The milling and crushing work typically moves past a given driveway in approximately 10 minutes, after which there is a rough gravel surface that you can drive on. The milling, crushing and paving work will be completed one lane at a time, thus the streets will be usable on at least one side at almost all times. An entire street is normally milled in one (1) day. Once the milling is finished, the first layer of new asphalt will be placed within 10 days.
- Weather dependent, the Township’s contractor will be paving roads from June 2-6. The roads with curb and gutter are likely to be paved first.
- Additional paving dates will be announced when they are scheduled.
Tacom Hills Update #2
Tacoma Hills Update
Consumers Energy Work
Construction Updates Coming Soon
Questions? We have answers
If you have any questions or concerns about the project, we are here for you. Our project manager is here to answer any of your questions. Feel free to email or call us at any time.
